electrical upgrades to code

The inspector was by today, looking at the work previously done and, thankfully, on the same permit, did a rough-in inspection.  He was quite an agreeable fellow, addressing all my questions.  So was Ryley, the electrician from Passey Electric.  He found some deficiencies.

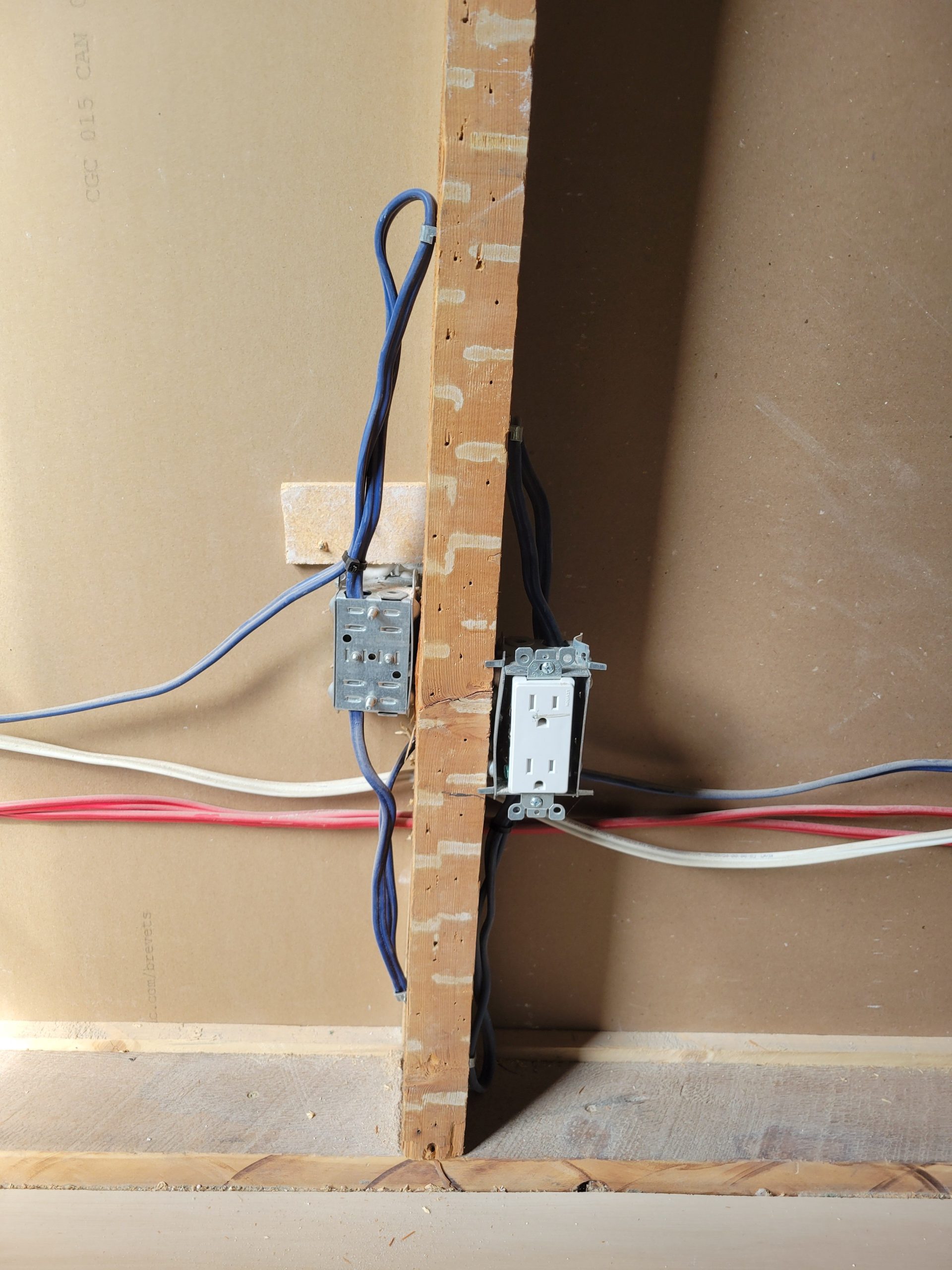

  • Sep 11/2026 10:10AM (KEN) ROUGH IN: Range box and dryer box needs to have a second support. KF
  • Sep 11/2026 10:11AM (KEN) ROUGH IN: Plug in kitchen area should be taken out on opposite side of panel. KF

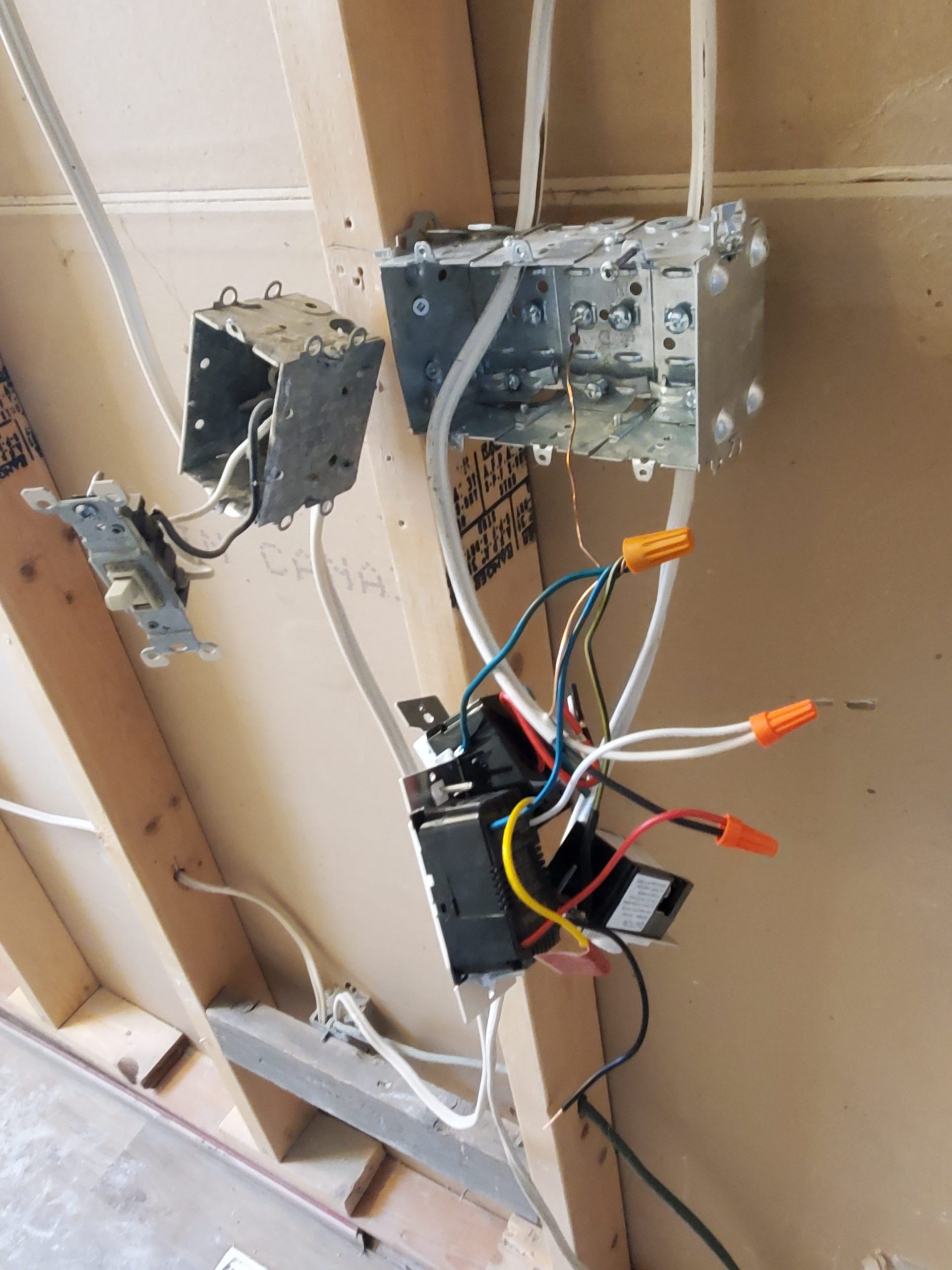

  • Sep 11/2026 10:13AM (KEN) ROUGH IN: Rough in of the upper unit was inspected with noted deficiencies. KF

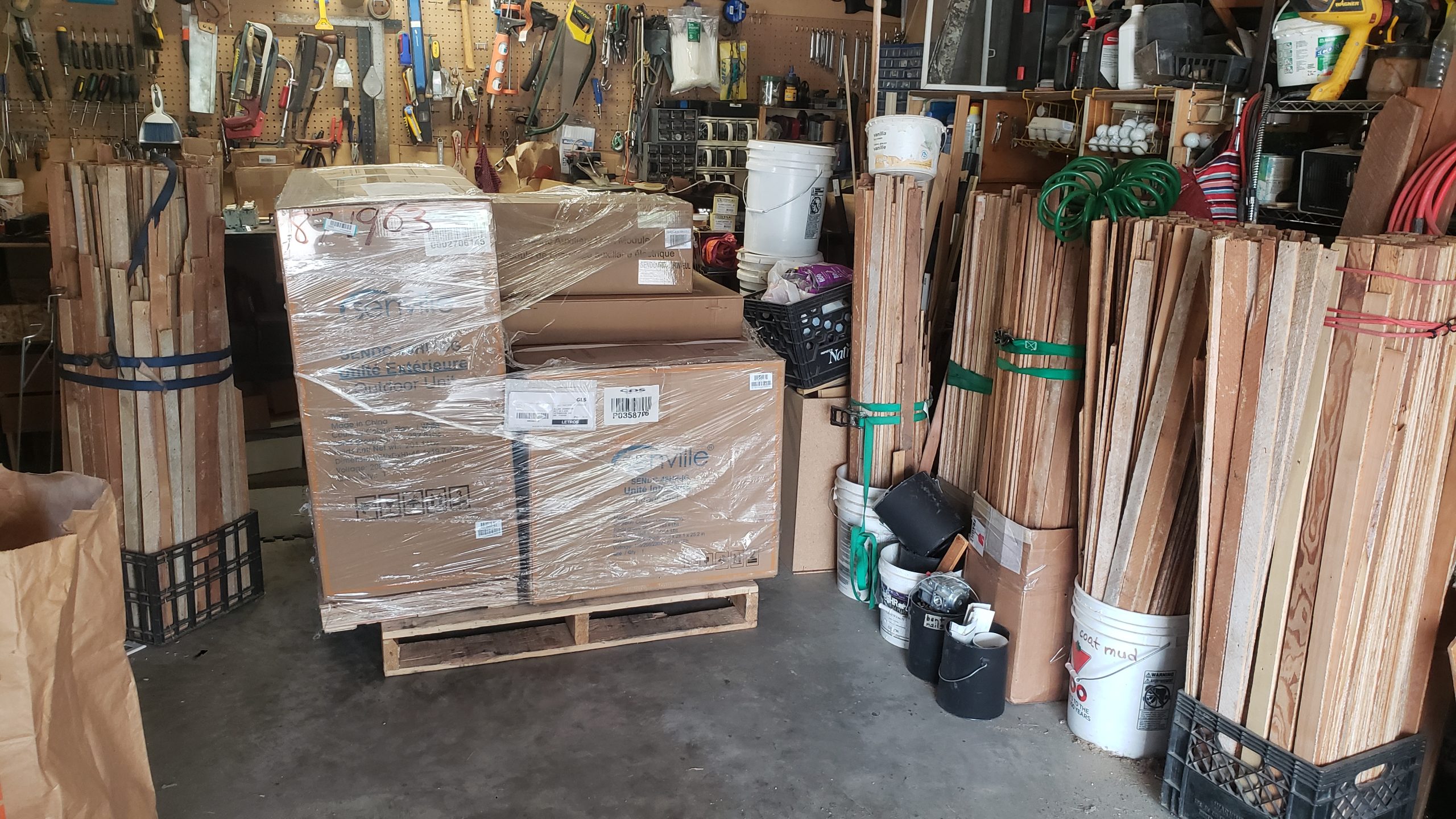

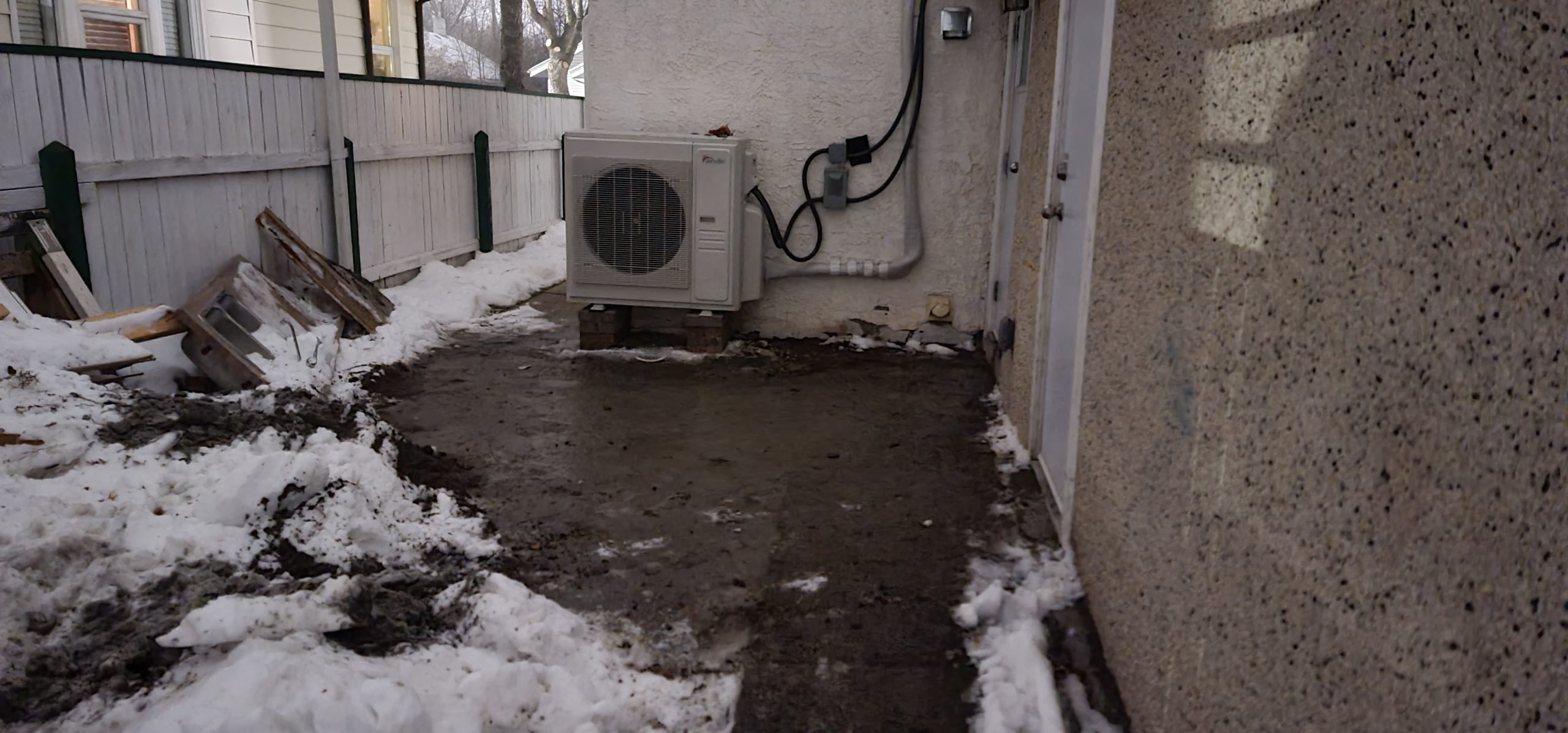

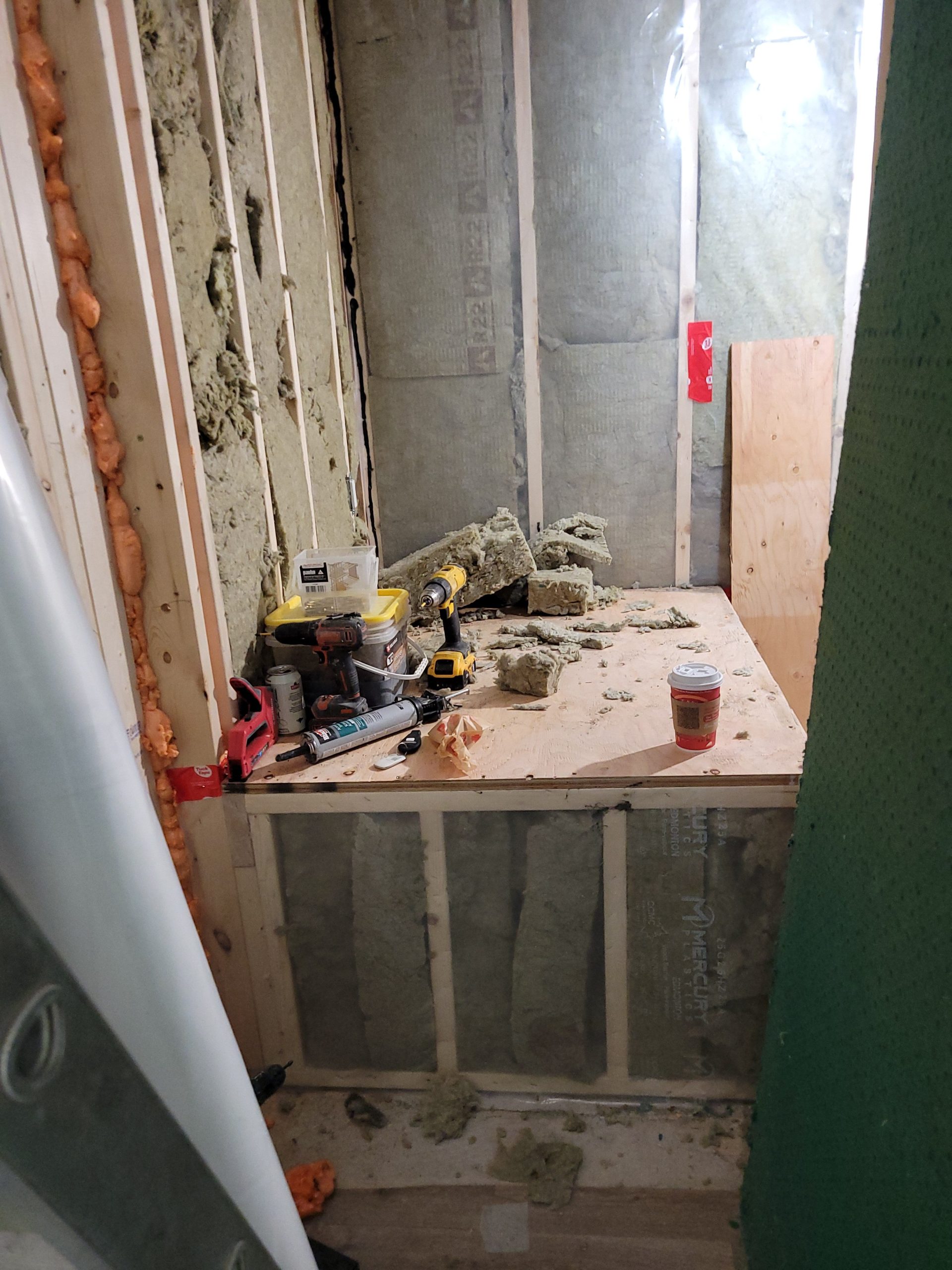

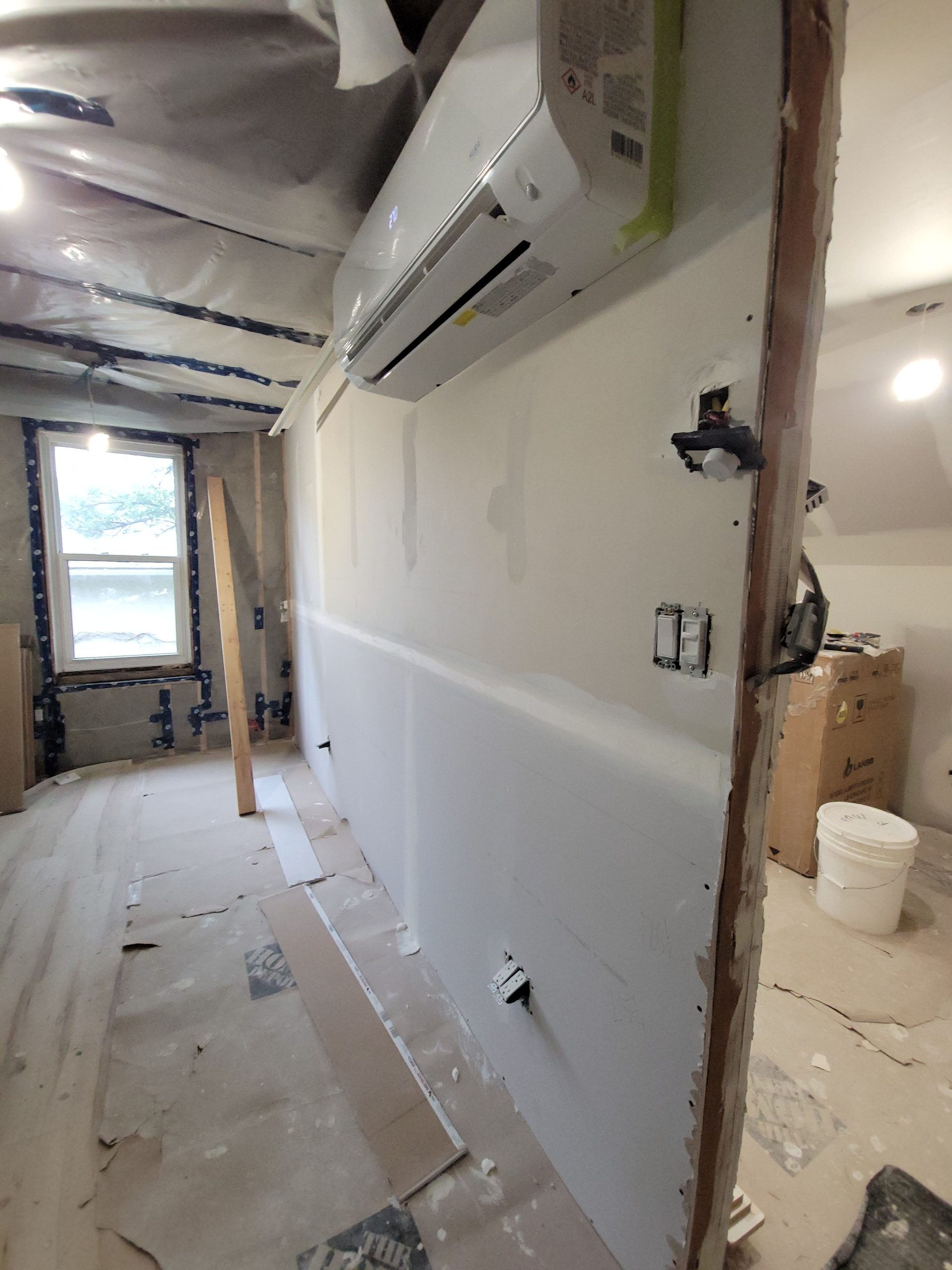

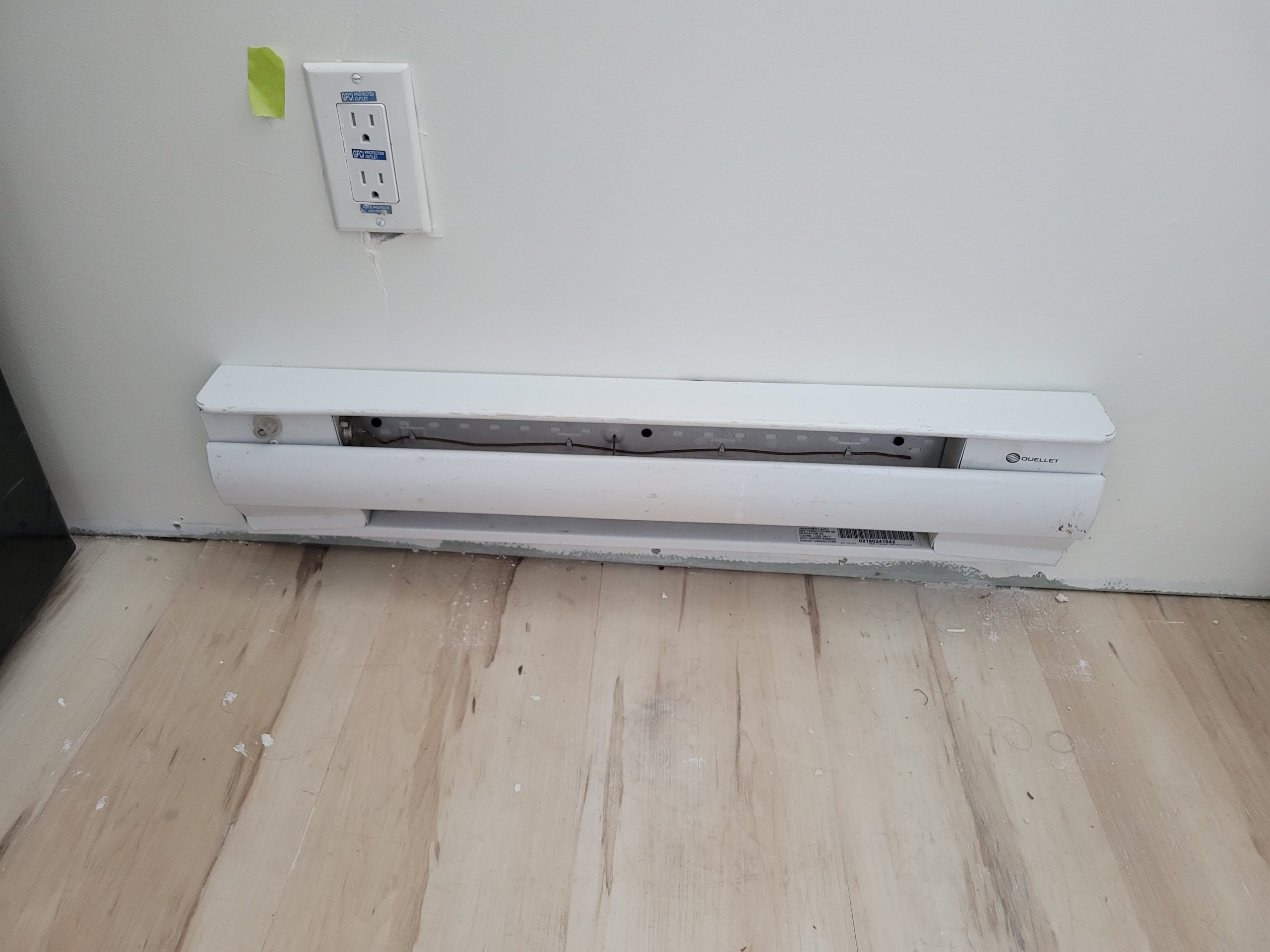

  • Sep 11/2026 10:15AM (KEN) ROUGH IN: 3 heat pumps and 2 baseboard heaters are being installed. KF

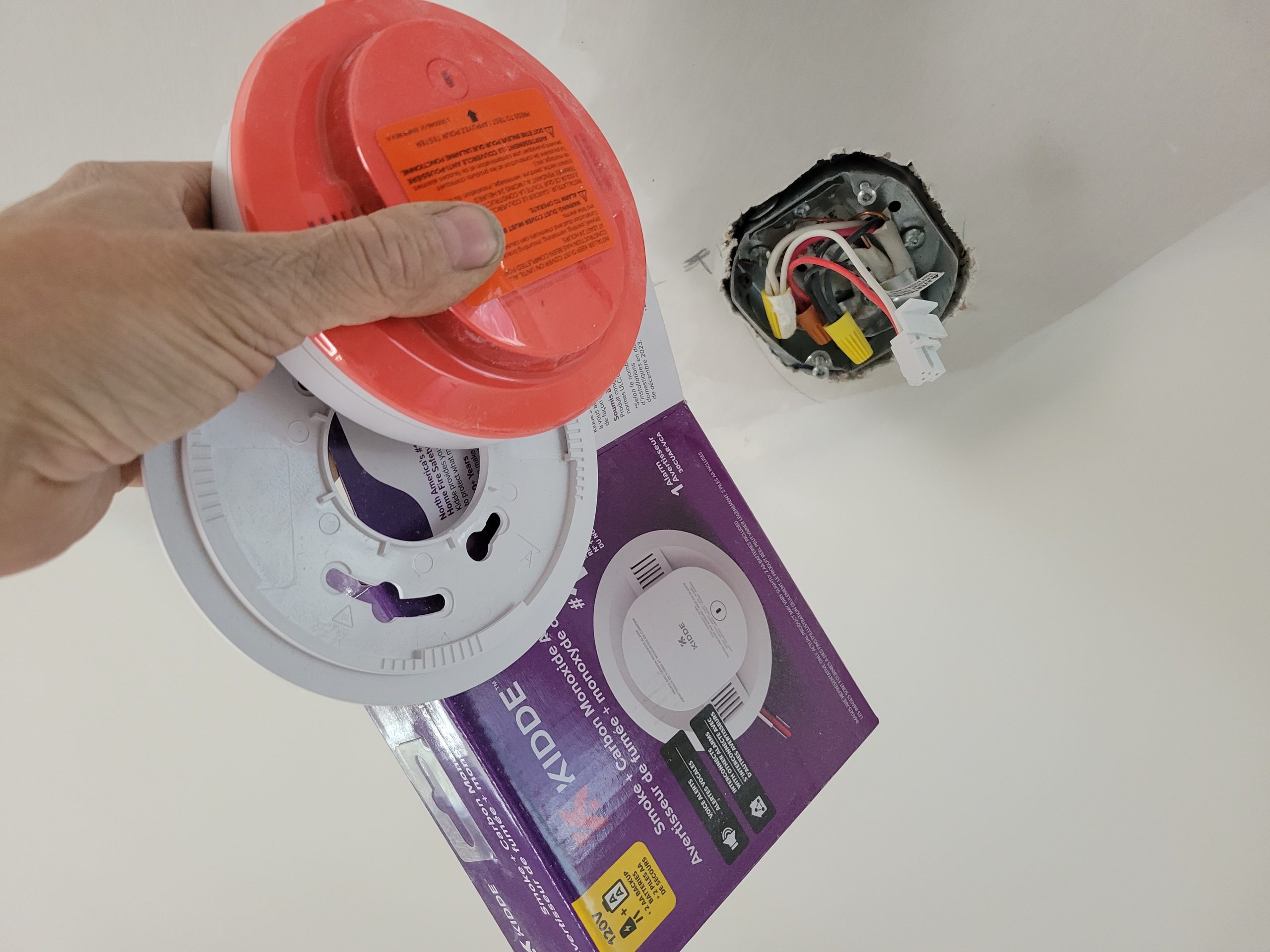

  • Sep 11/2026 10:16AM (KEN) ROUGH IN: Fire alarm cable going downstairs to be completed. KF
  • Sep 11/2026 10:05AM (KEN) ROUGH IN: DEFICIENCY: Rule 12-3010 (2) – Gangable boxes require a second support between studs ( could be factory boxes2 gang)

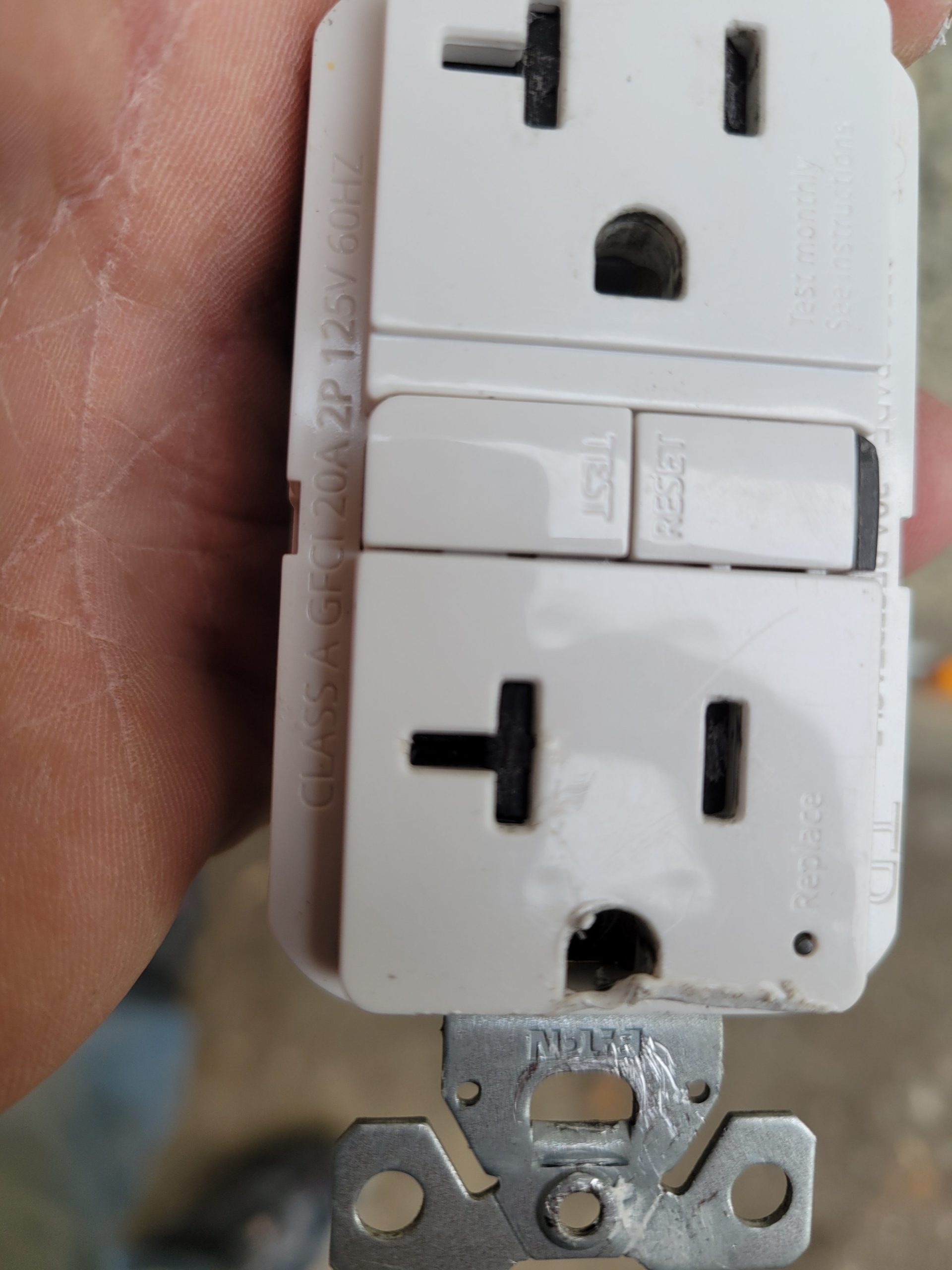

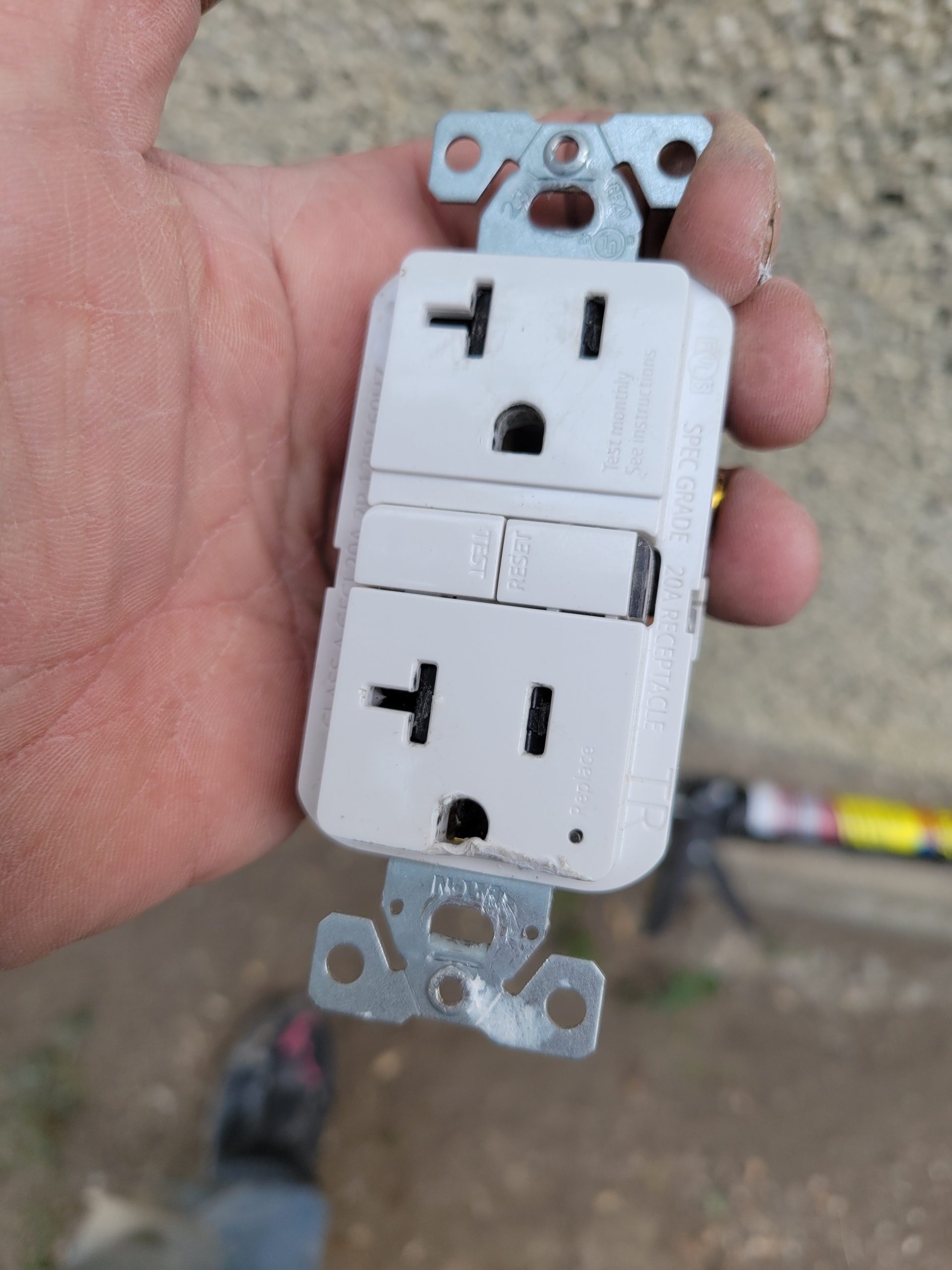

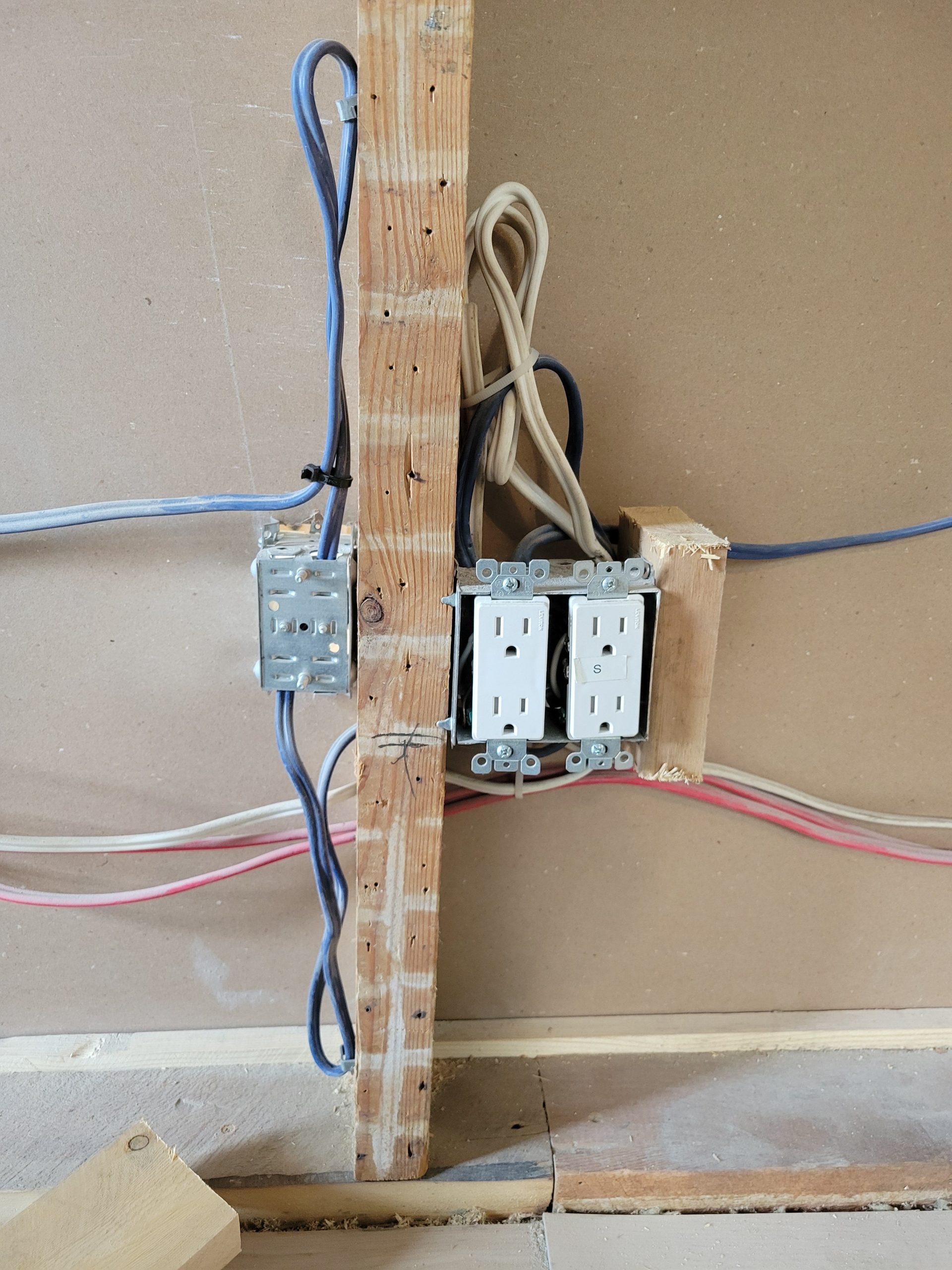

  • Sep 11/2026 9:58AM (KEN) ROUGH IN: DEFICIENCY: Rule 12-516 – Protection plates required where wire is run less than 32 mm from edge of stud (throughout)

Along with that…

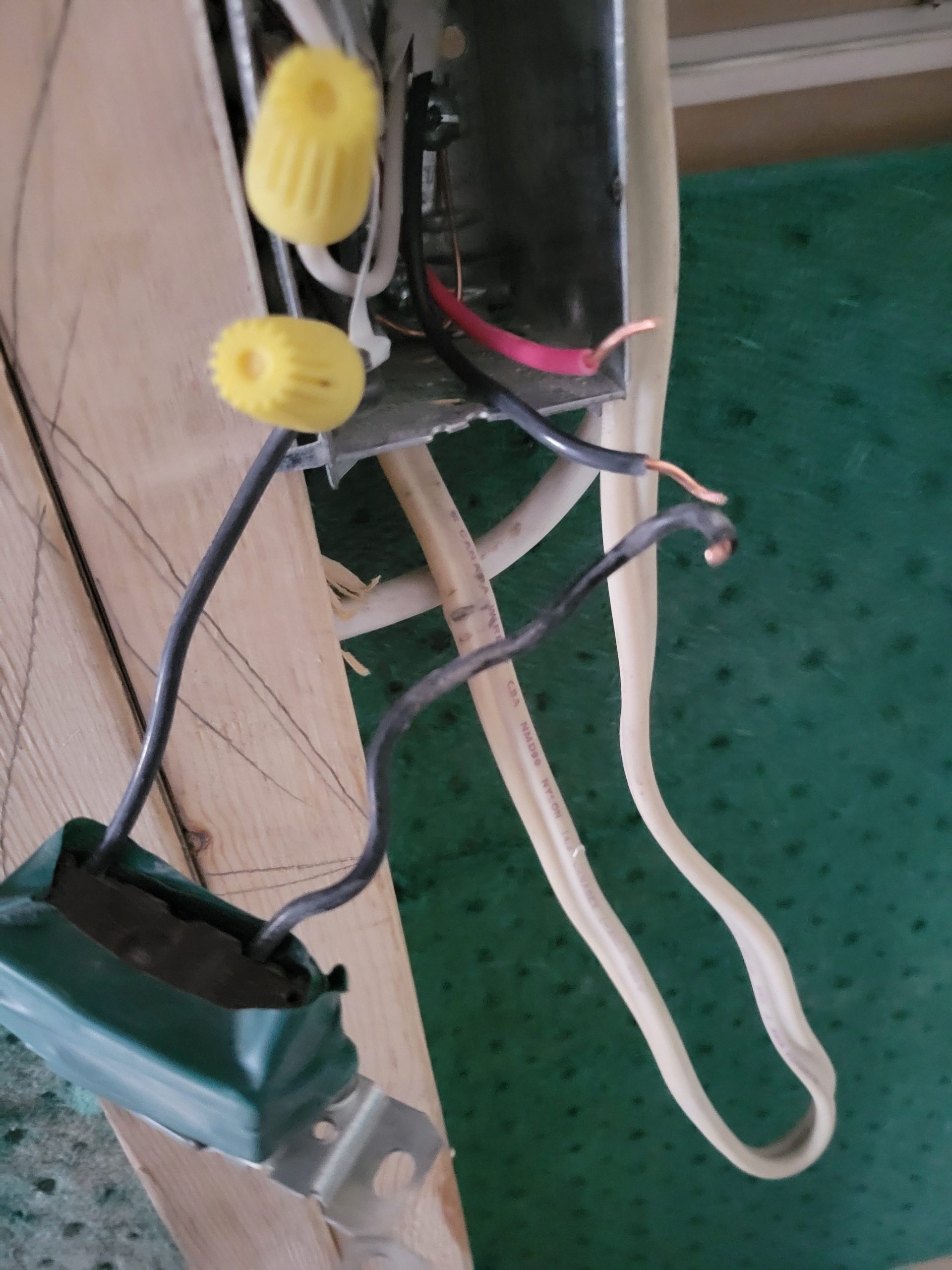

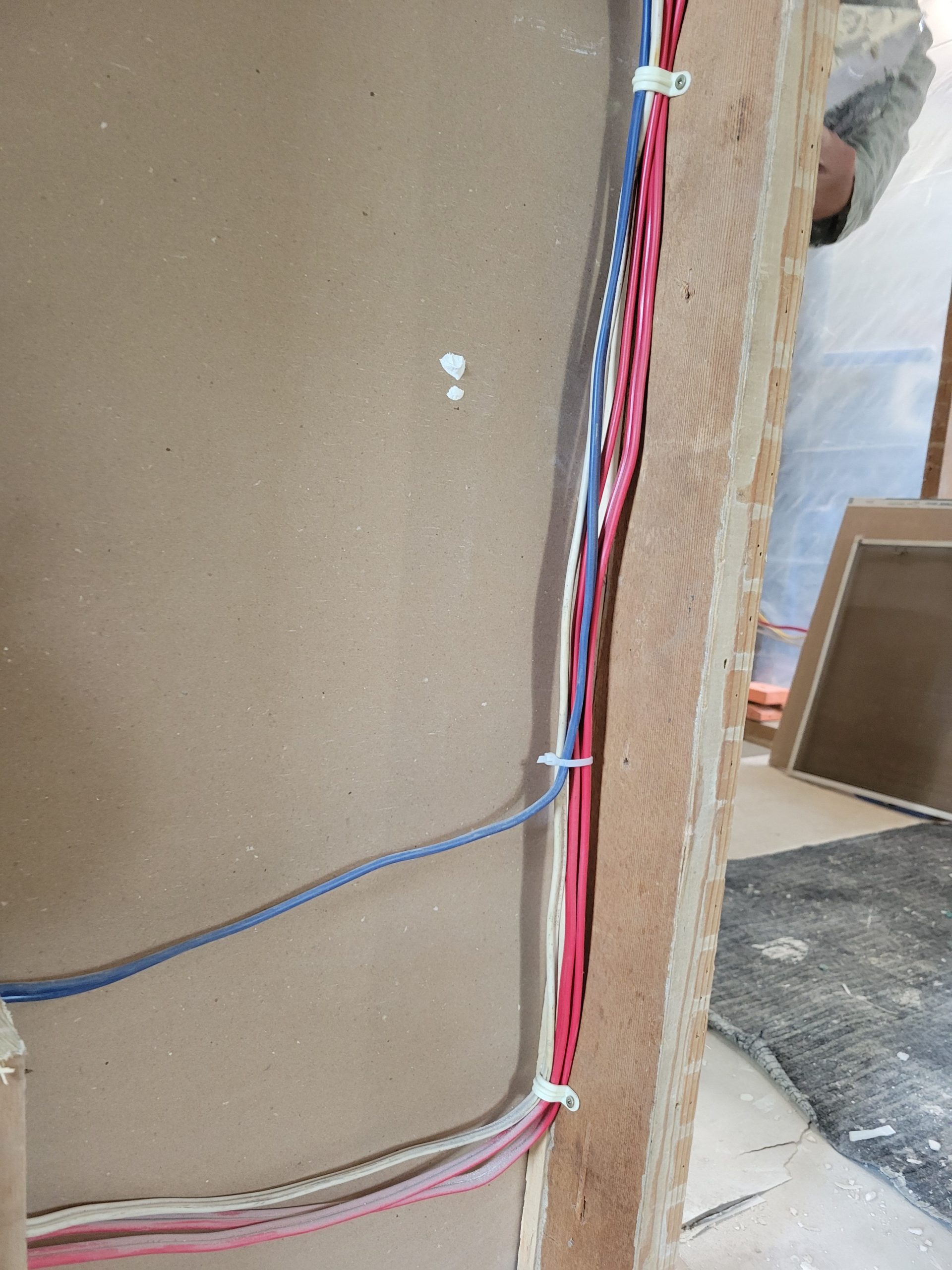

  • The 15-15A space-saver breaker I put in for the split simplex outlet was wrong.  Each circuit must be on a different phase, the reason being that the neutral wire would handle 15 amps for each circuit, amounting in 30 amps.  I thought about this a few days ago and wondered how that worked.  It never occurred to me that I need a 2-pole breaker with each circuit on a different phase.  Again, Ryley is a helpful fellow.

Some of the work was done yesterday and some today.

So, here goes!

Read more

lumber in the wind

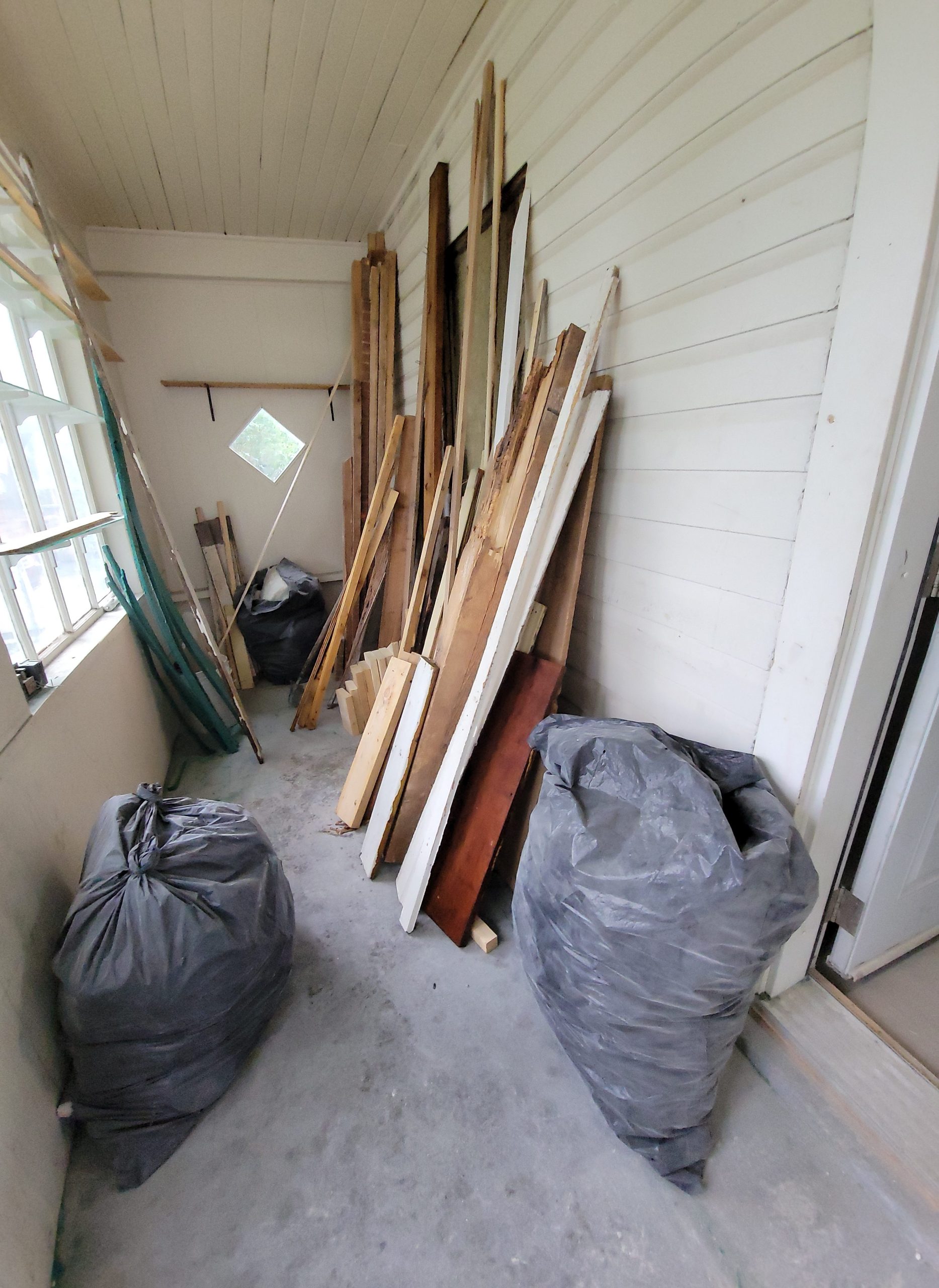

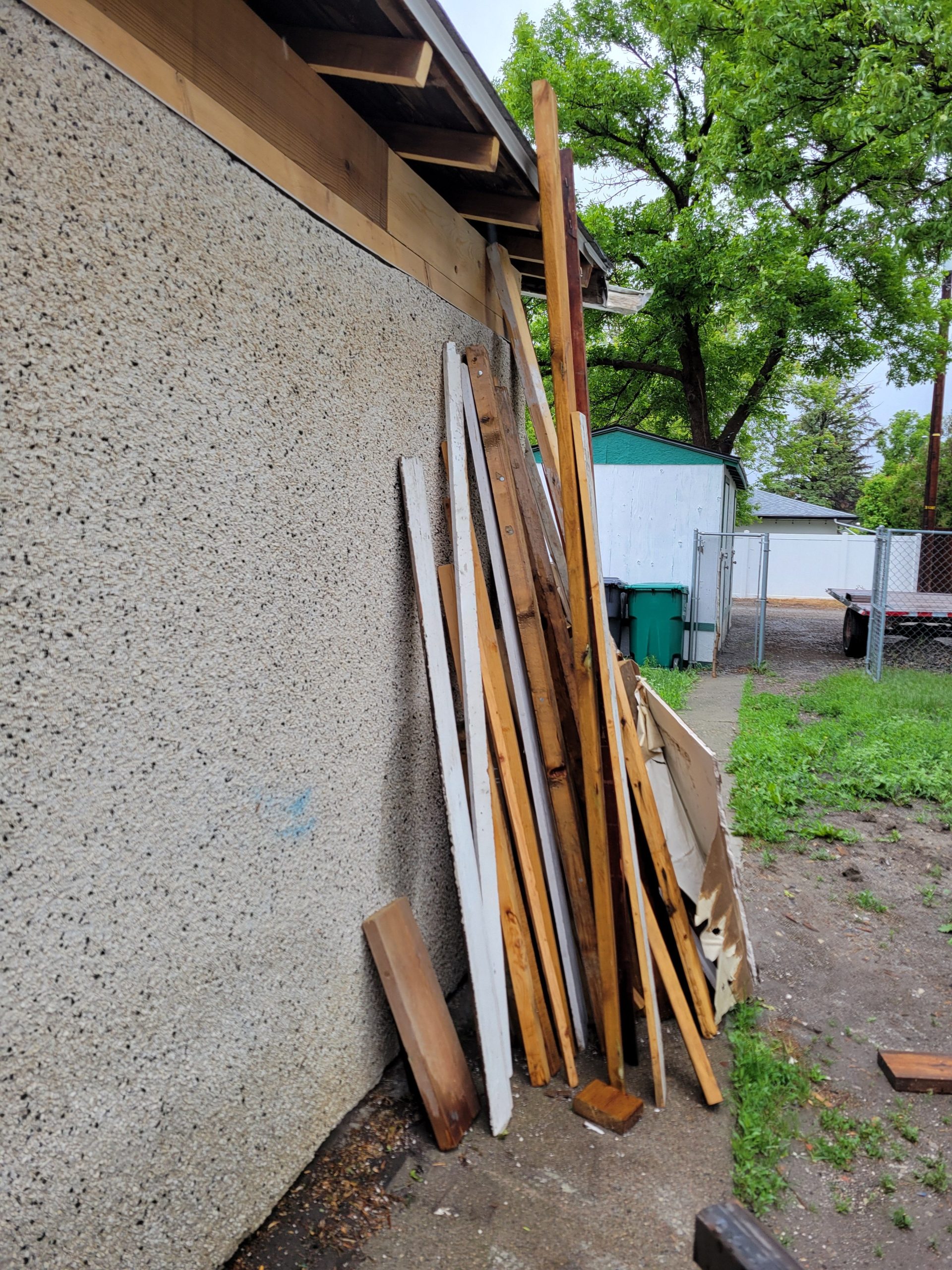

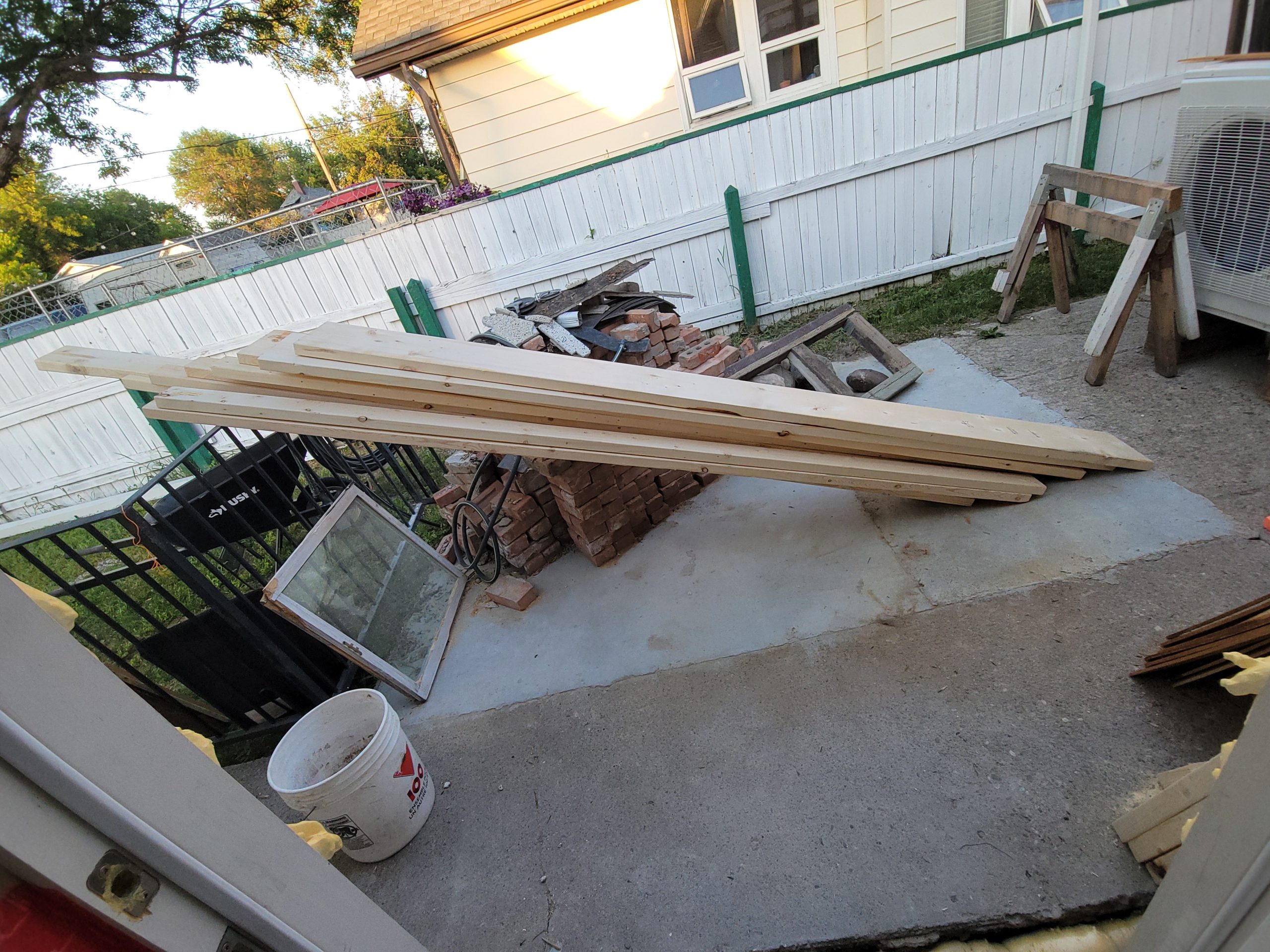

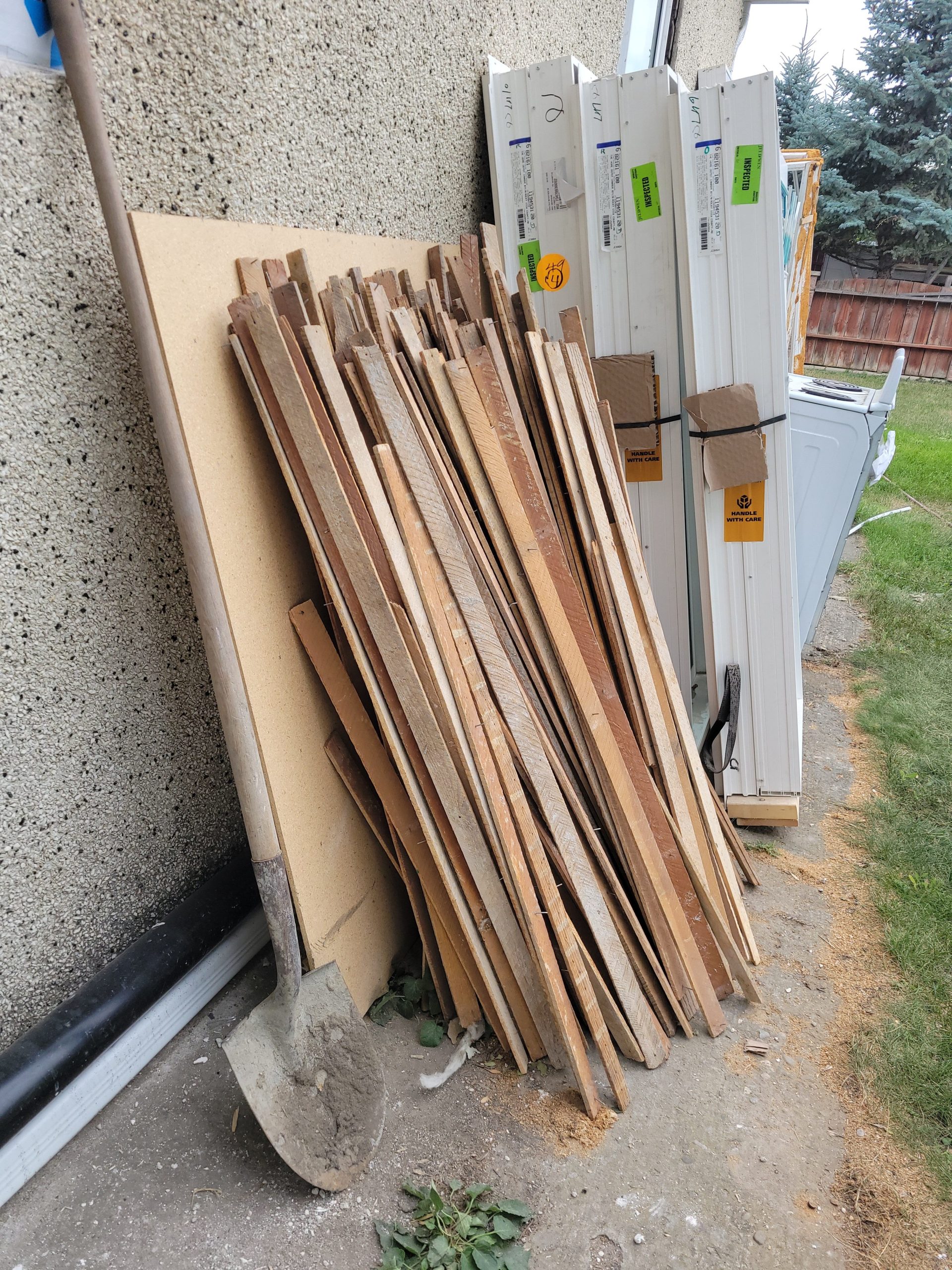

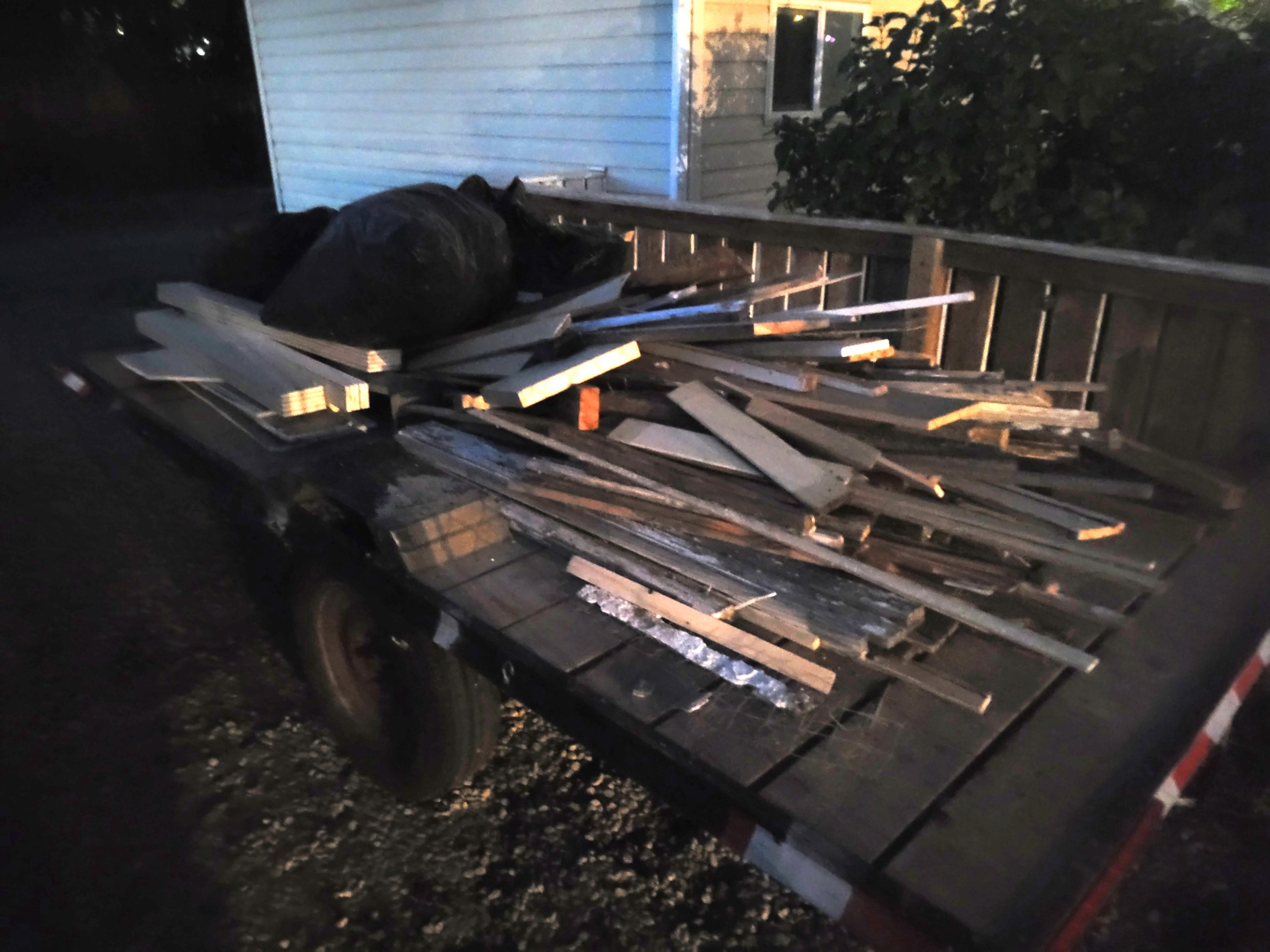

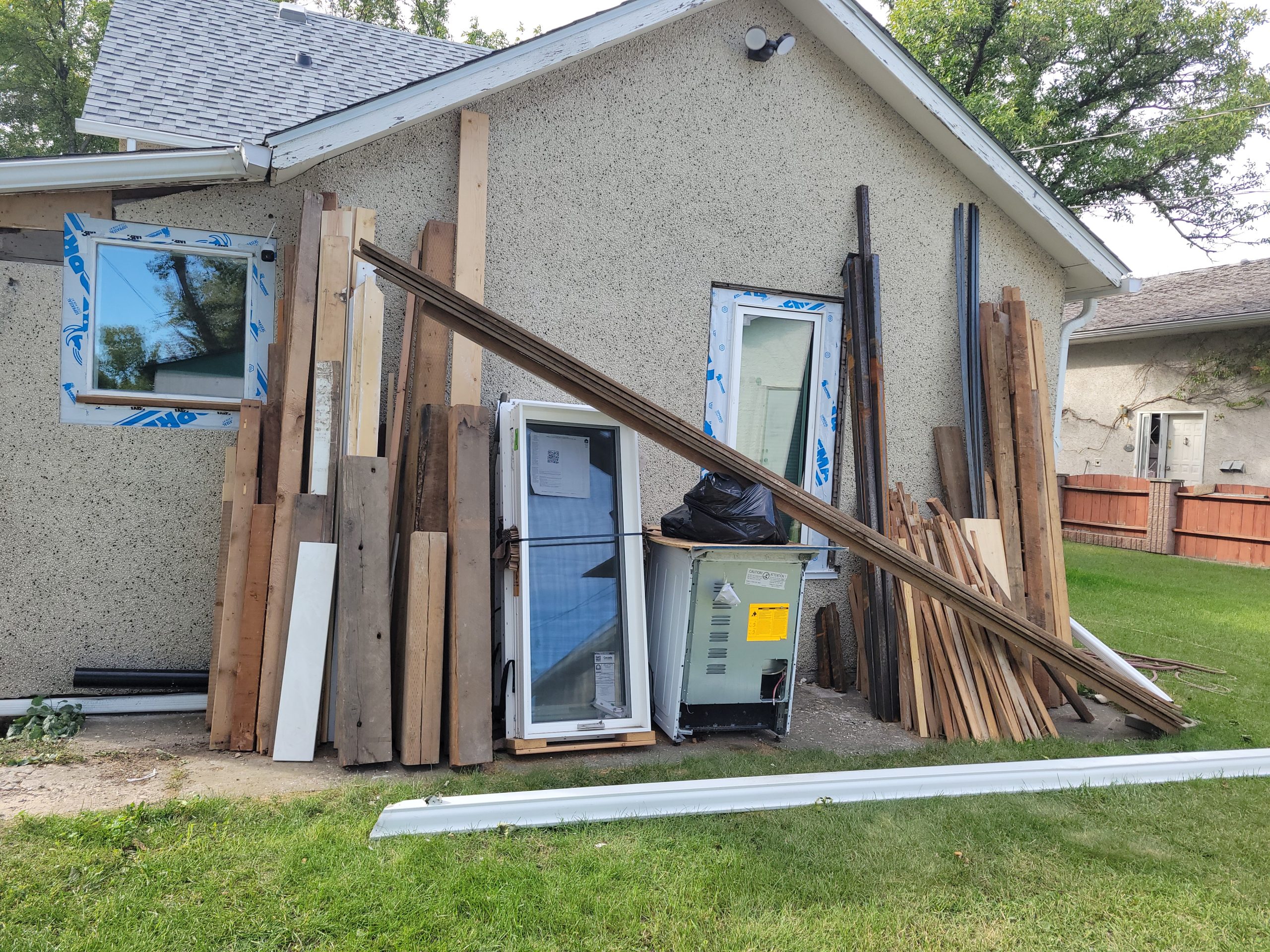

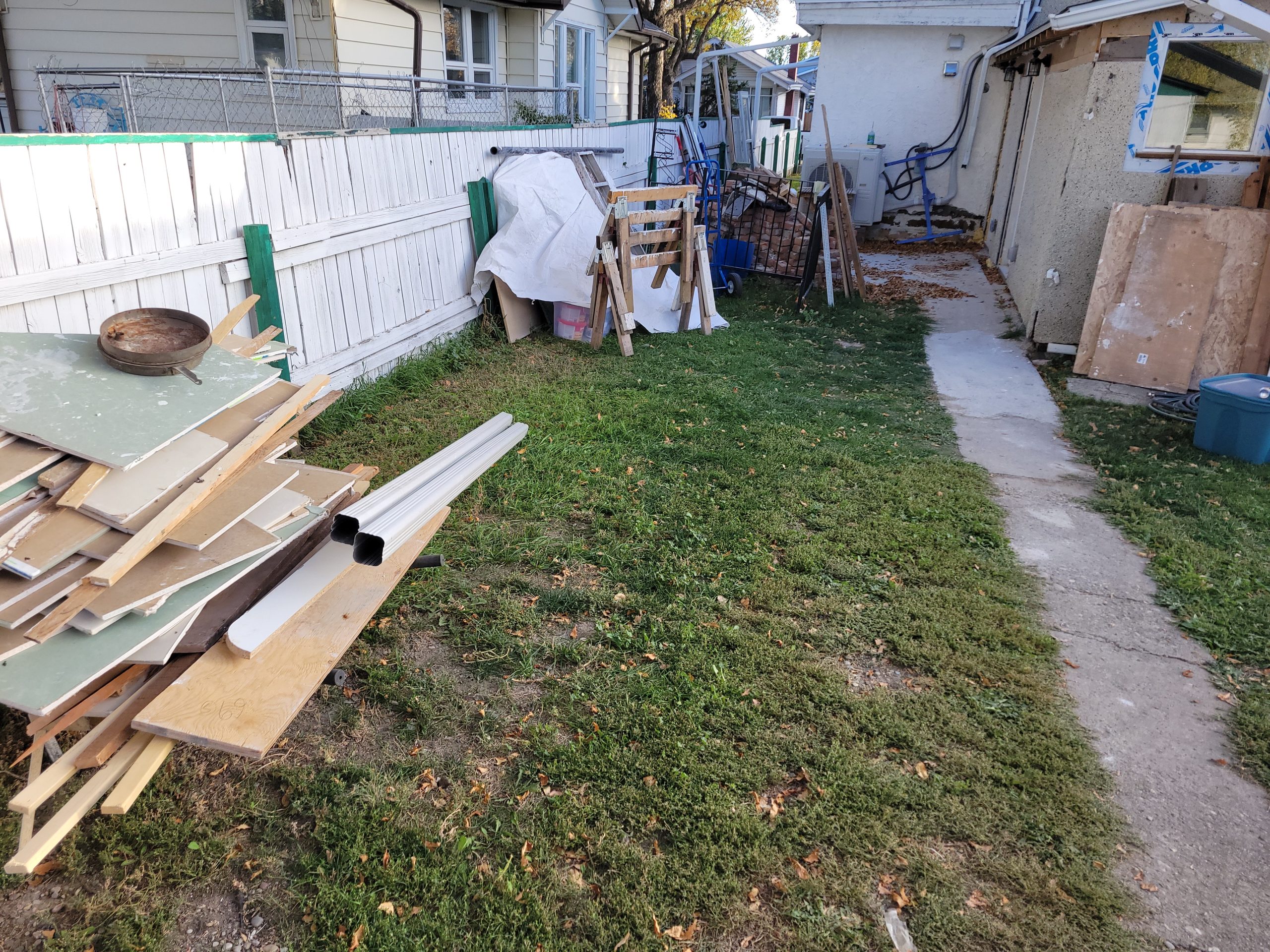

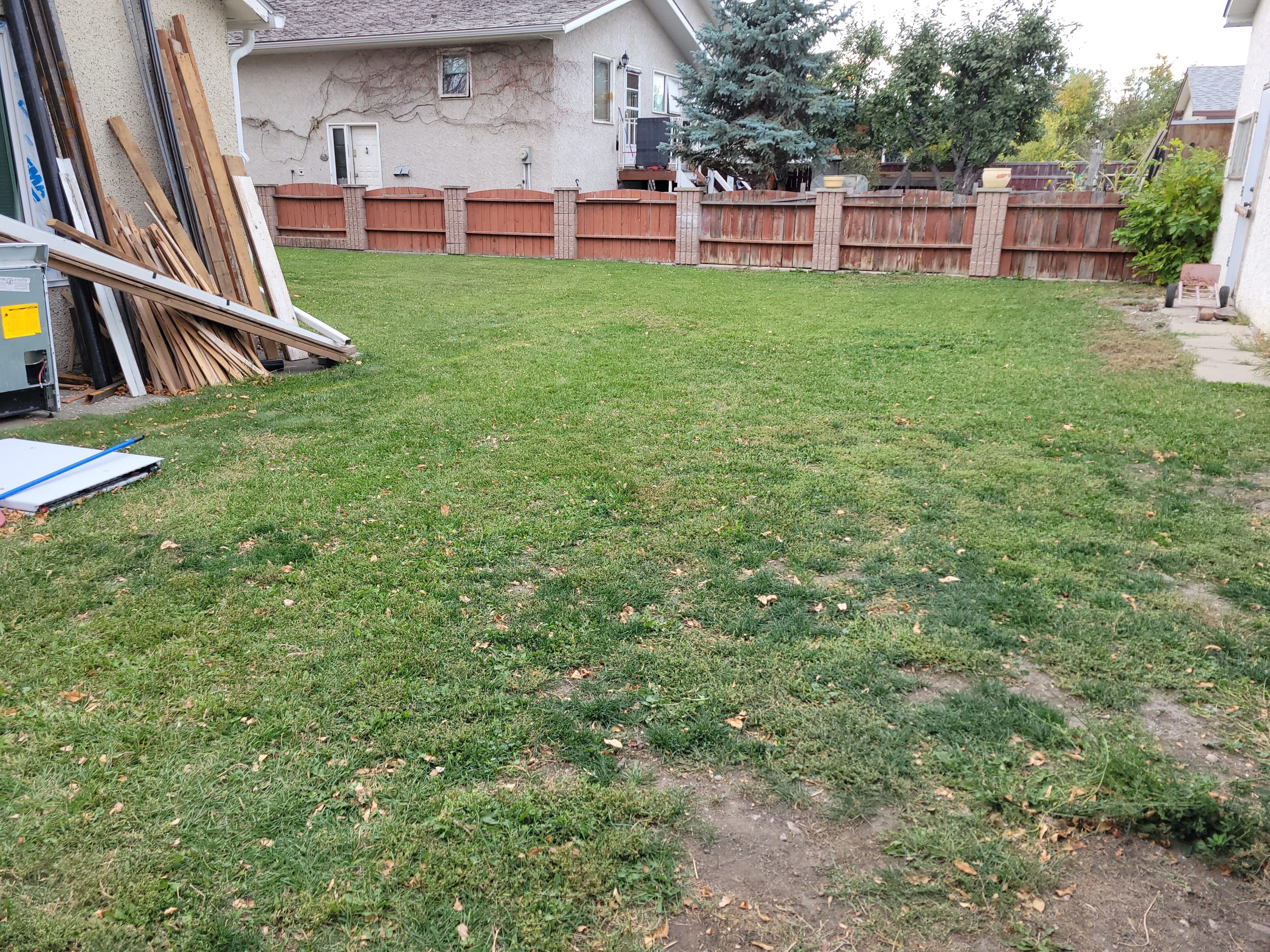

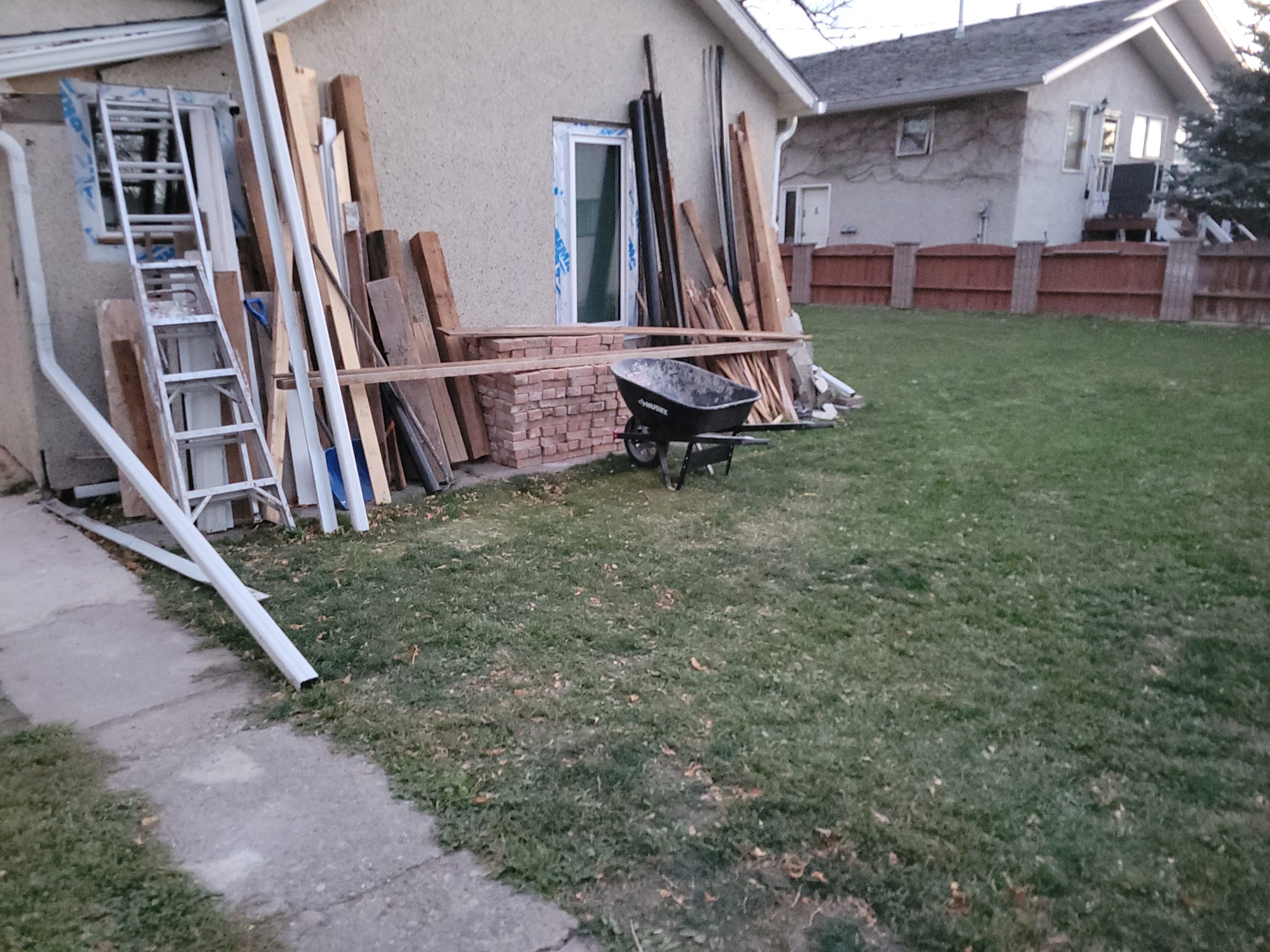

The lumber we stacked at the rear of the property did not blow down.  It was really windy last night.  I was expecting to see them stacked randomly like a bunch of t’an in a game of Kal’toh gone wrong.

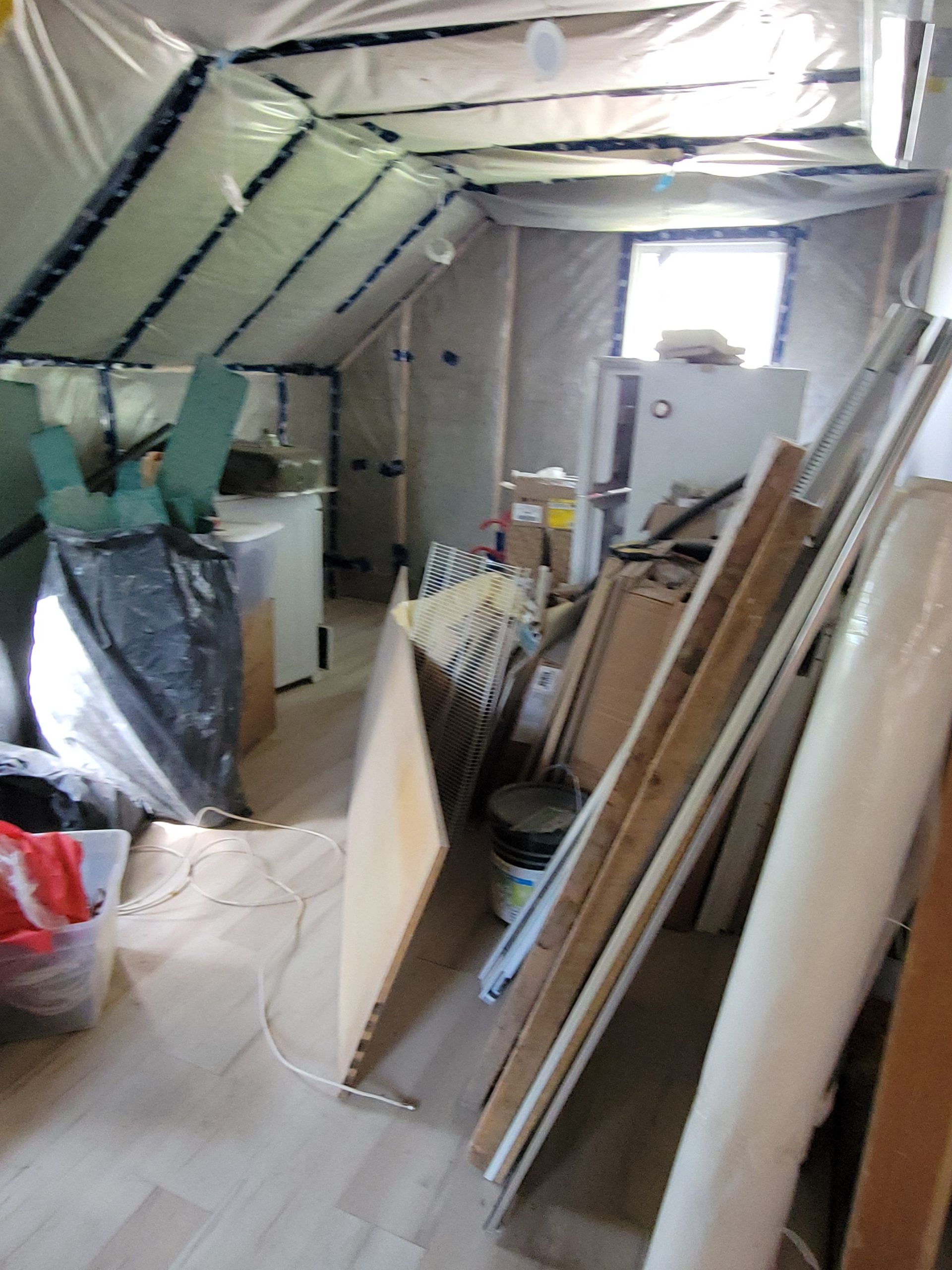

2nd floor work begins

The second floor is rented for Sept. 31, 2026.  I’d best get a move-on.

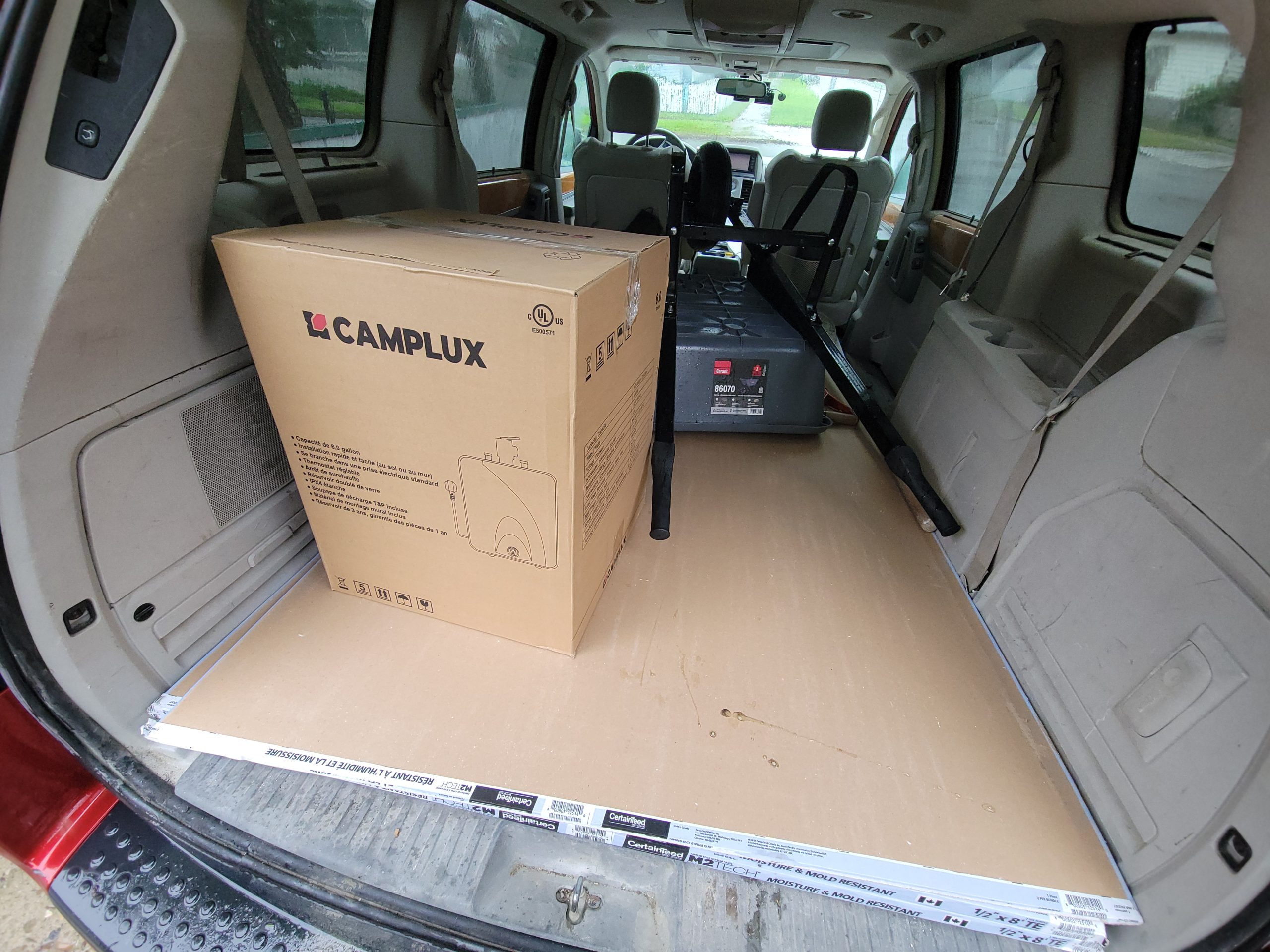

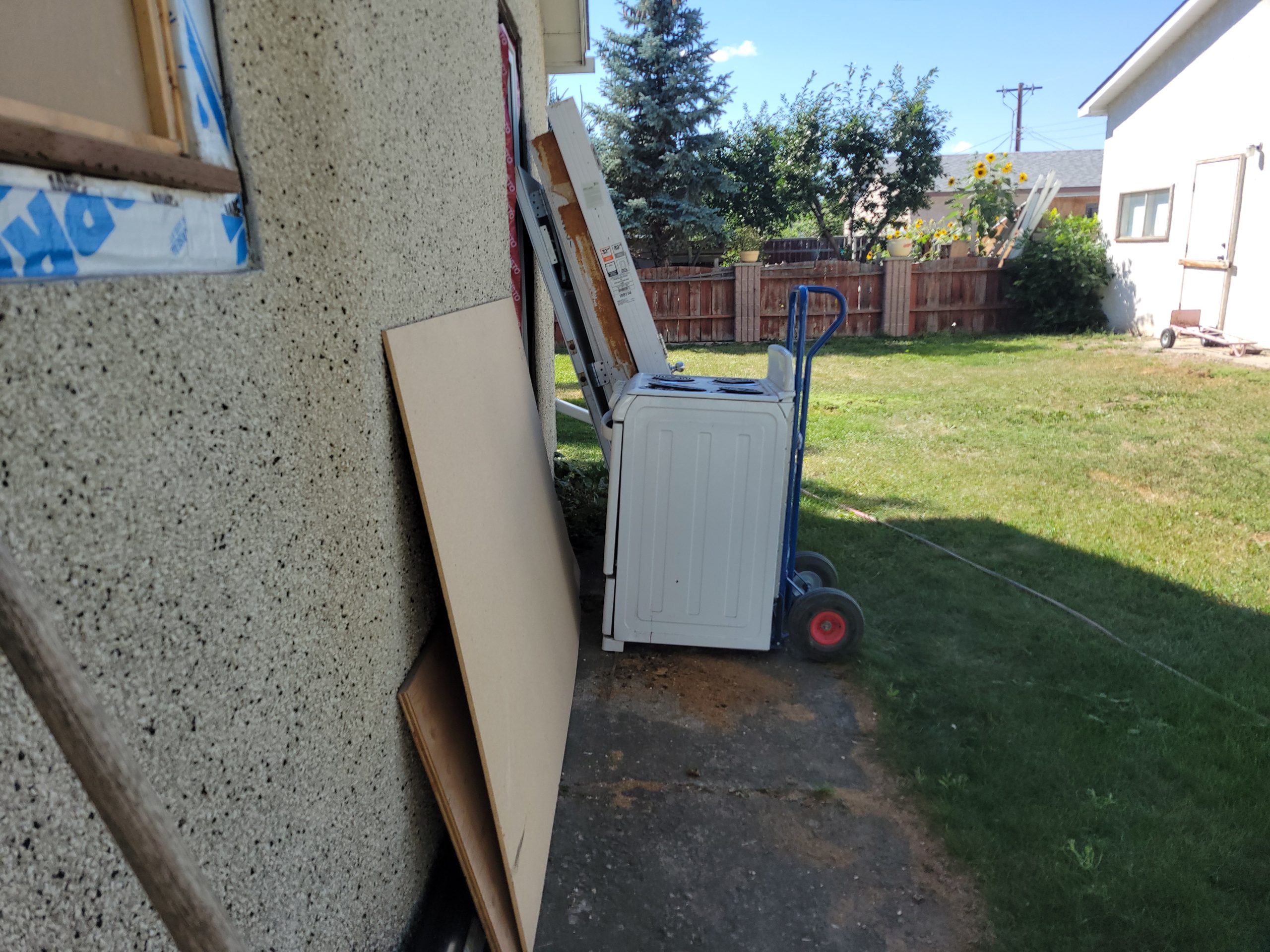

I priced out a water heater from Home Depot.  I think it may be too tall.  I’ll have to think on it.

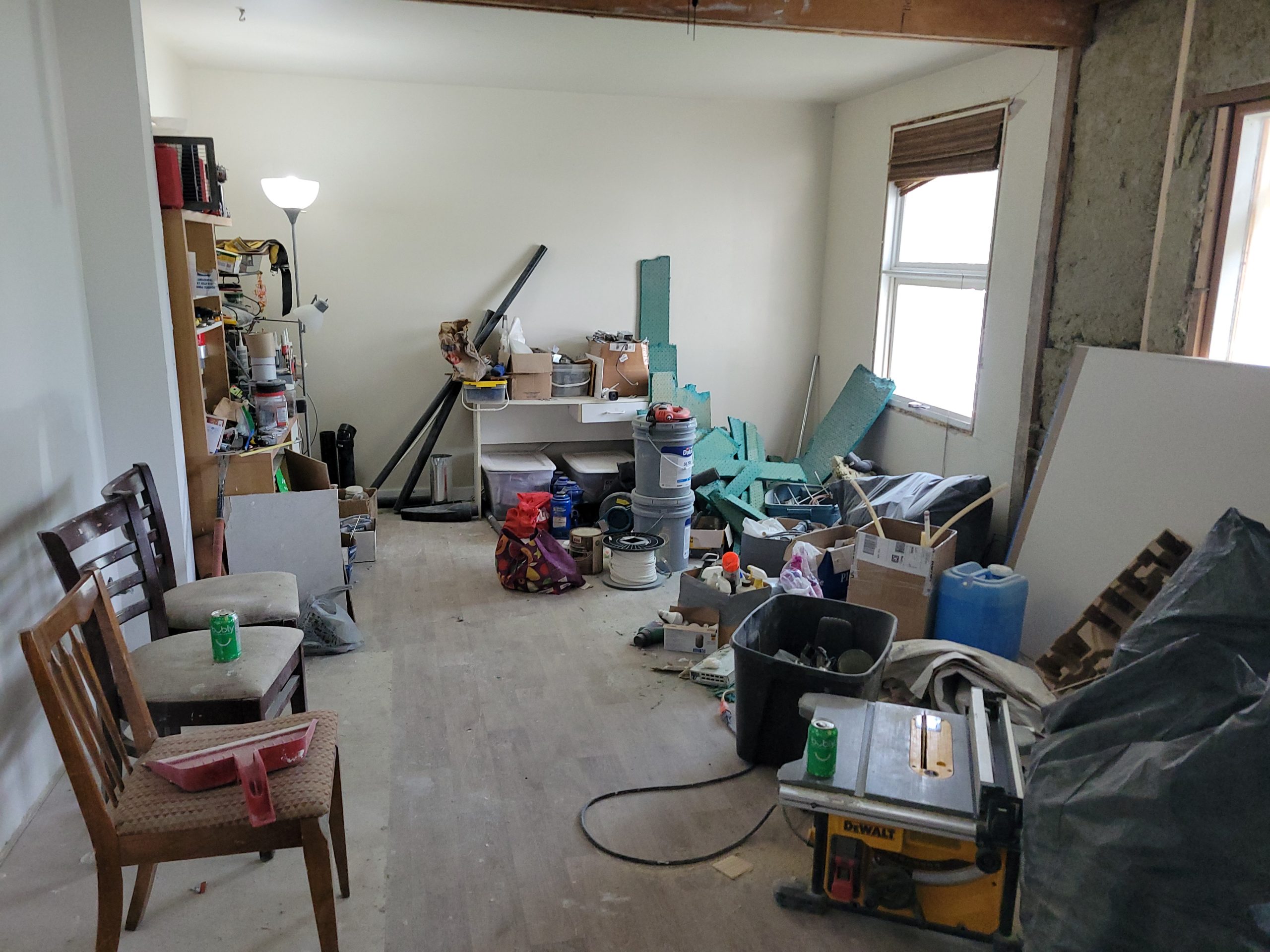

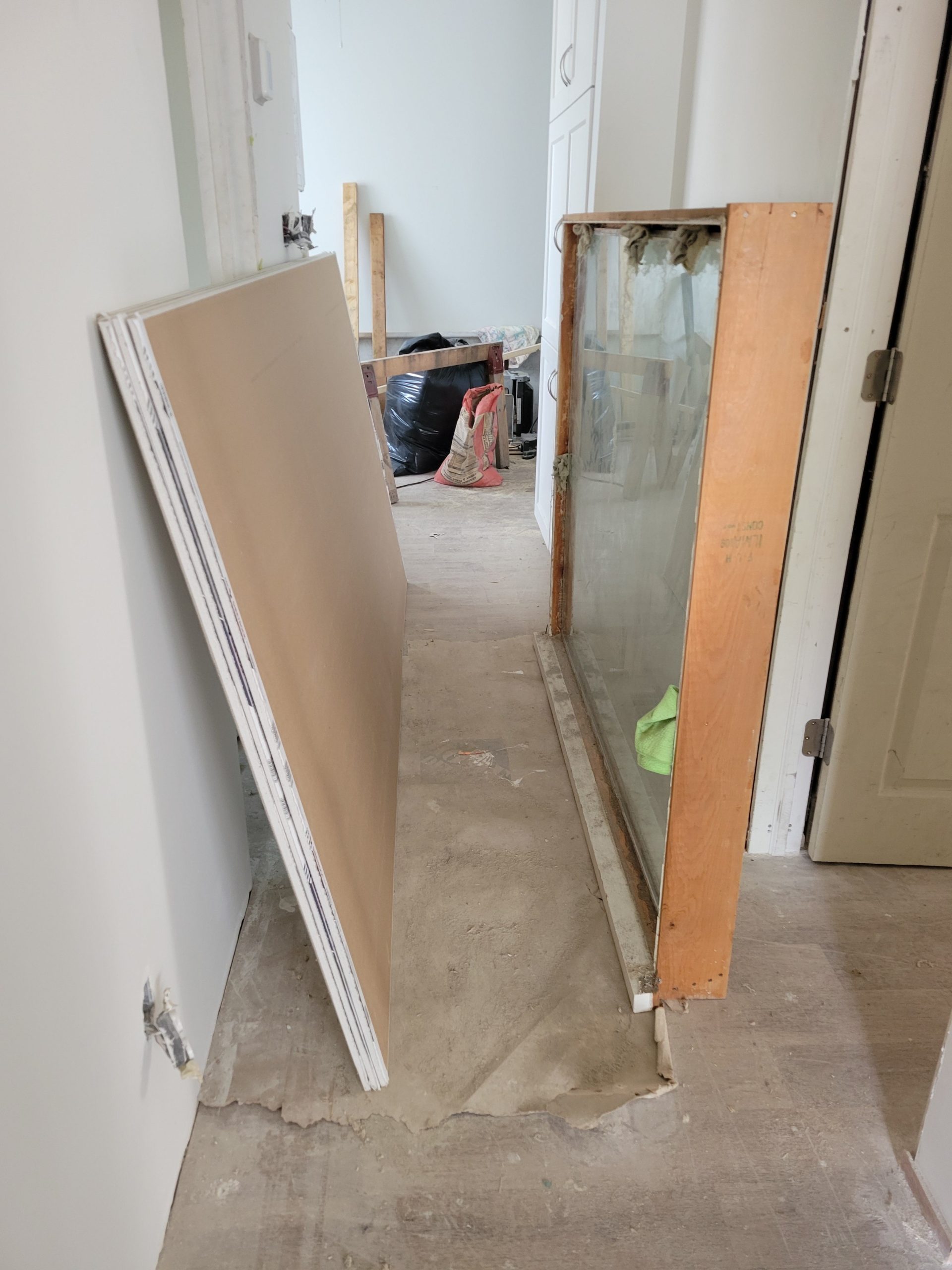

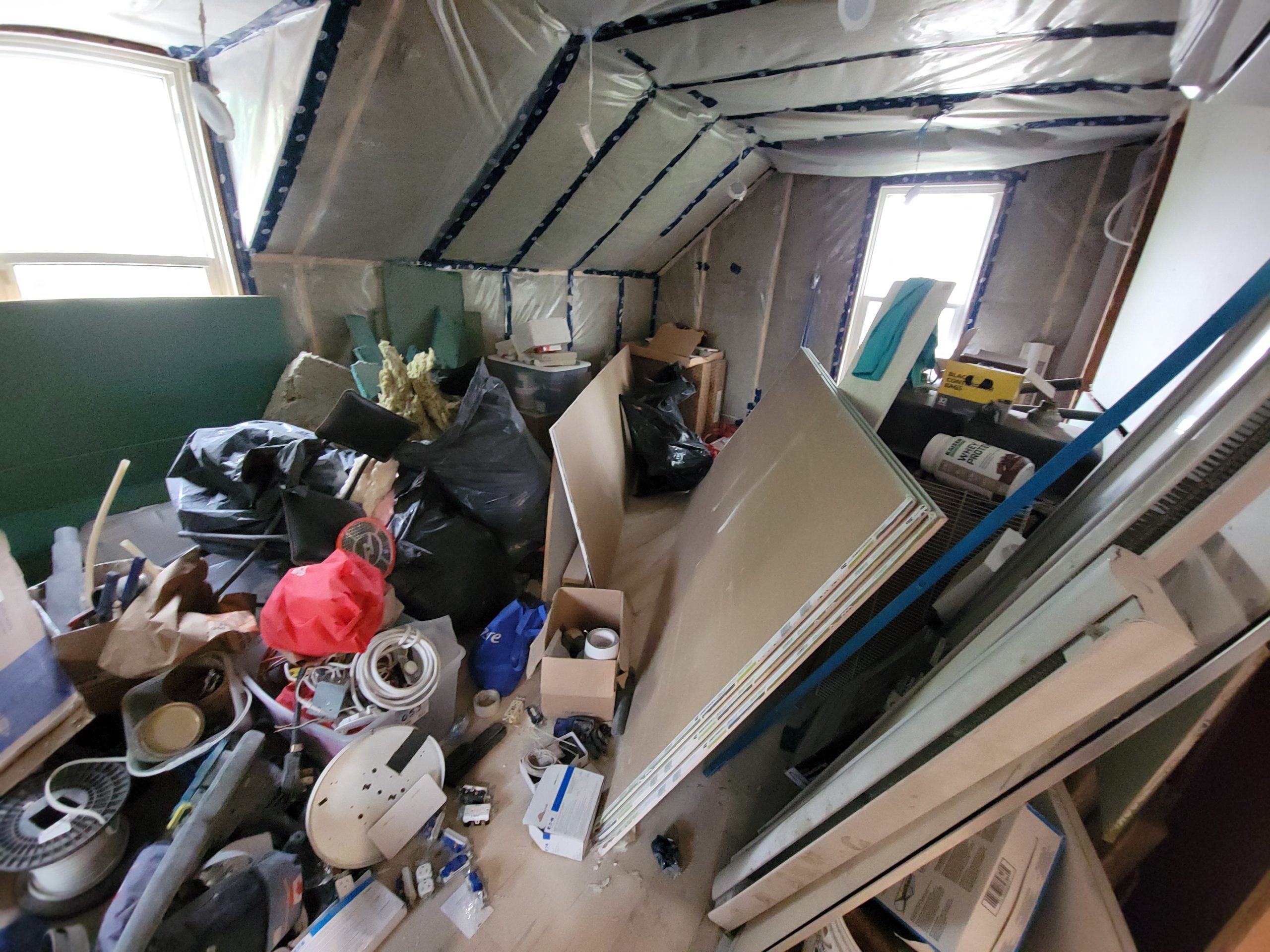

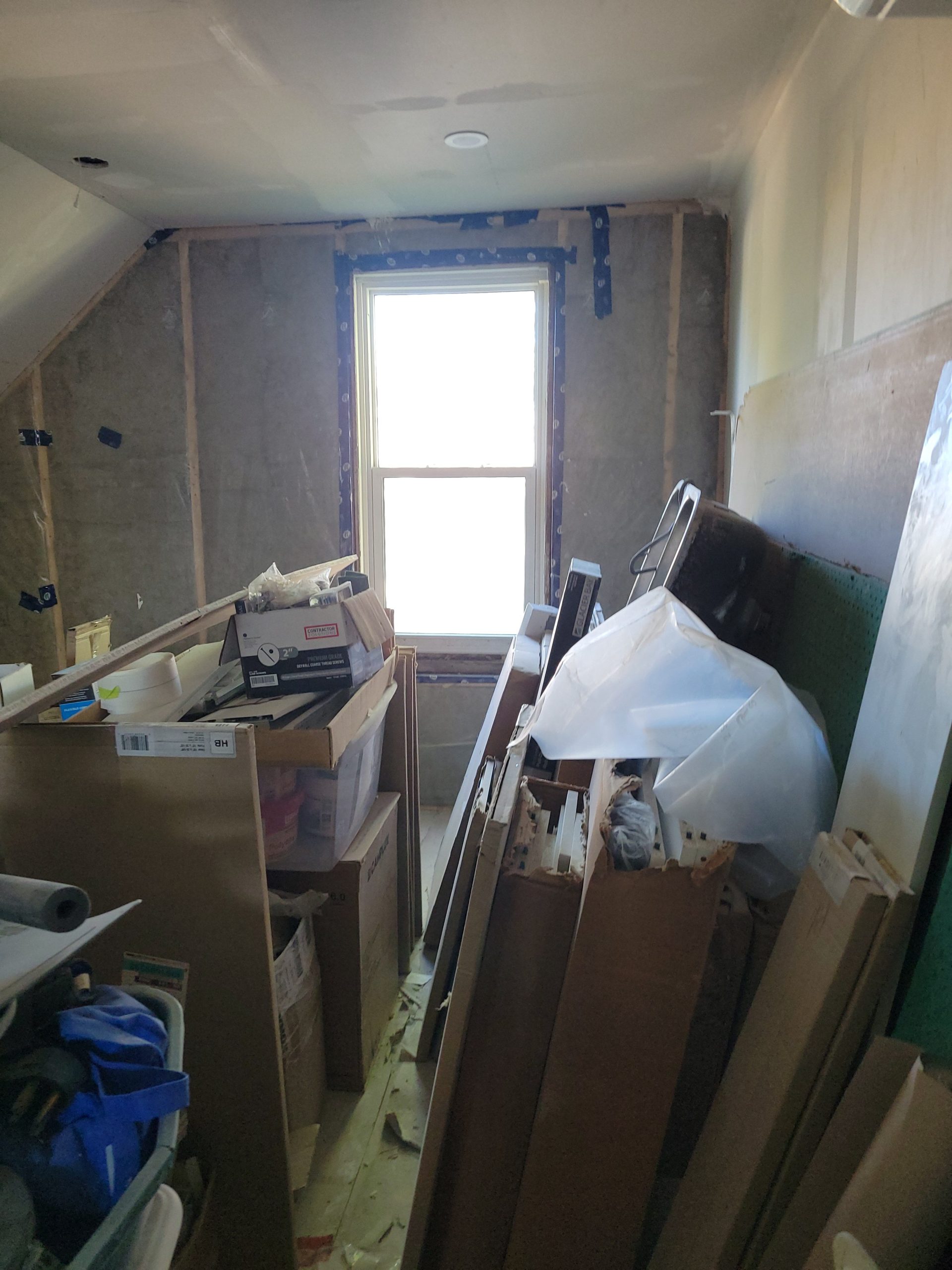

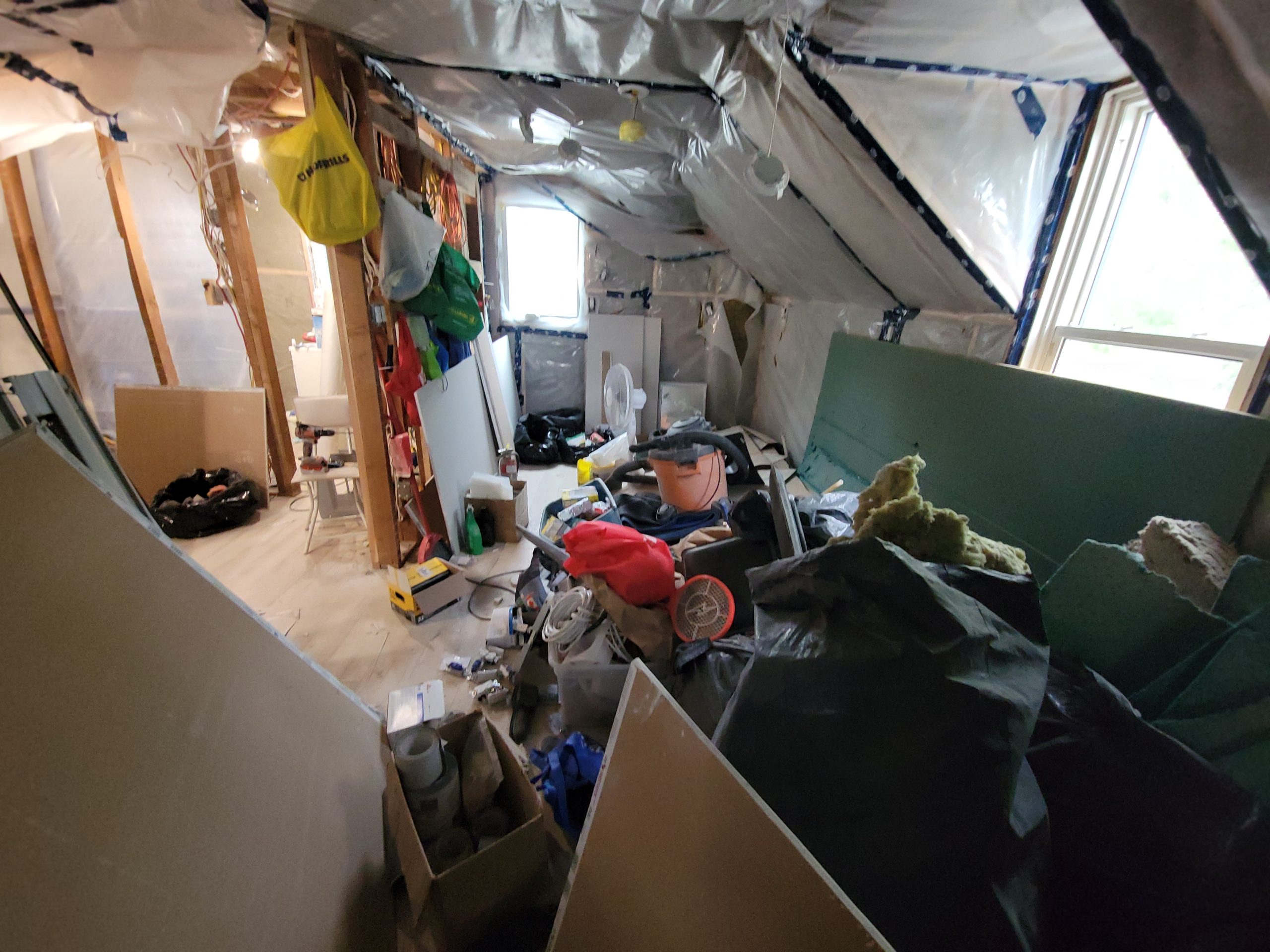

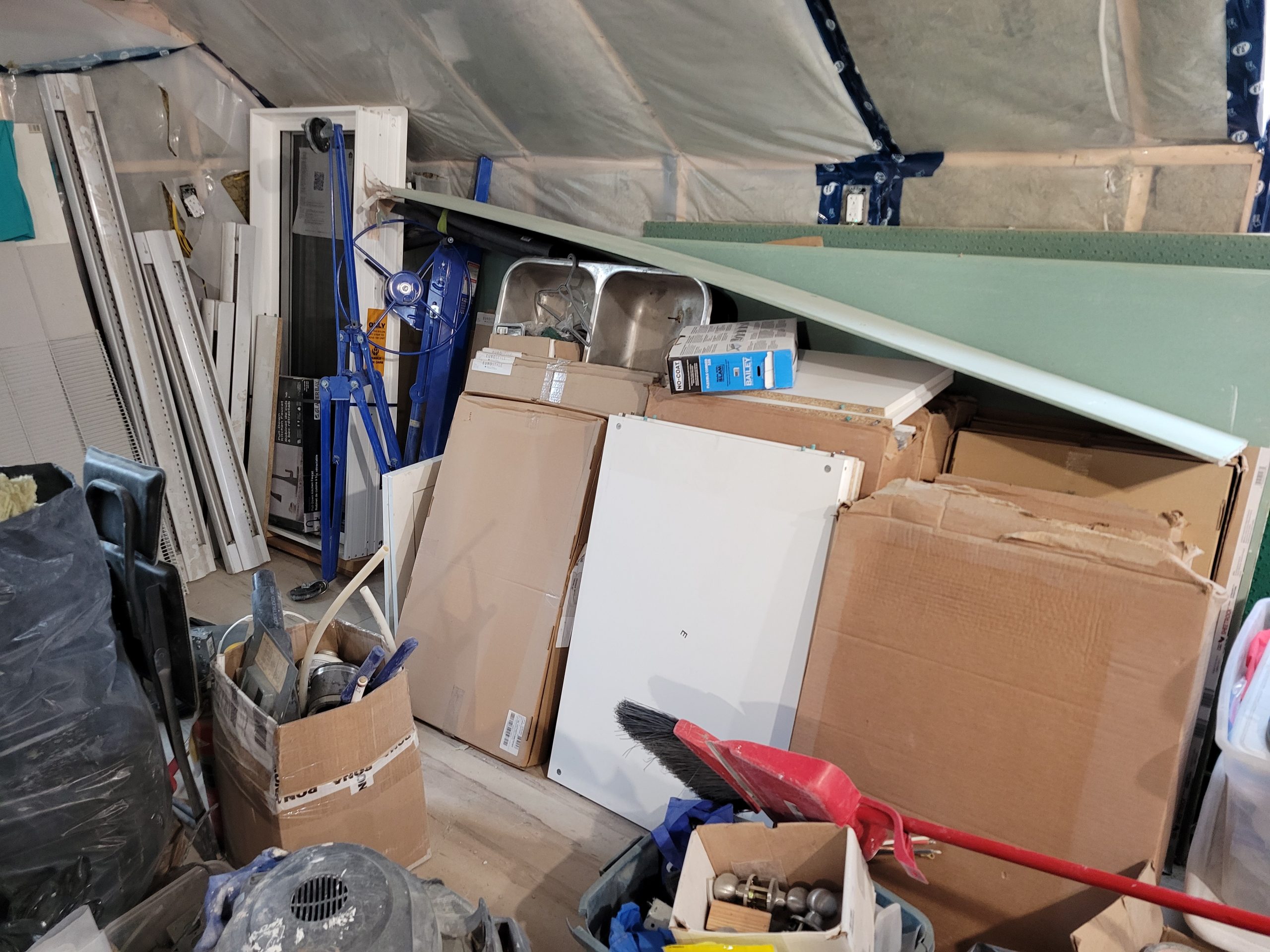

The entrance, stairway, and all the rooms are chocked full of stuff that needs to be moved, removed, organized, or used.

We’re almost done!  (Not!)

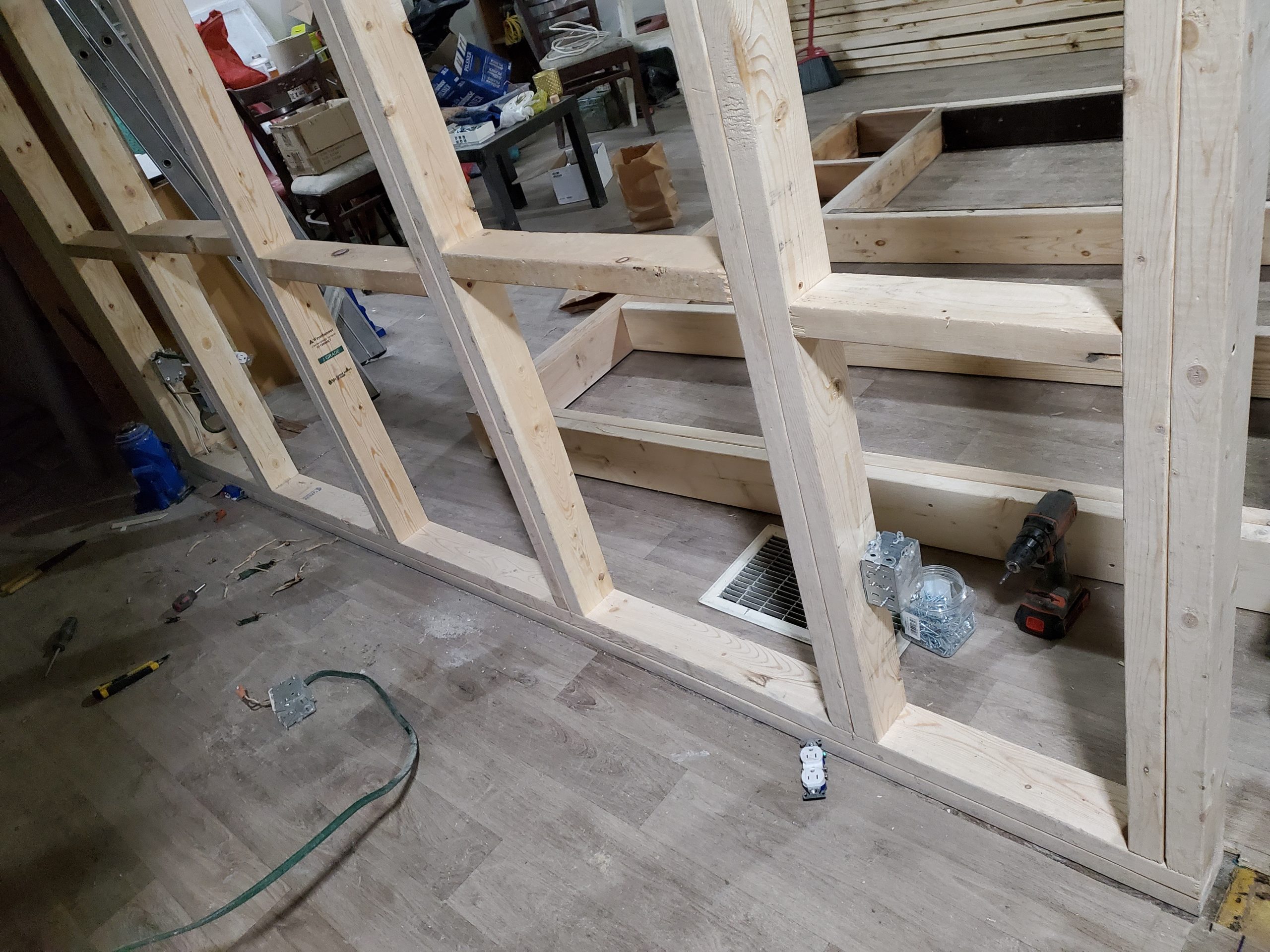

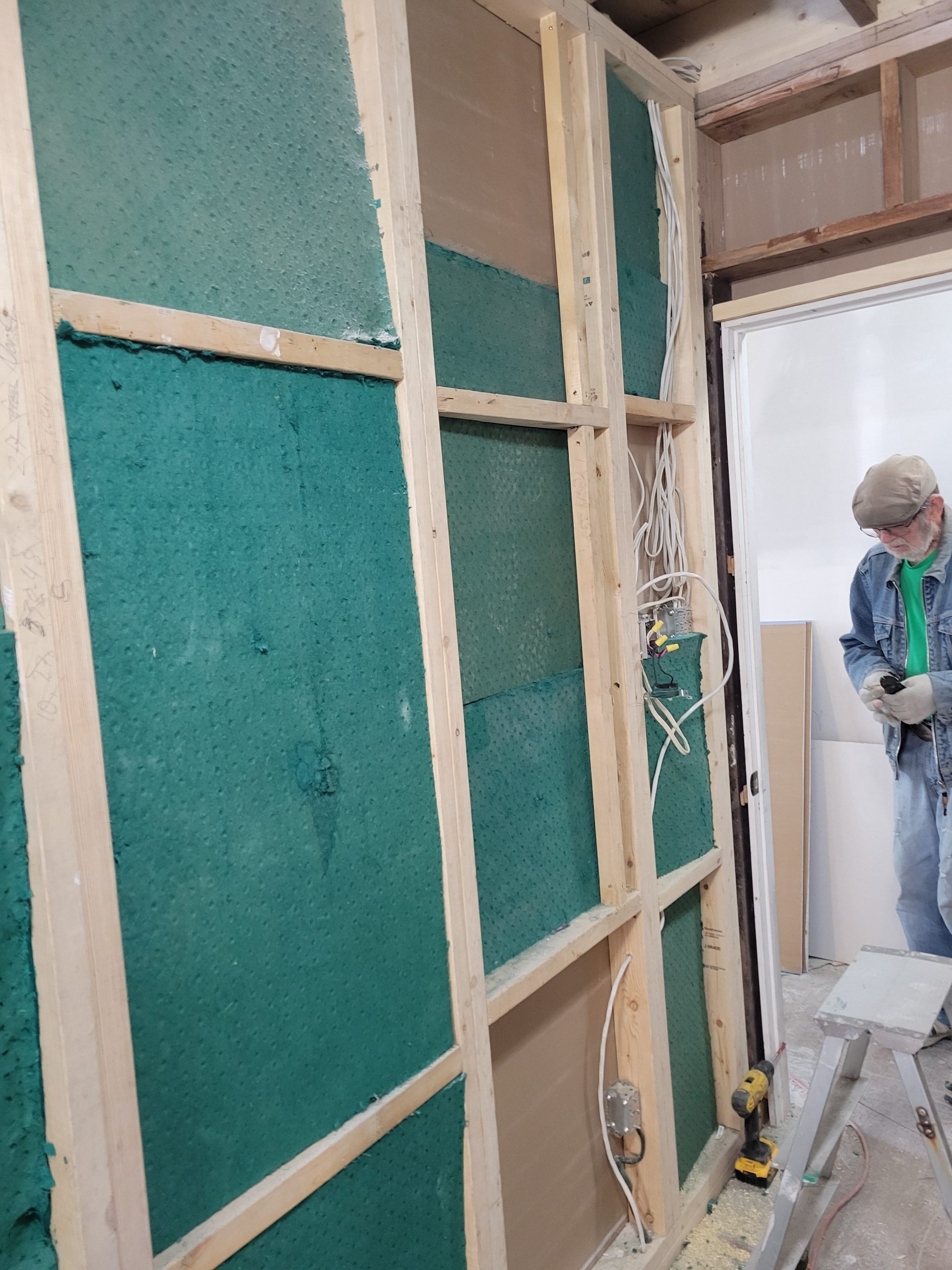

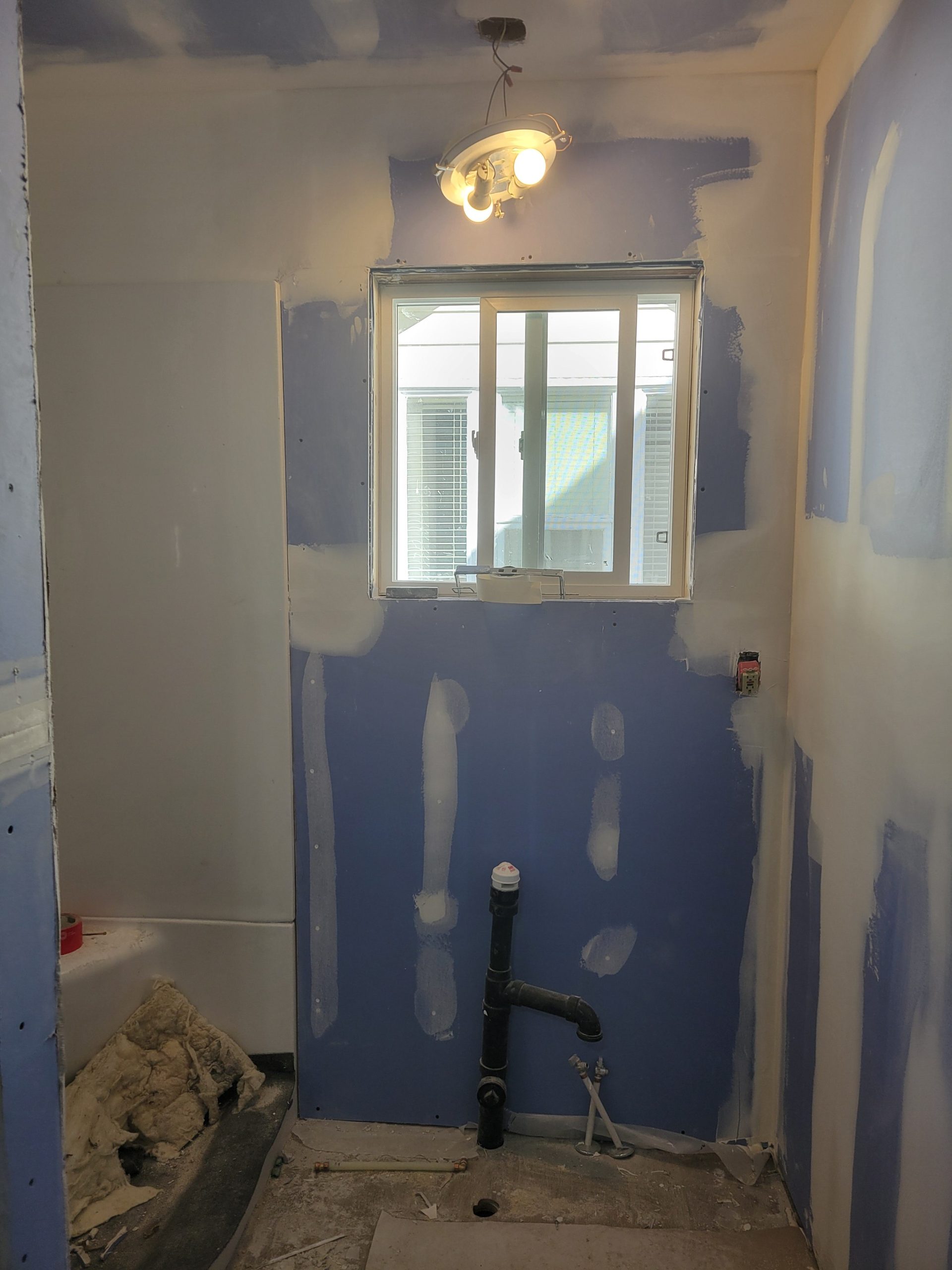

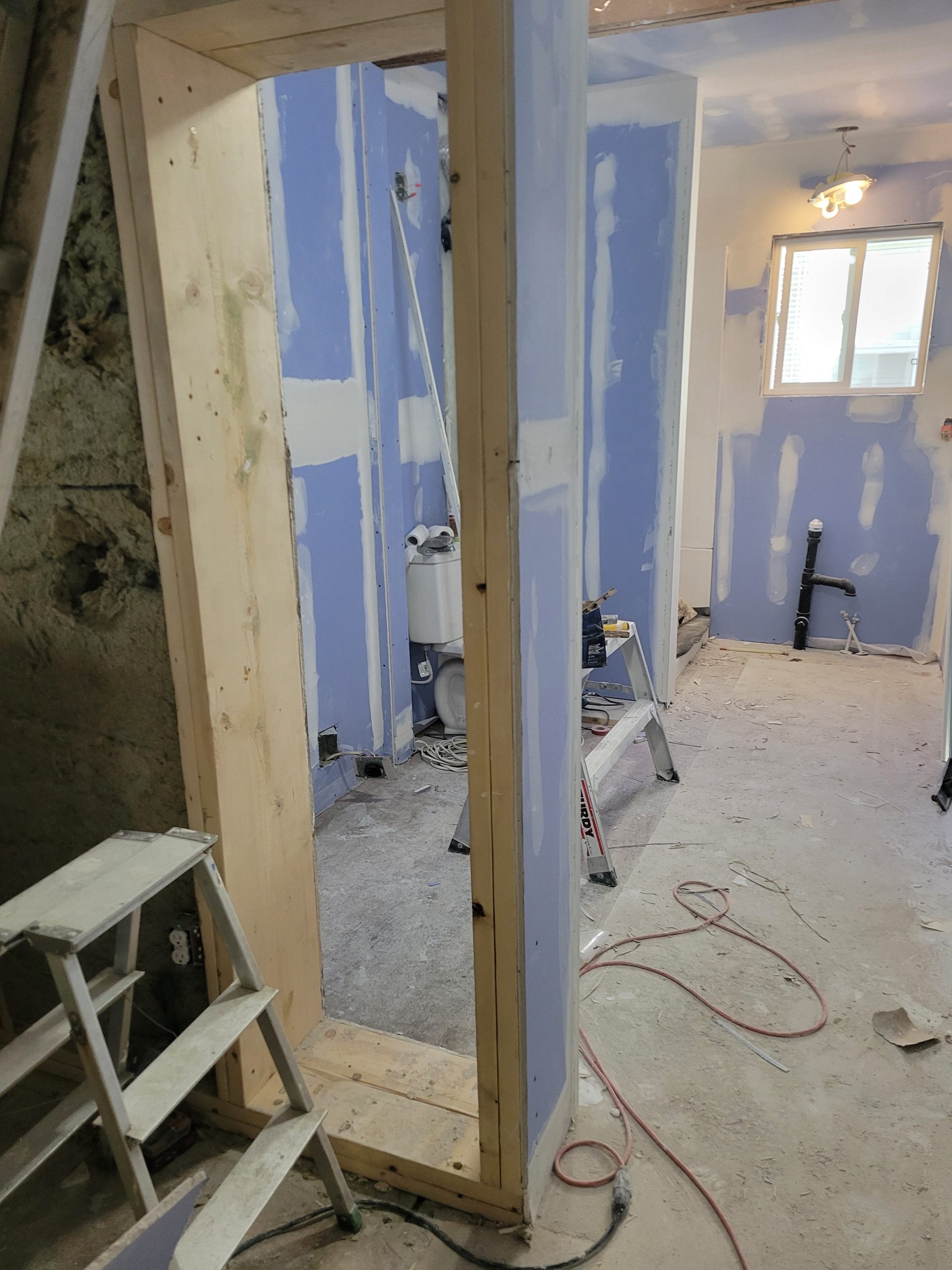

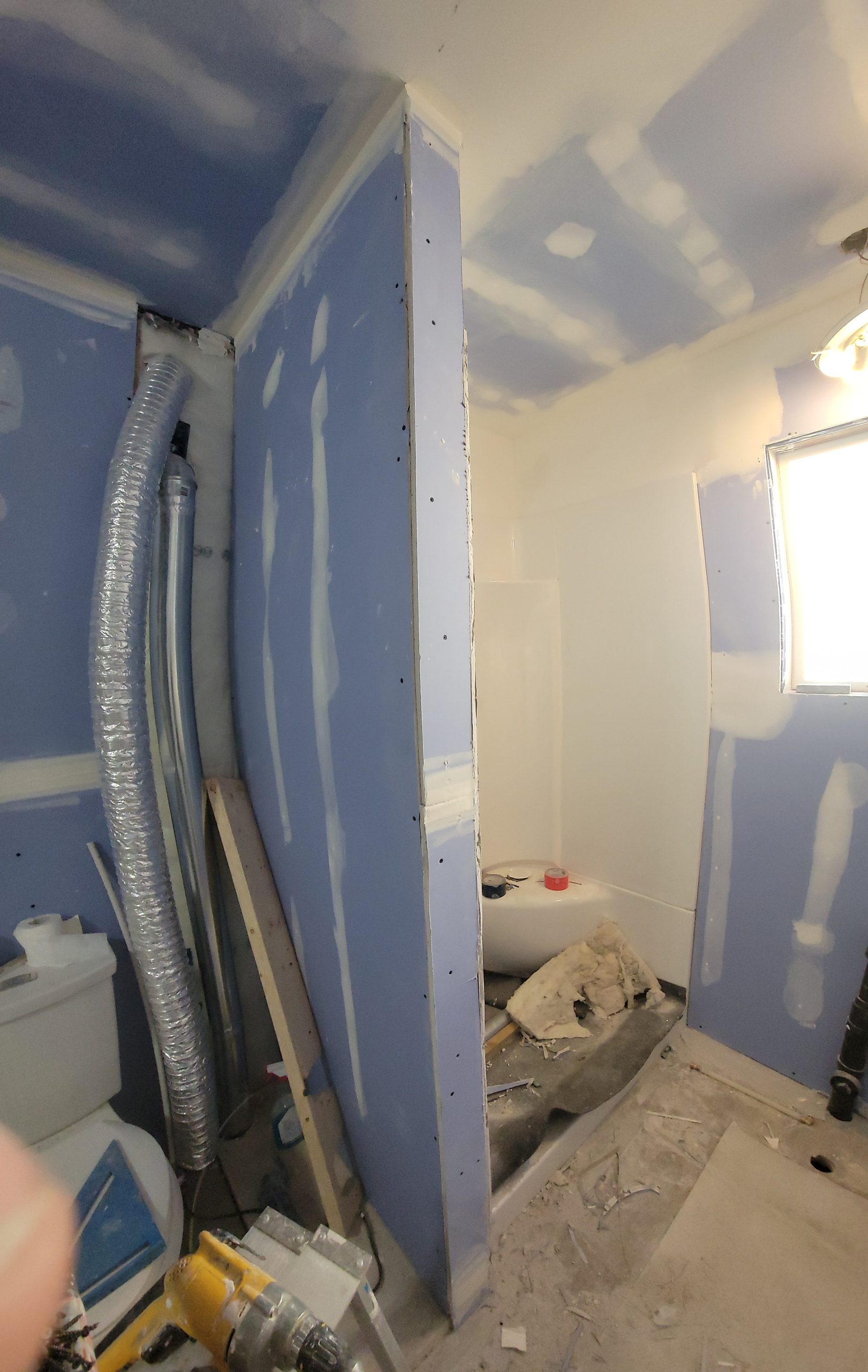

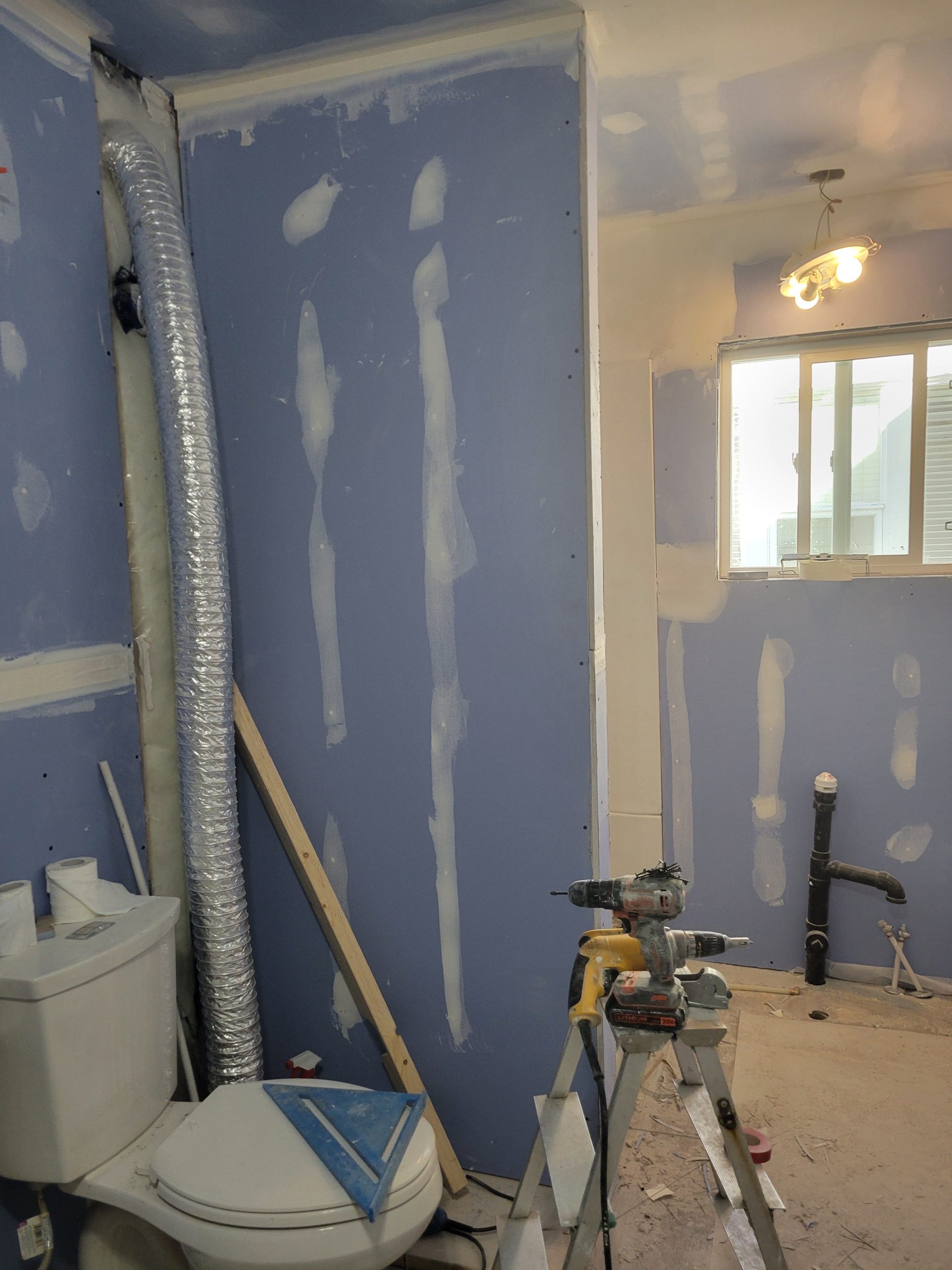

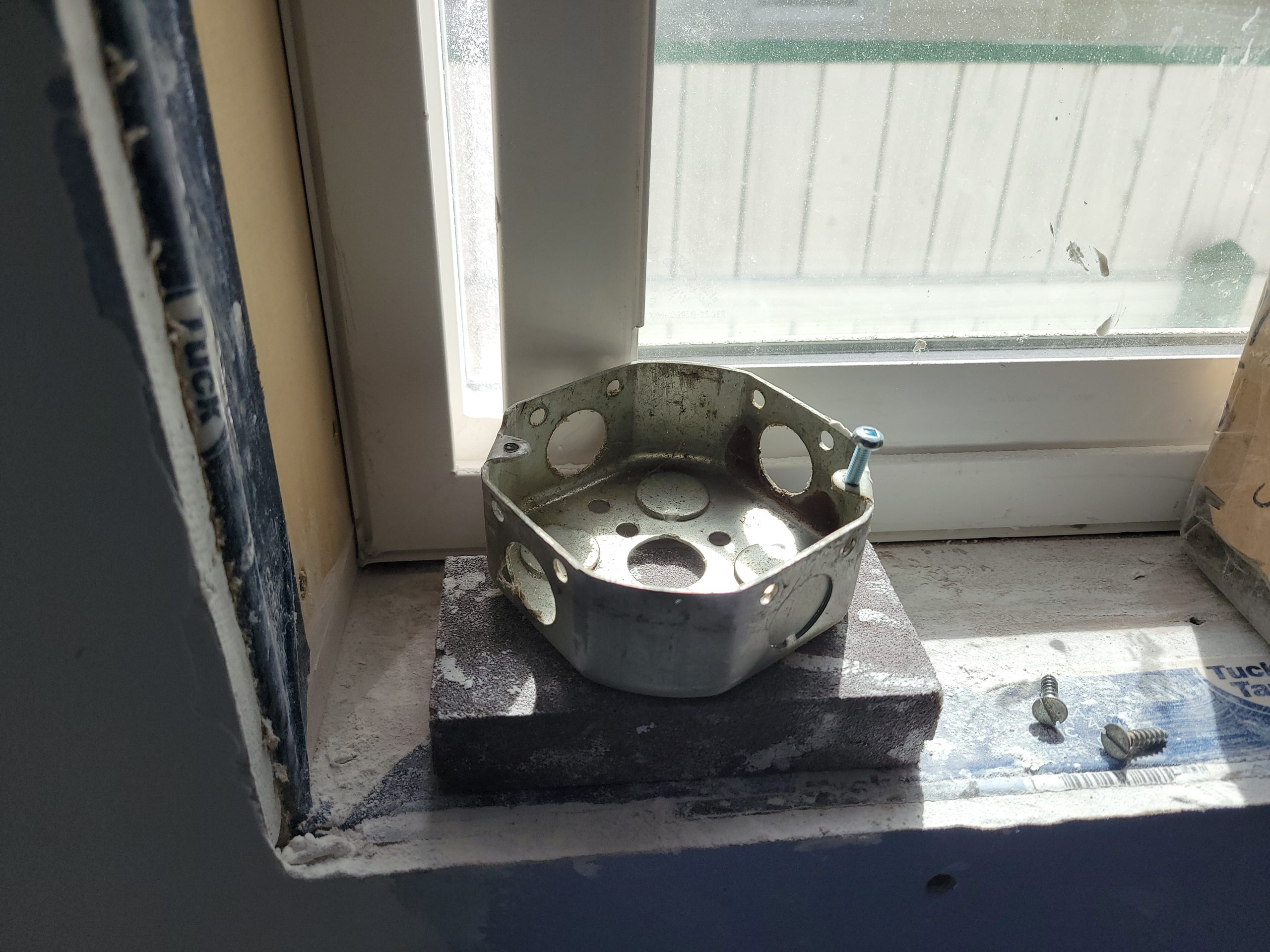

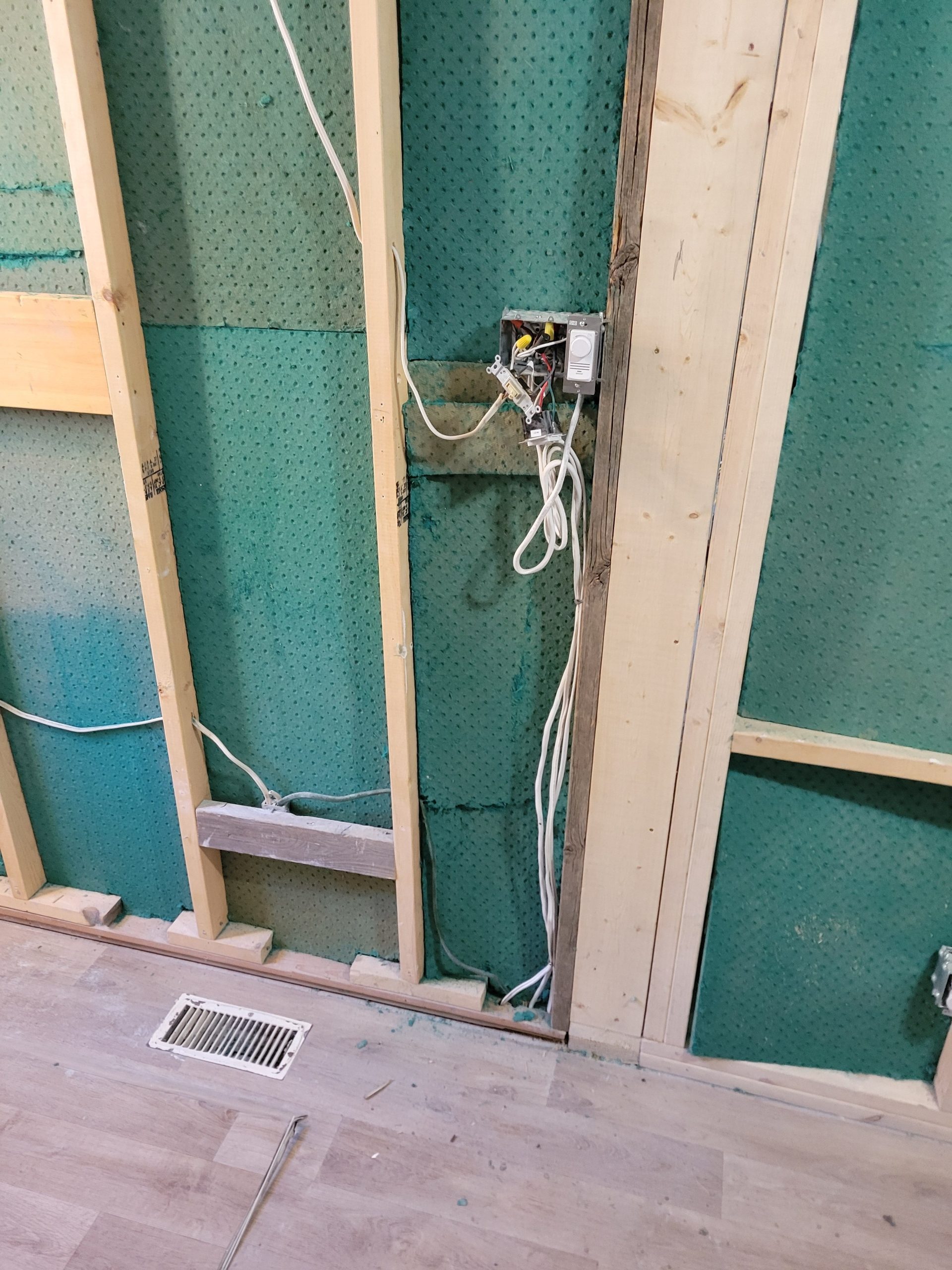

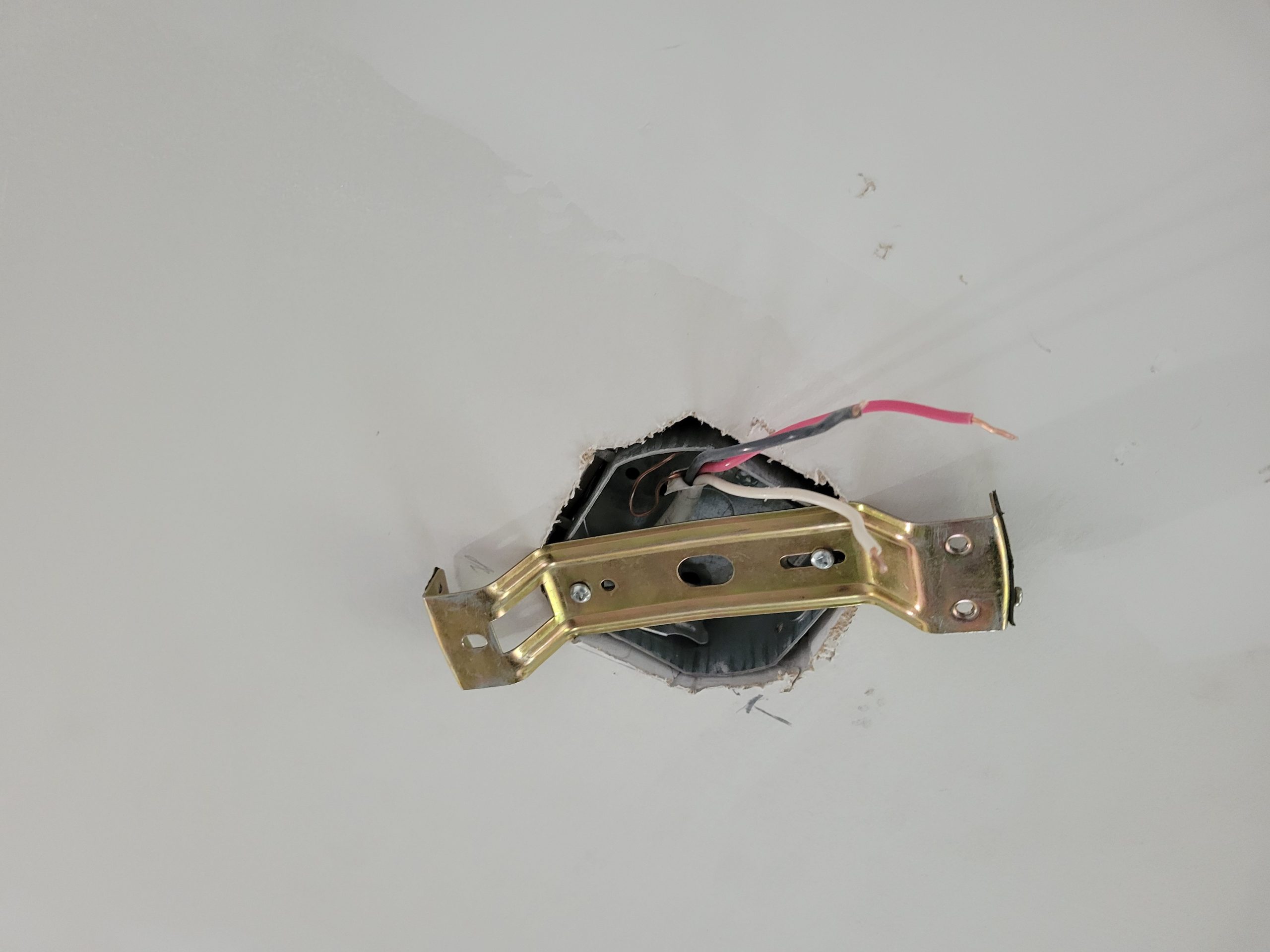

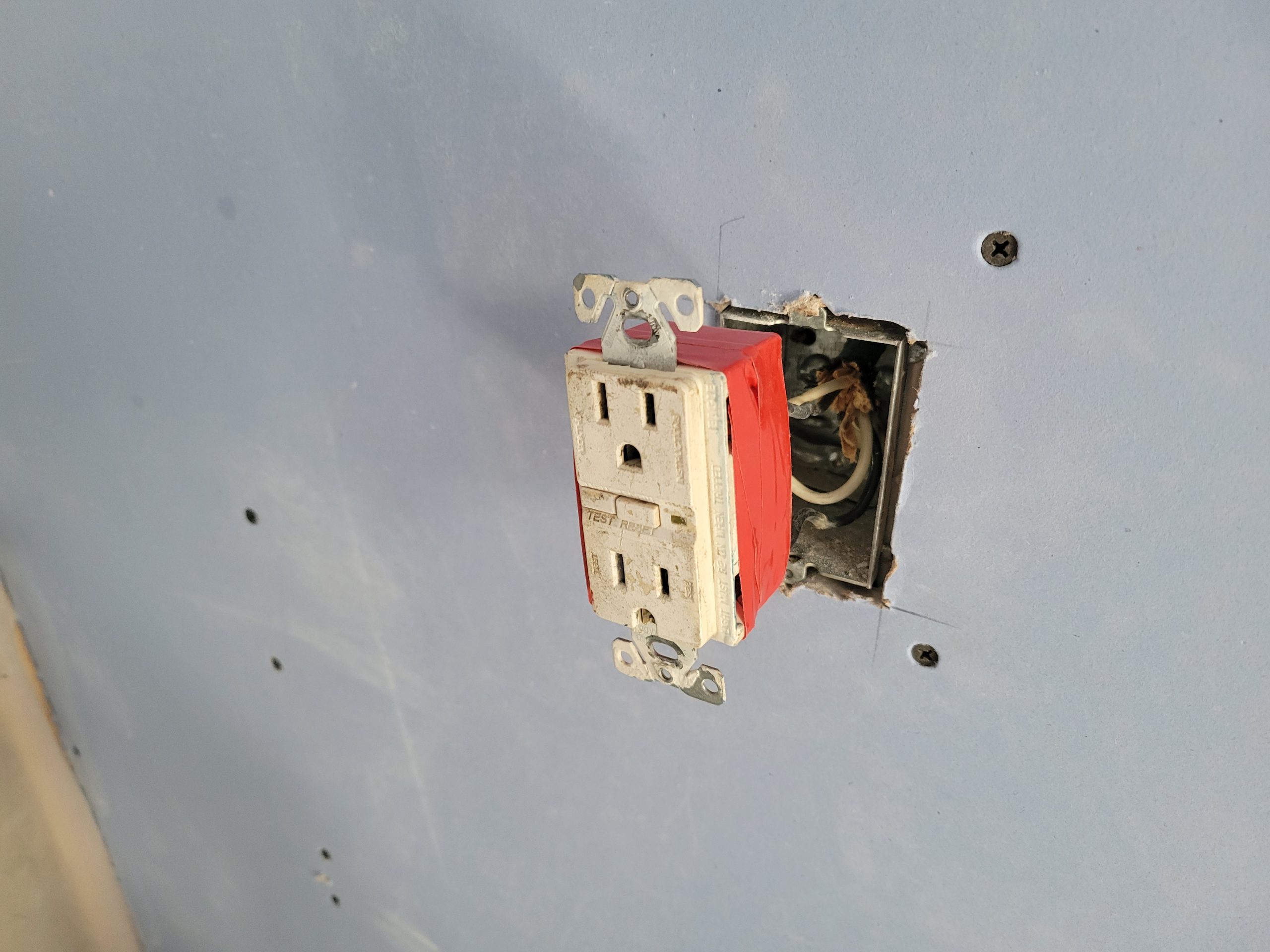

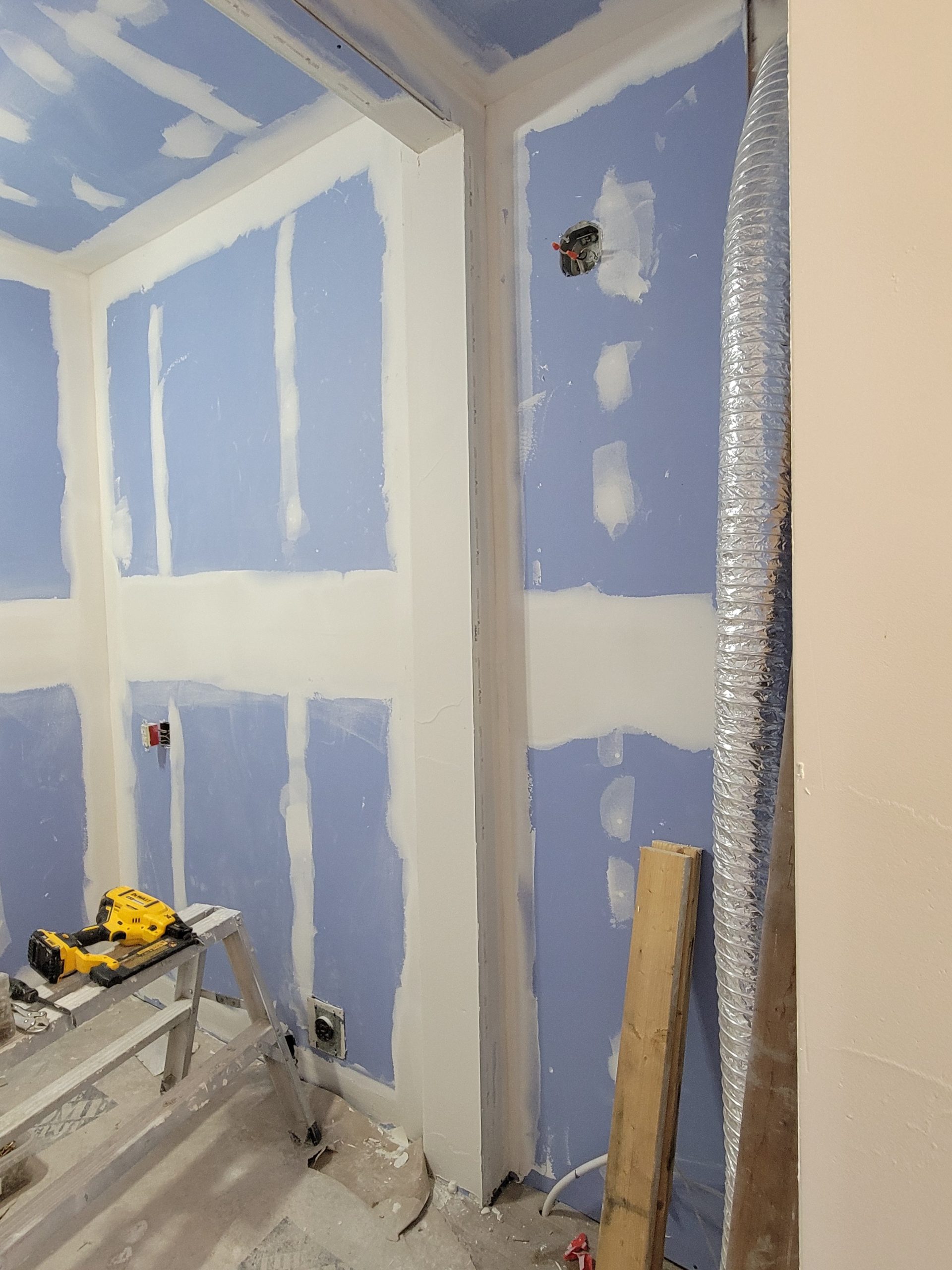

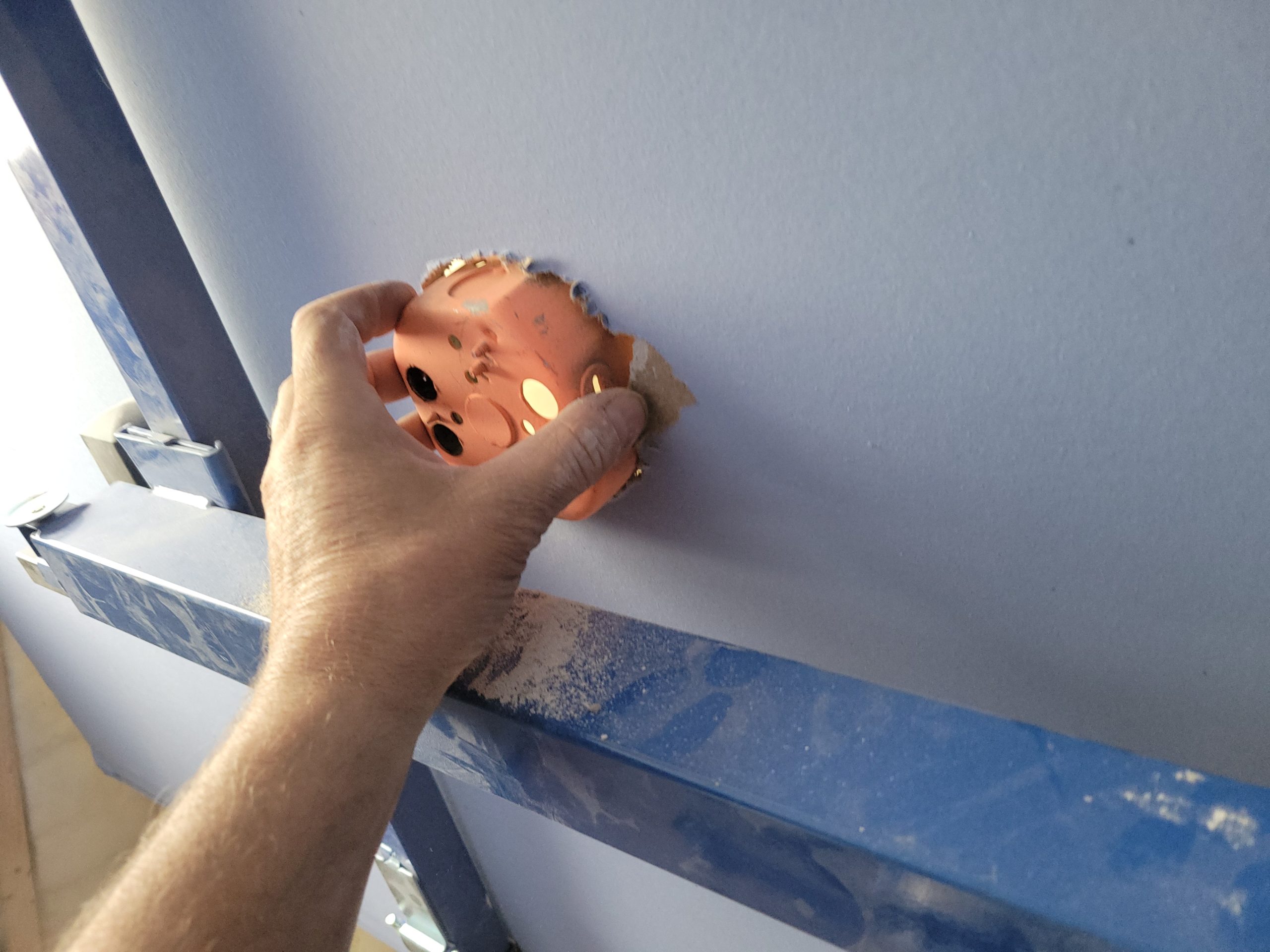

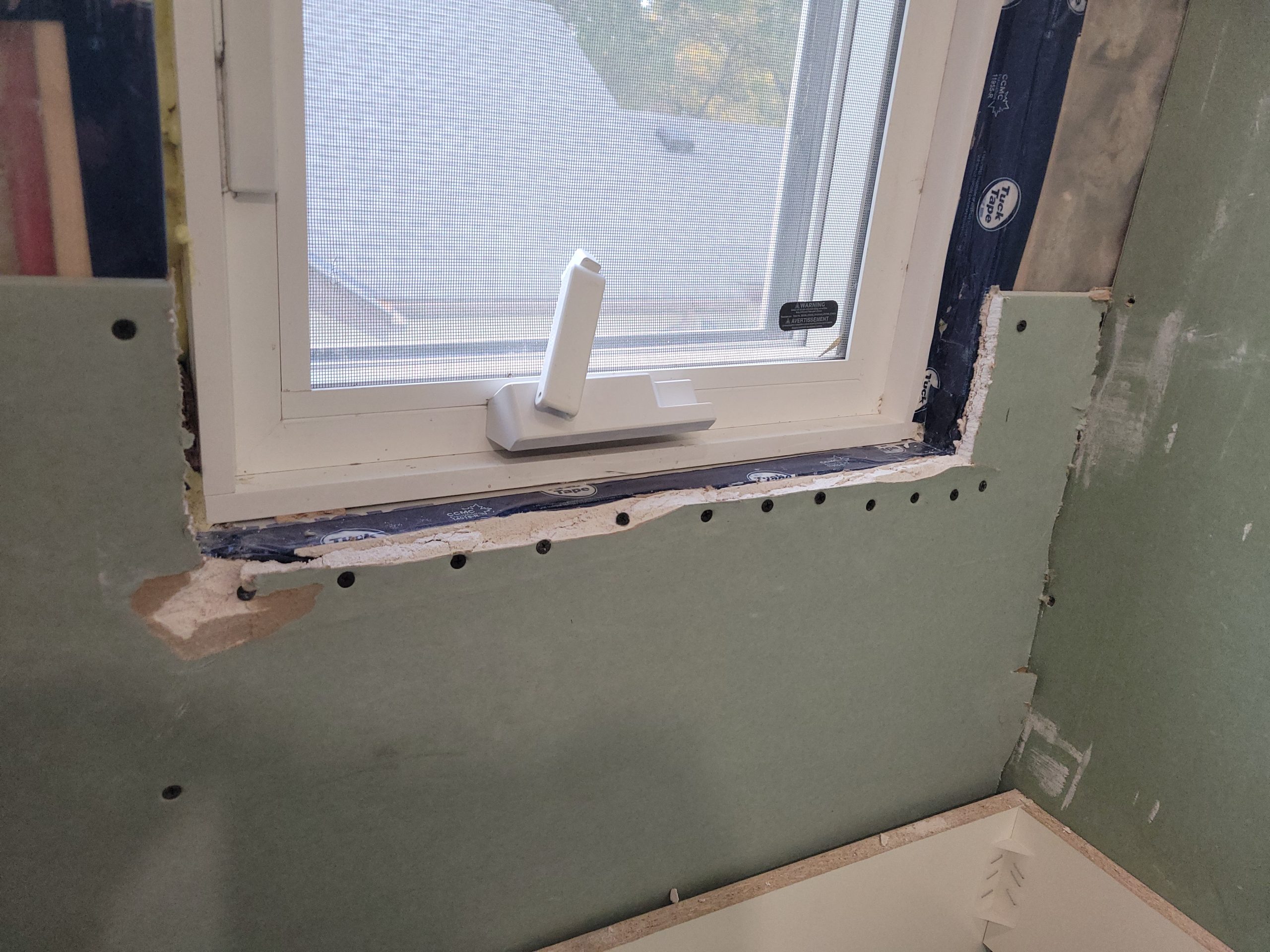

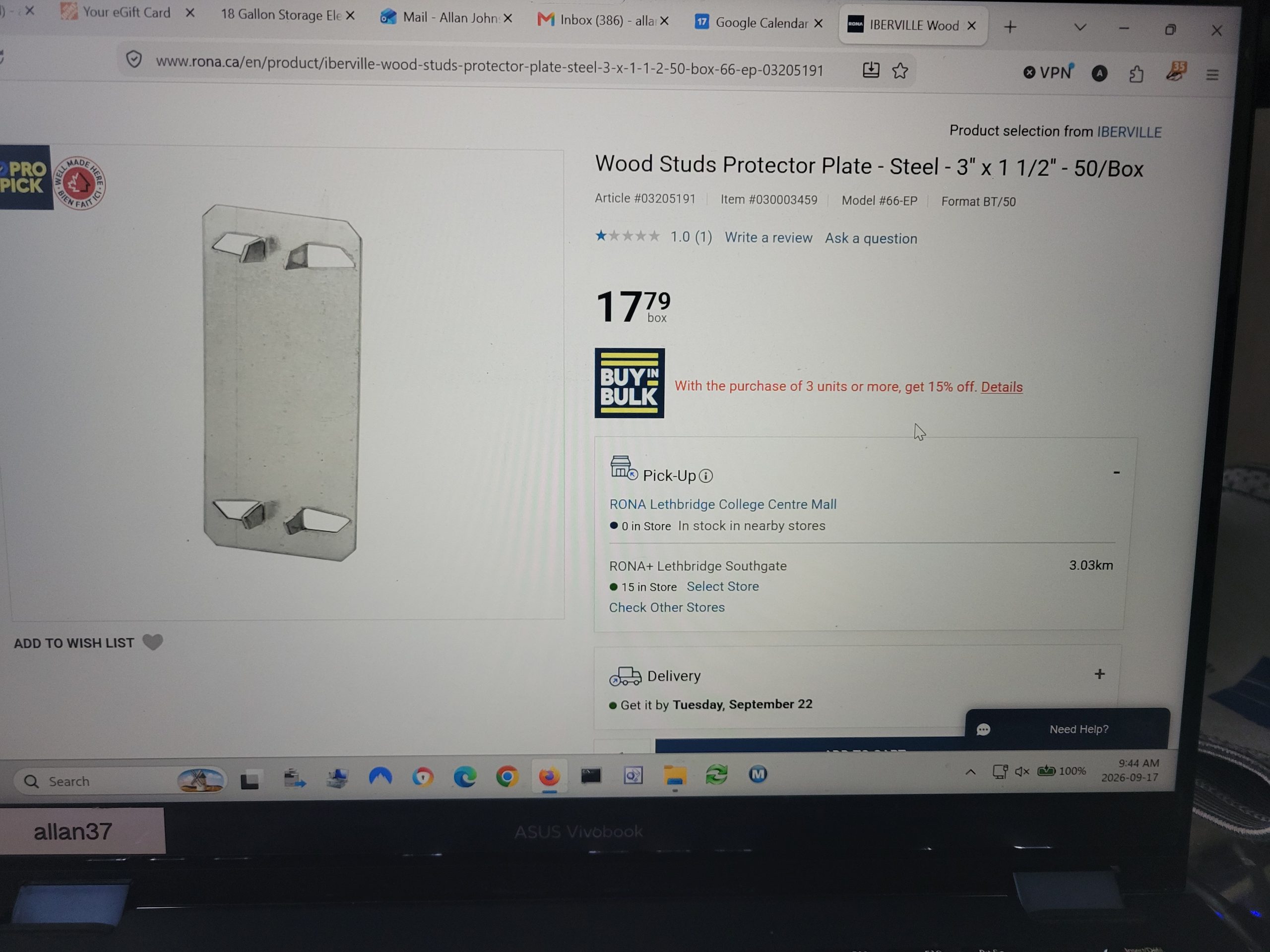

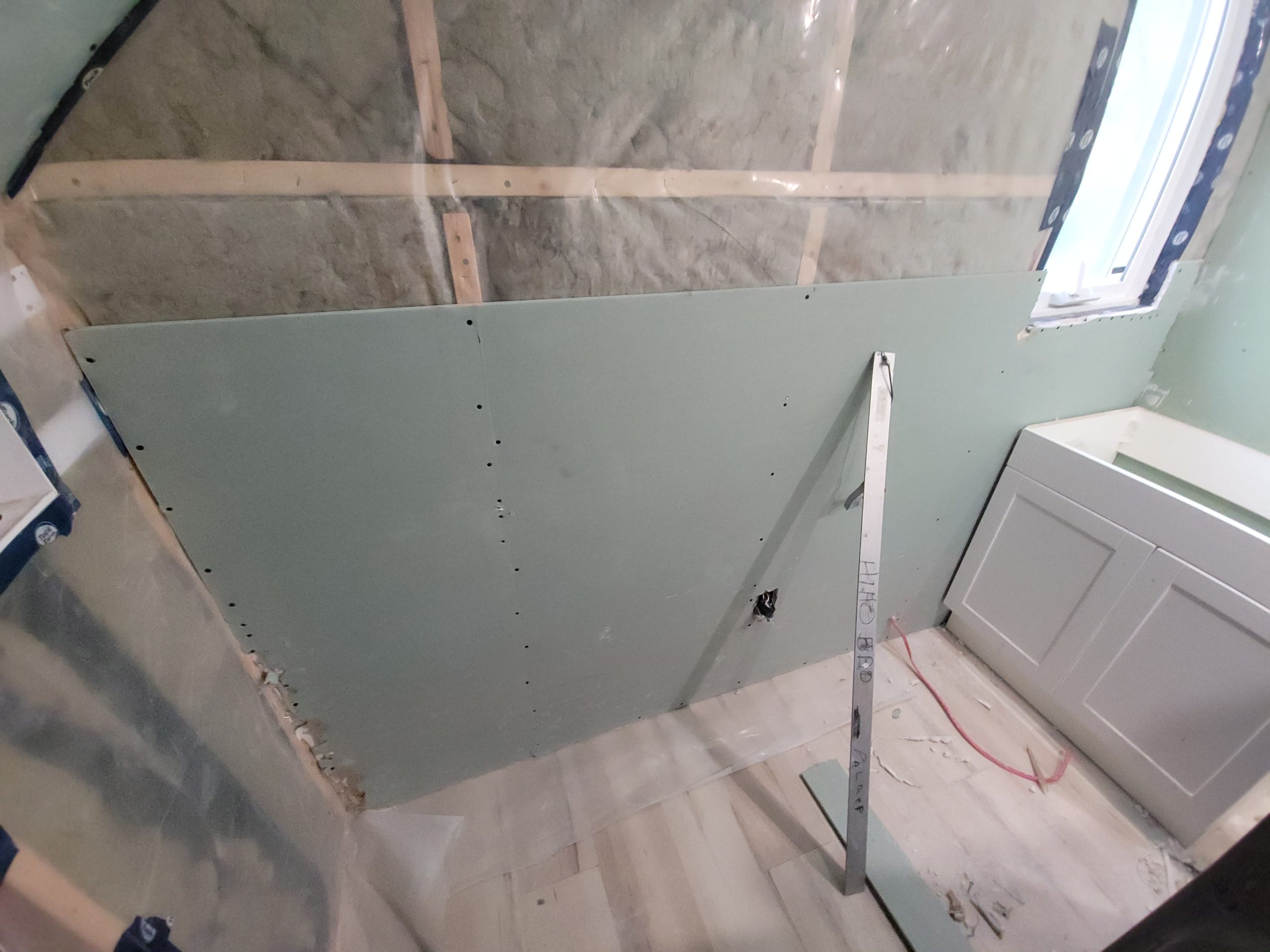

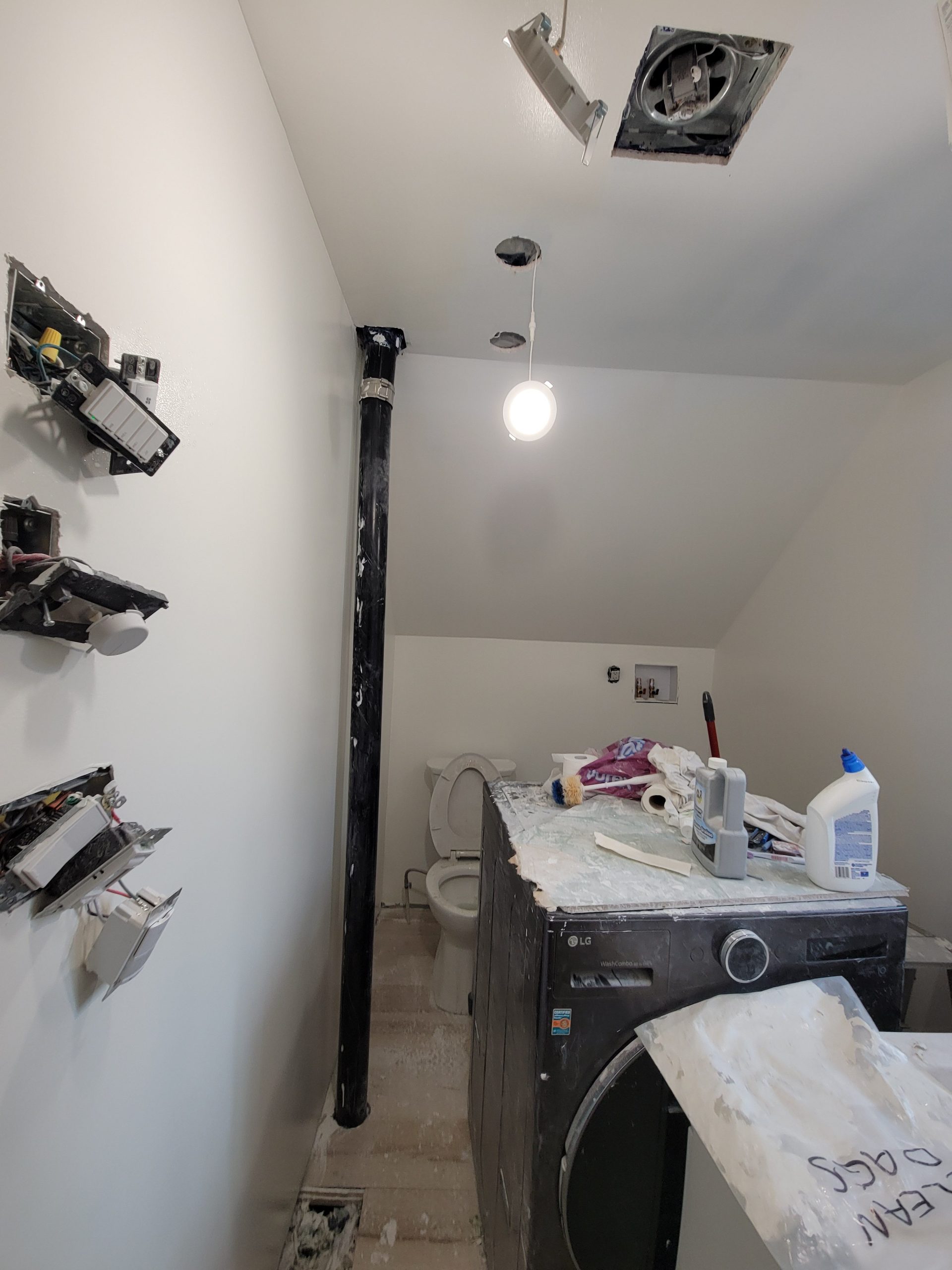

The panel needs improvements, mostly to get up to code.  Protector plates (“bang plates”) were added to various walls.

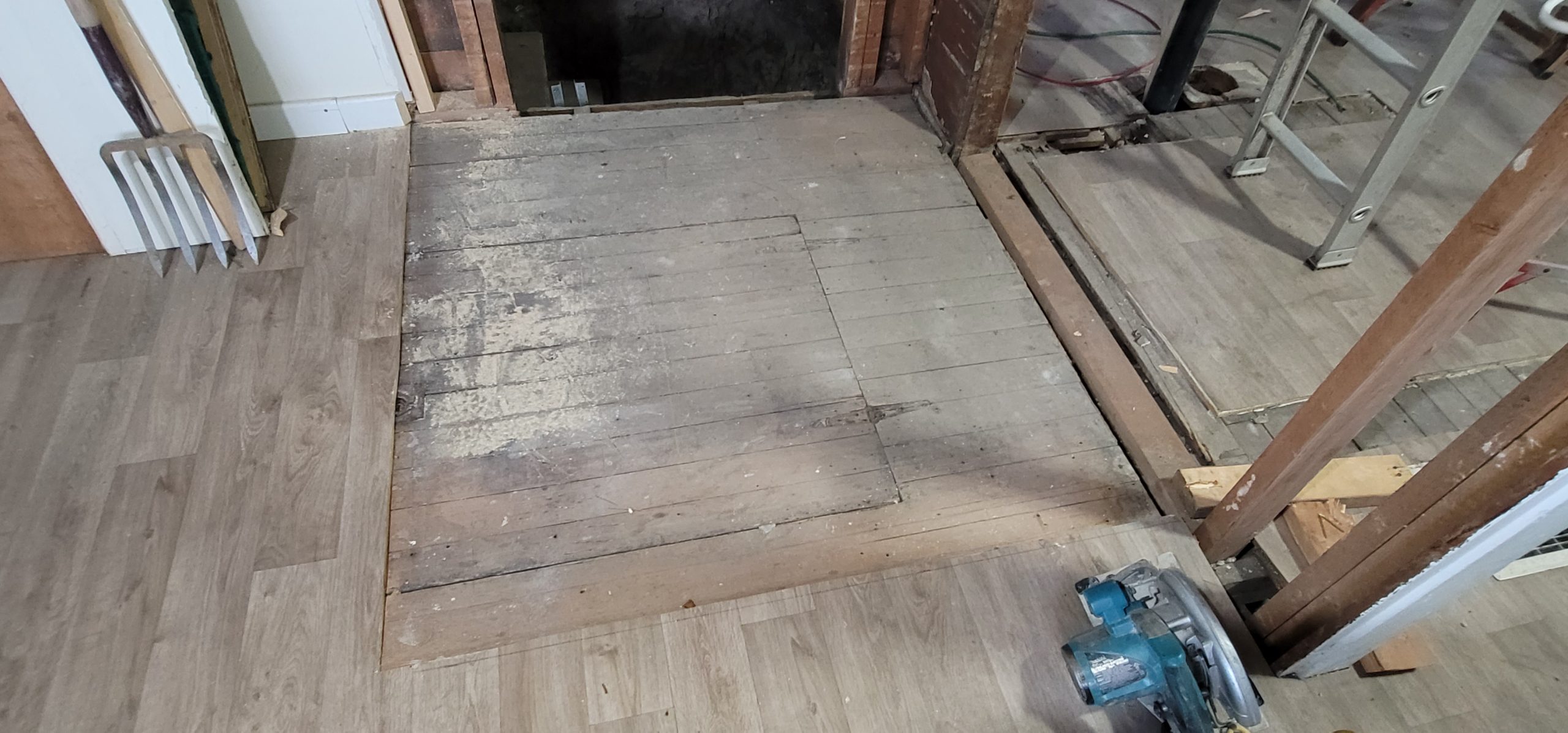

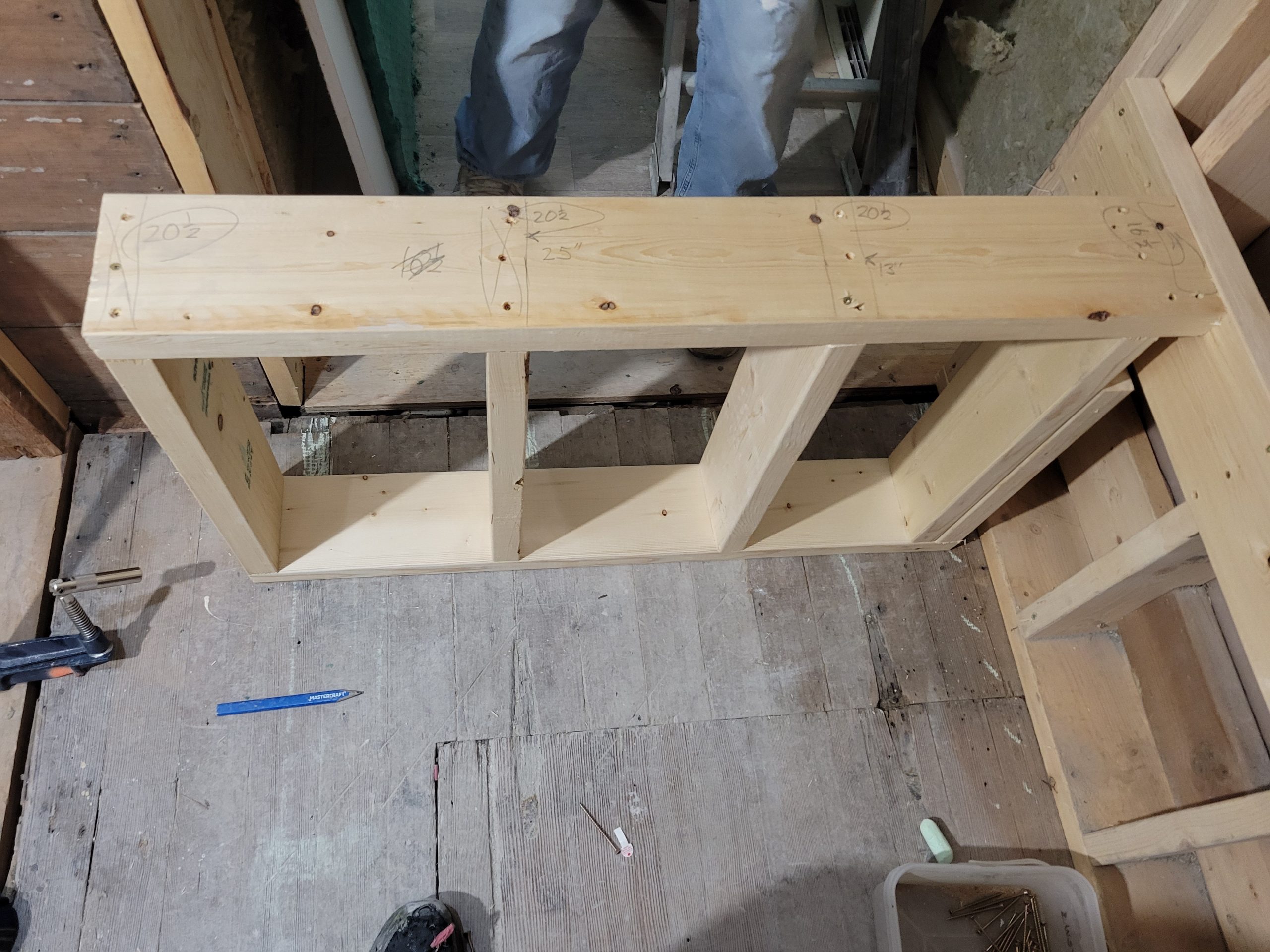

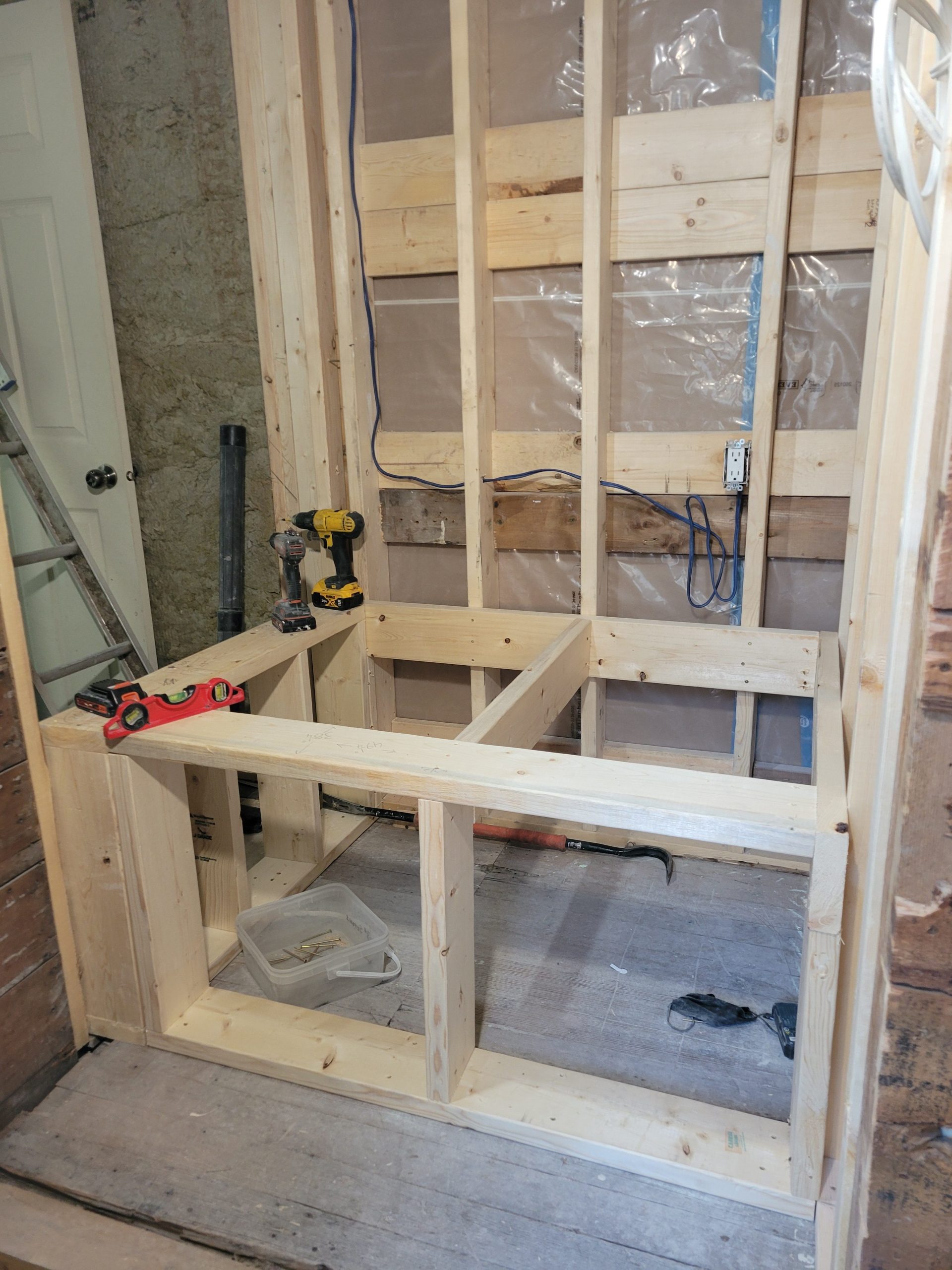

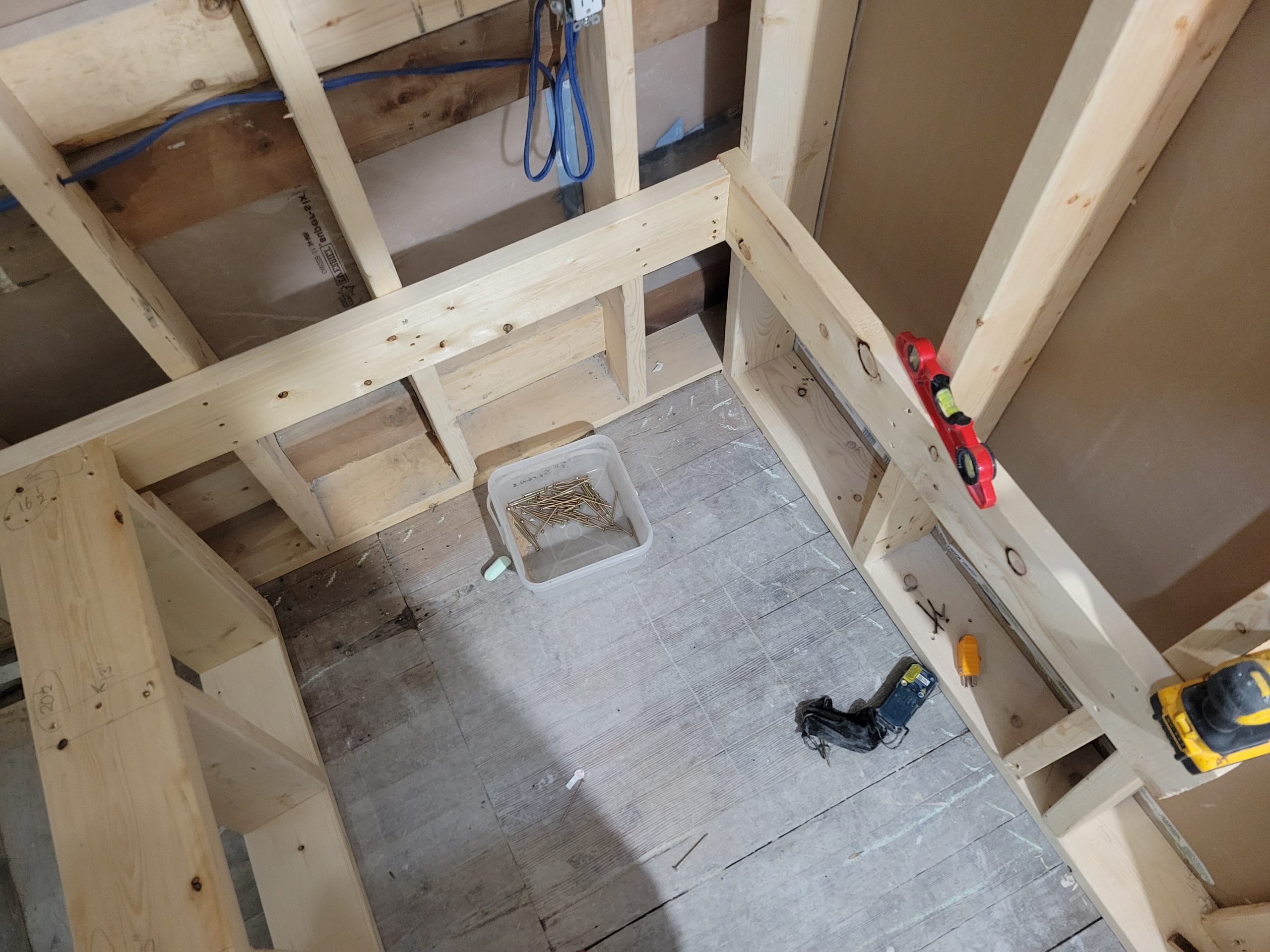

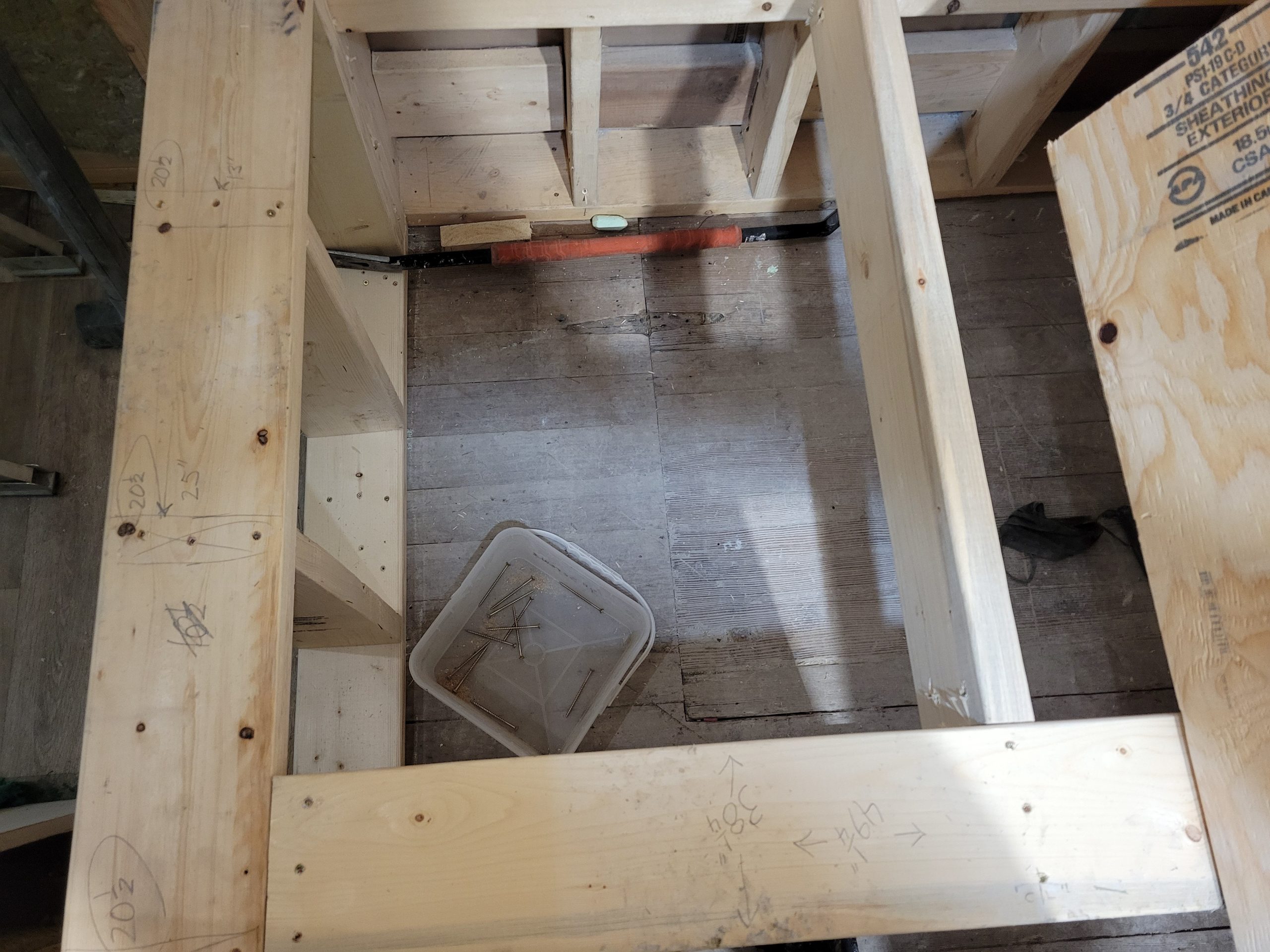

Do I clean up or start construction?  I began drilling holes in the hinge for the storage area under the landing.

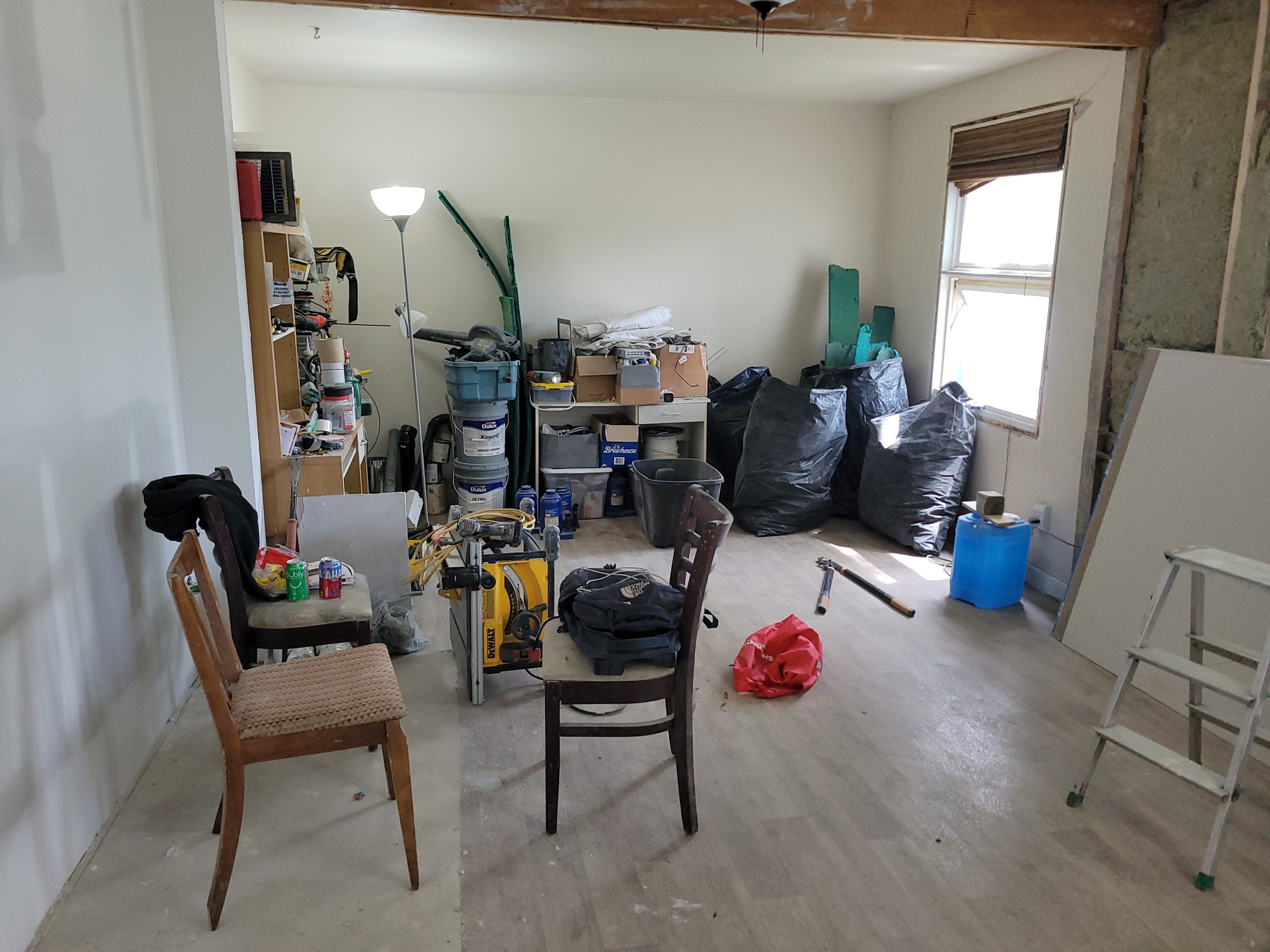

Cleanup won out.

cleaning day, moving day

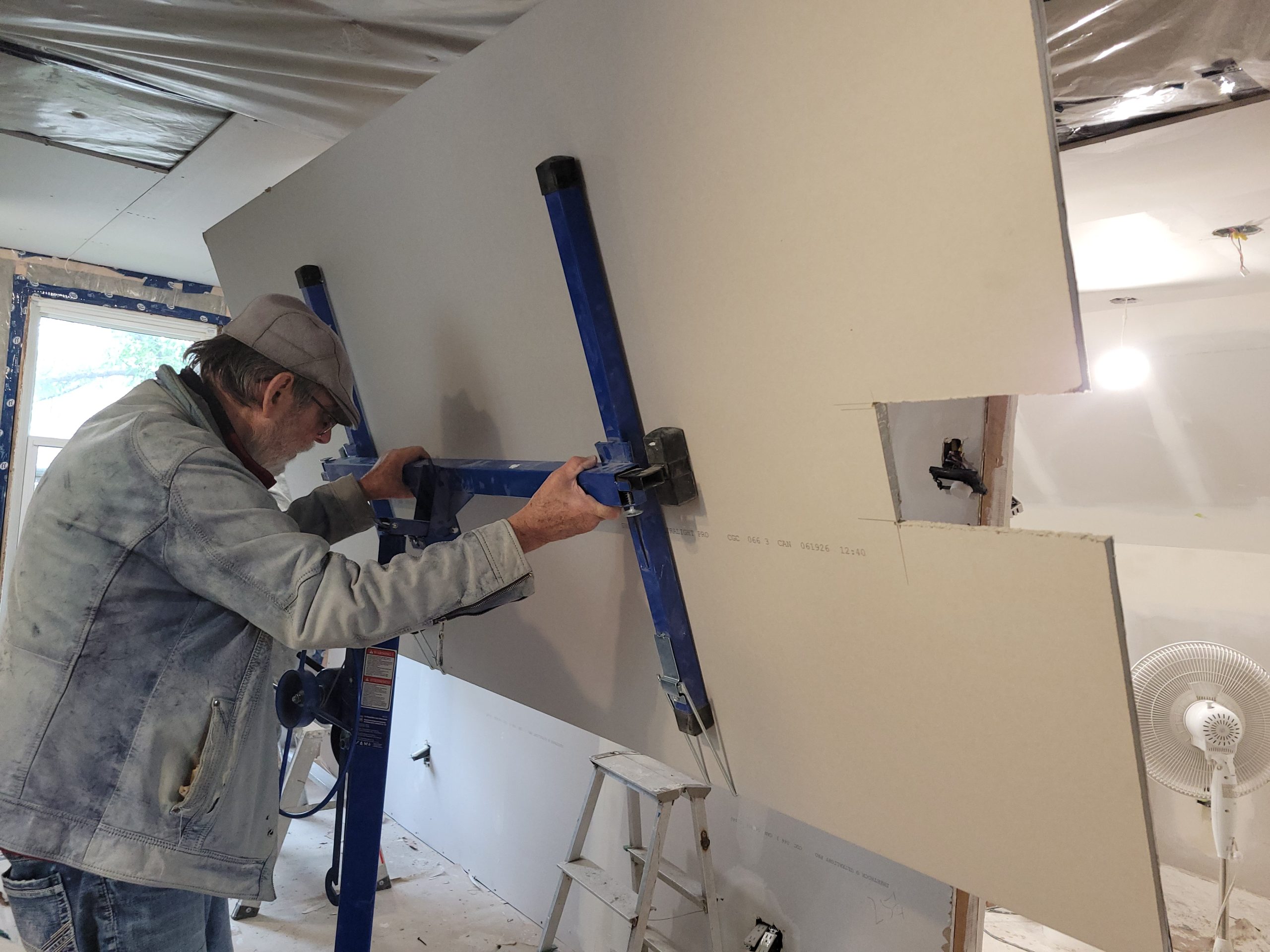

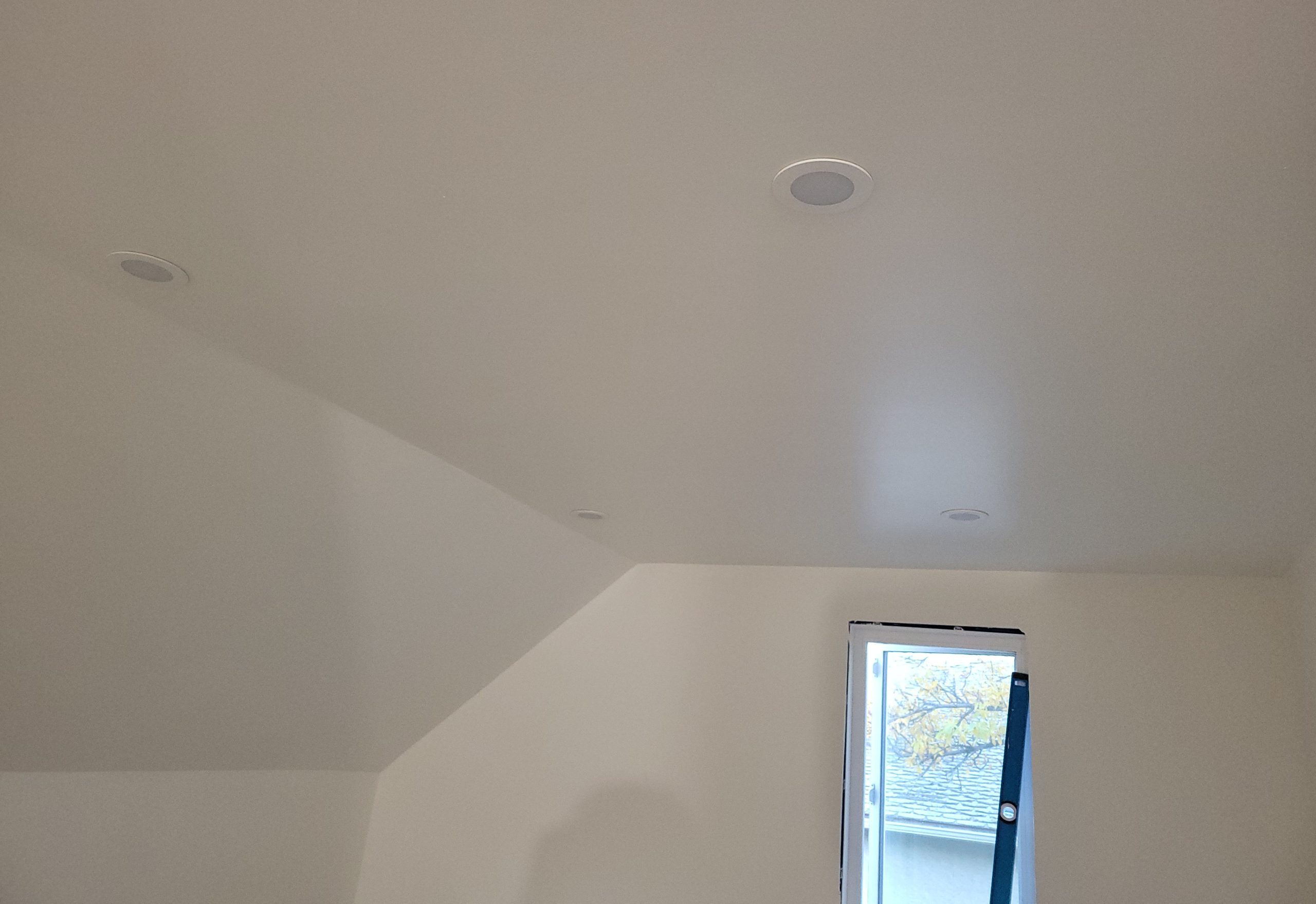

Cleaning of bedroom 2 ceiling begins.  Hard work!

But the tenant will move in soon.  The longer I wait, the less rent I will receive.  The kitchen is the last remaining uncleaned room.

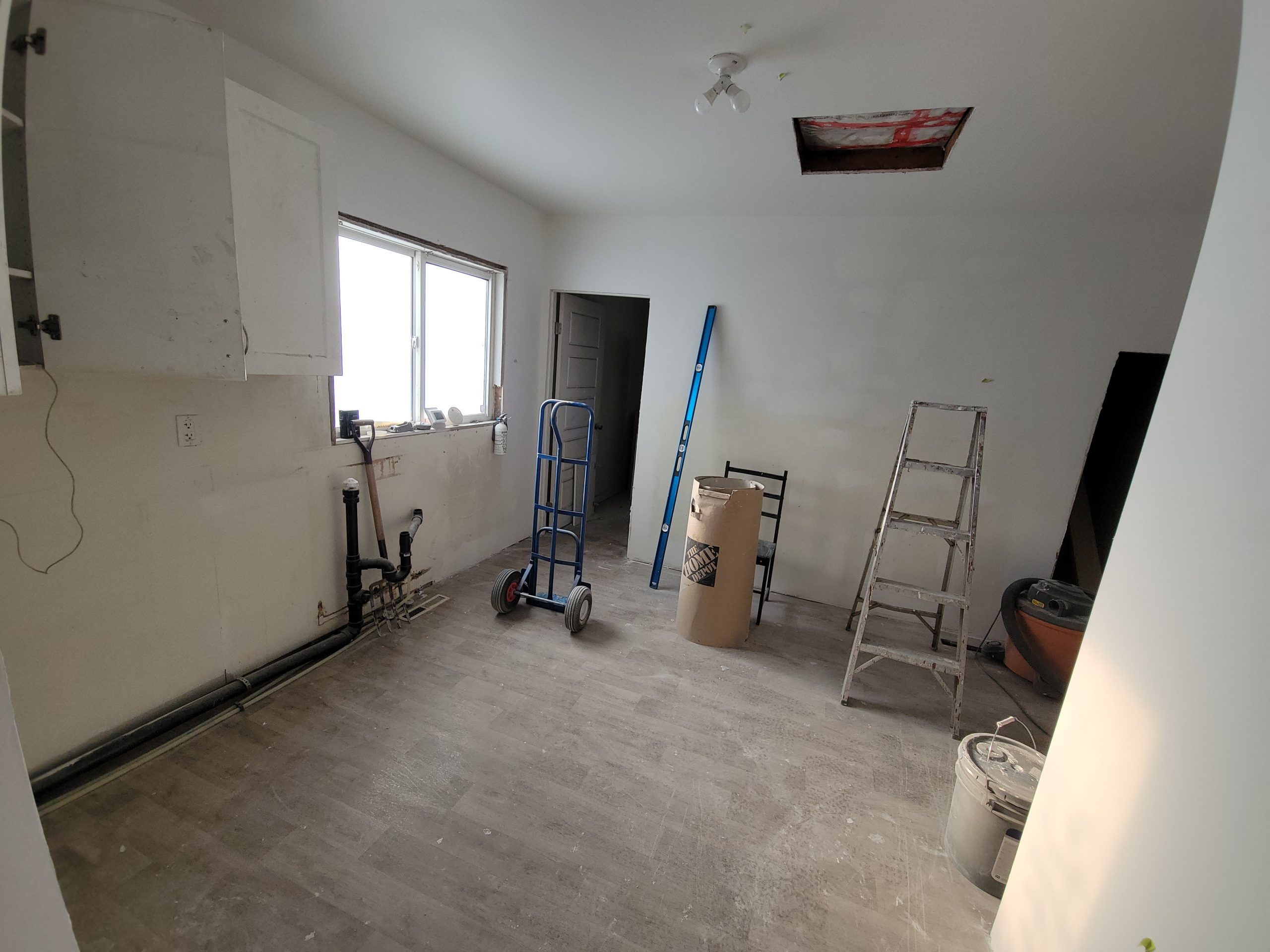

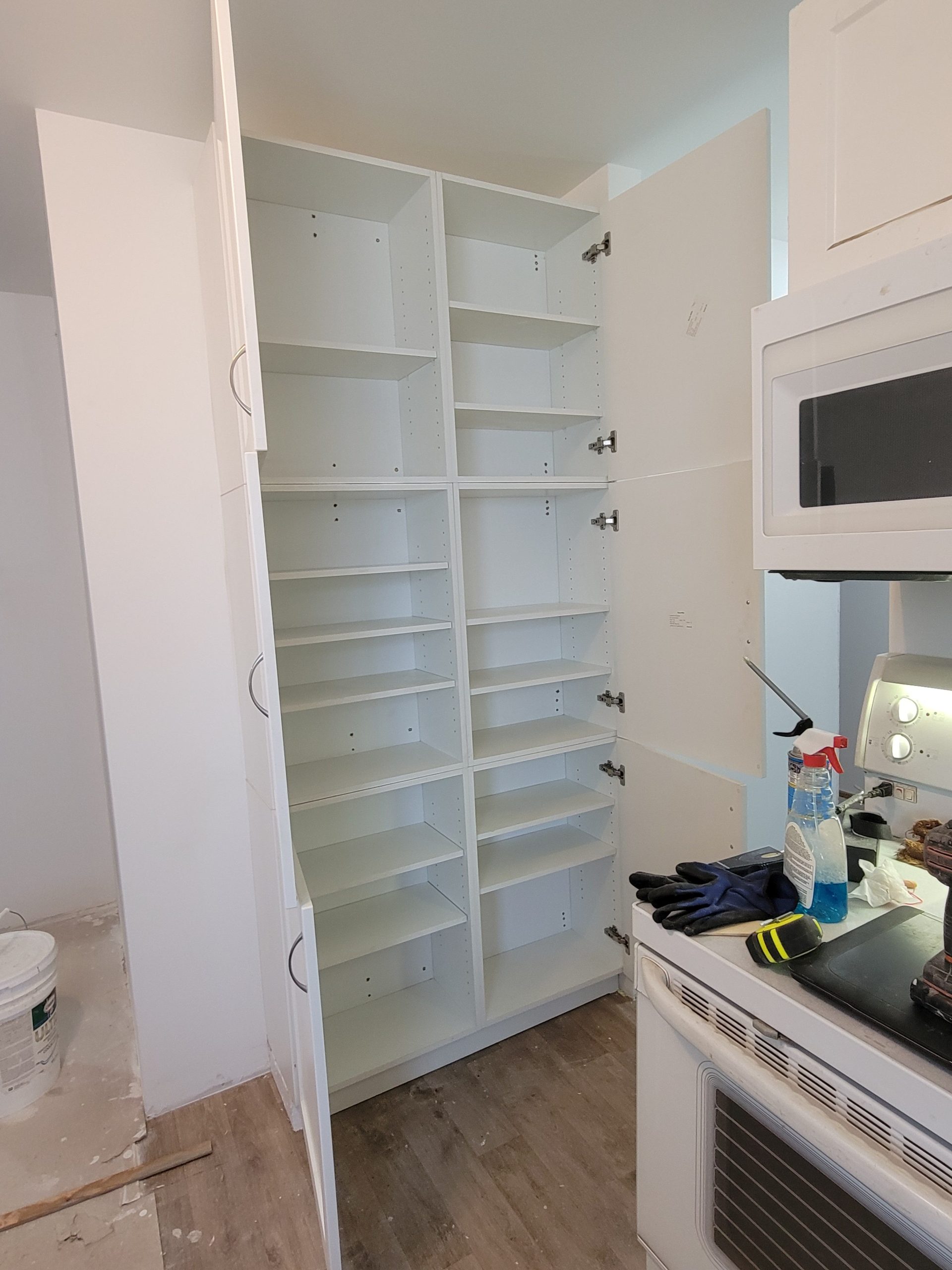

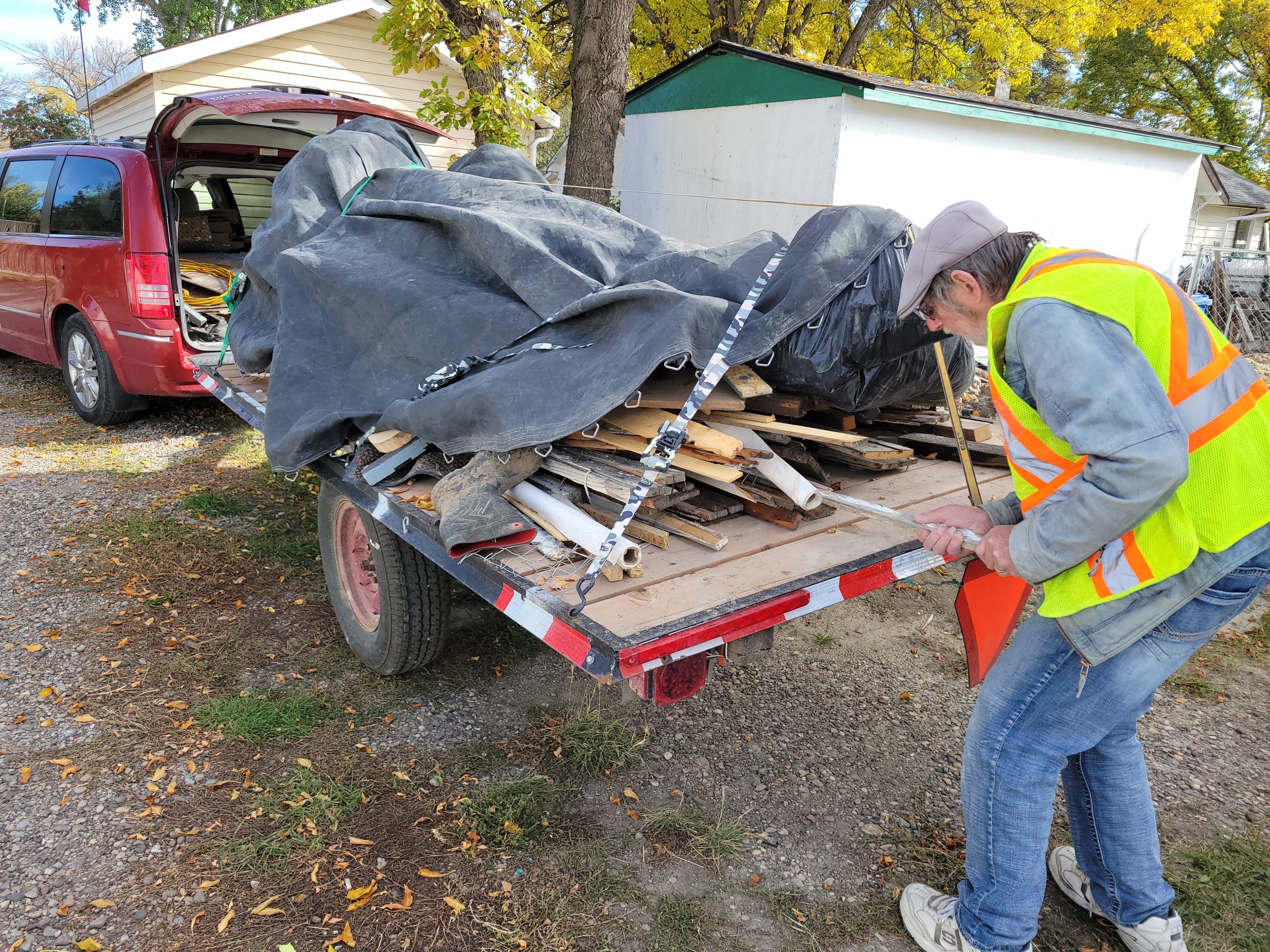

Floyd cleaned the kitchen drawers a while ago, so not much to do there except to take them out and clean the interior walls of the cabinet.

The oven’s self-clean feature was used.  It made the kitchen toasty warm, nice on such a rainy day.

Read more

clean, paint, clean, paint…

Cleaning and painting day!

Clean the shower (long overdue) …

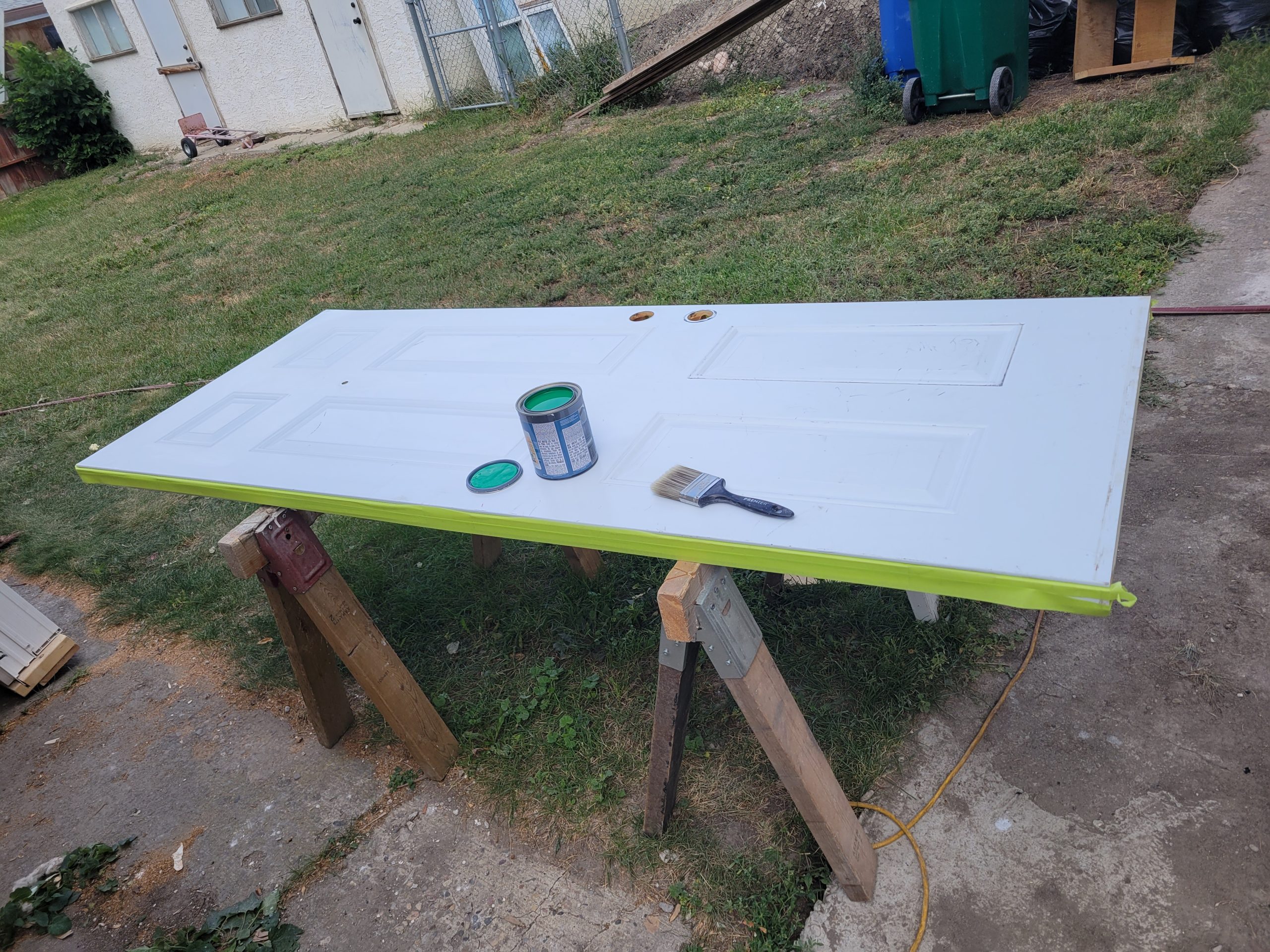

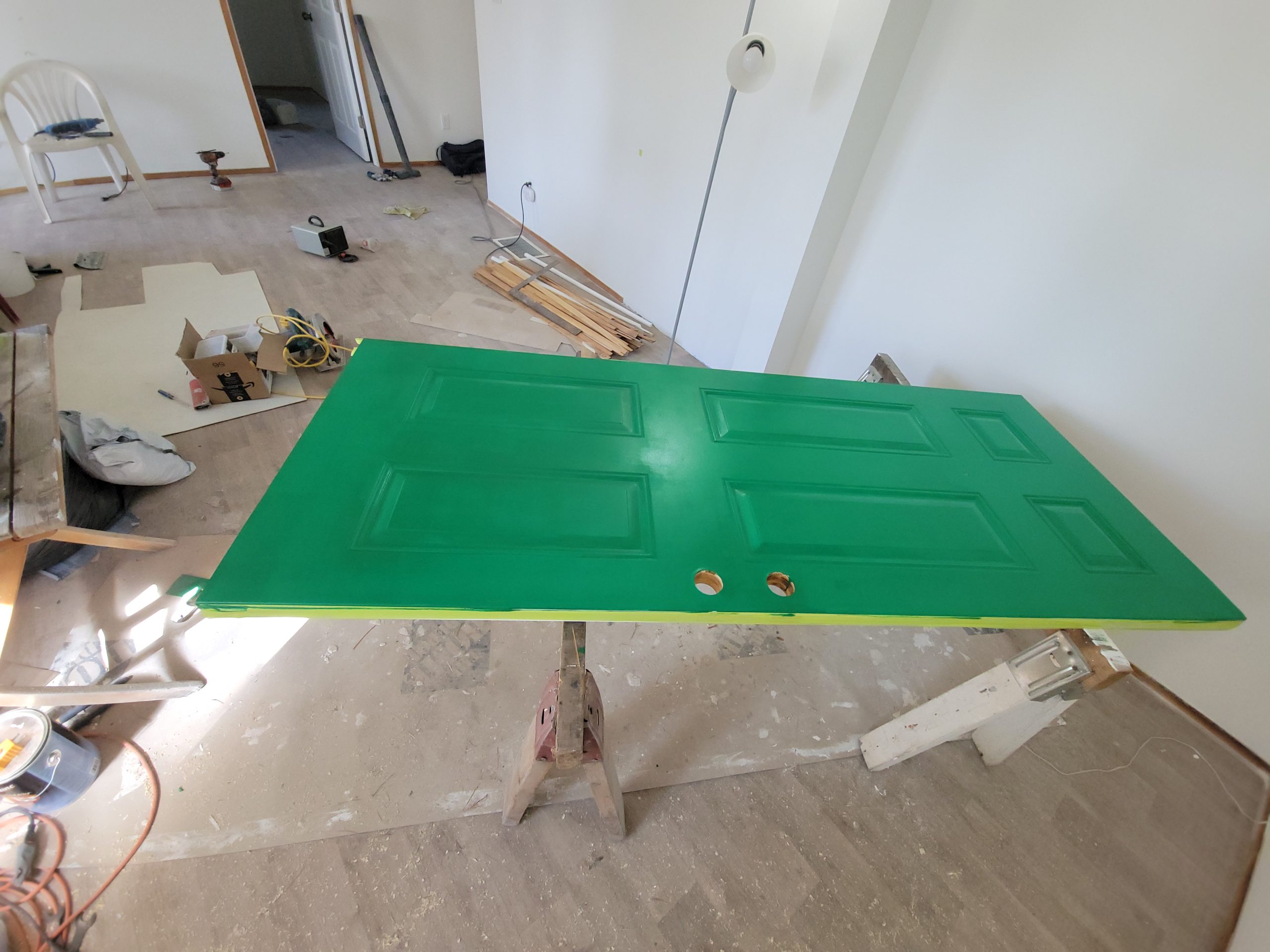

… and the front door (the unpainted side).

Touch-up paint needed all over the bathroom / laundry room.

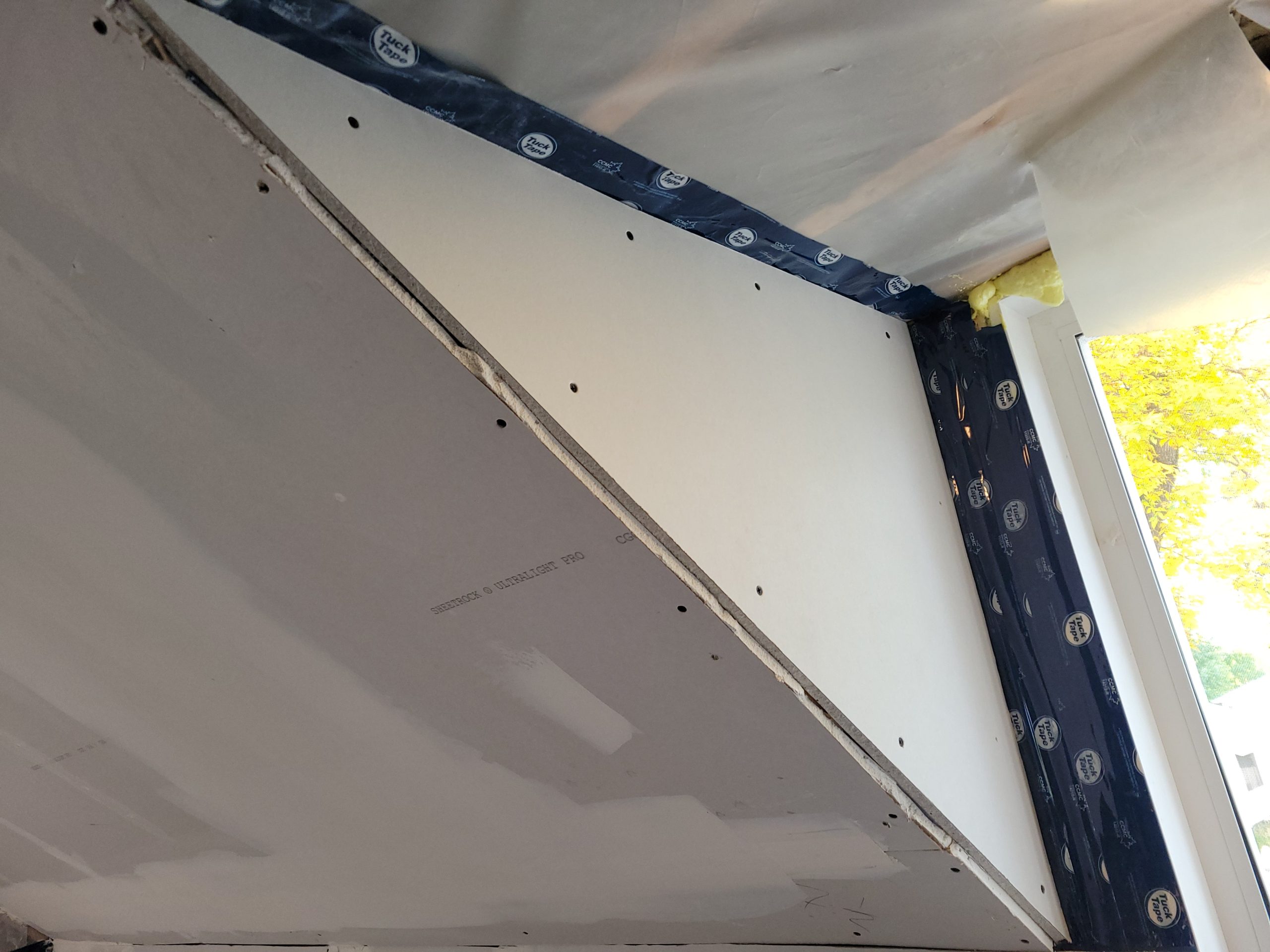

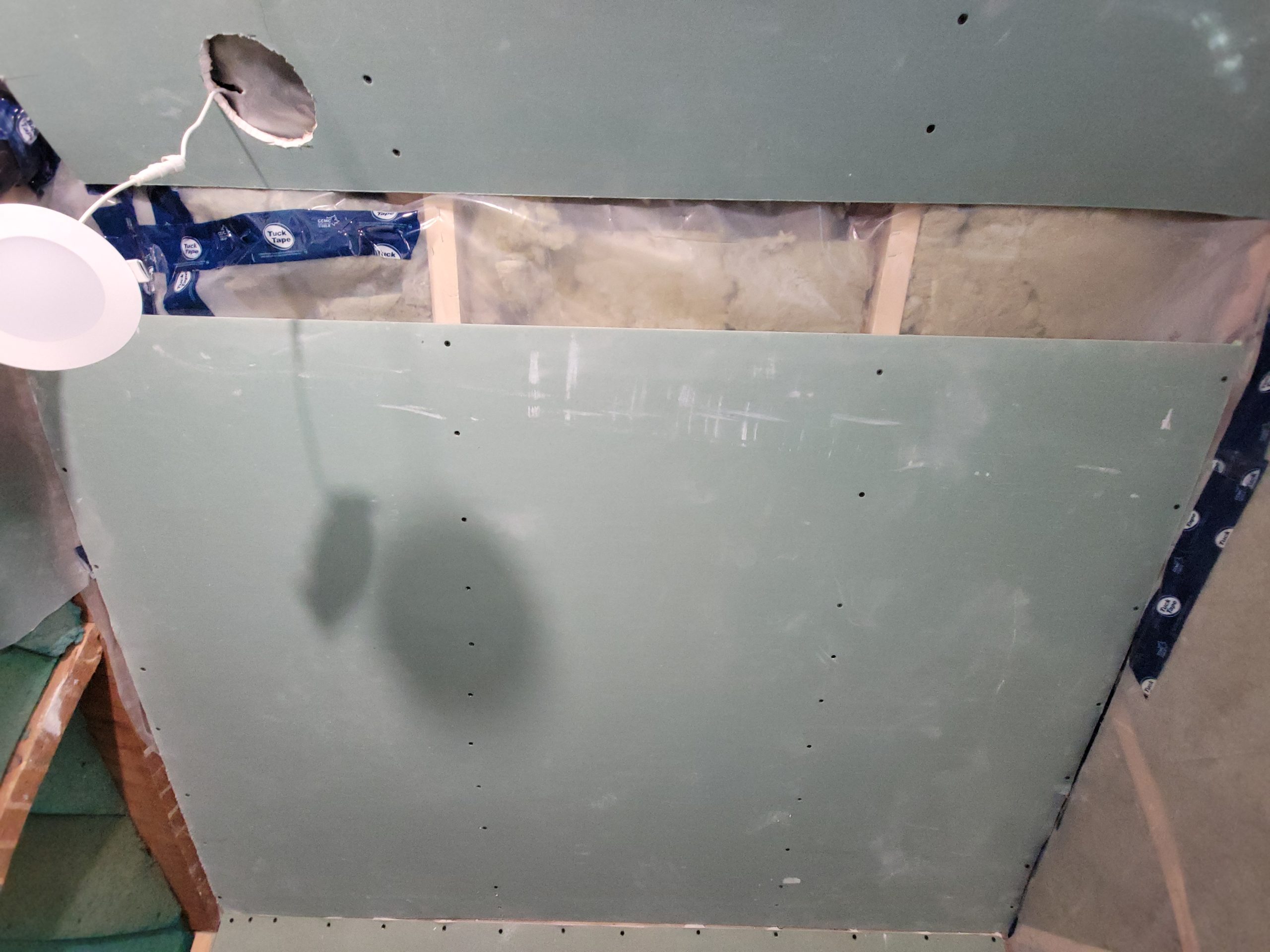

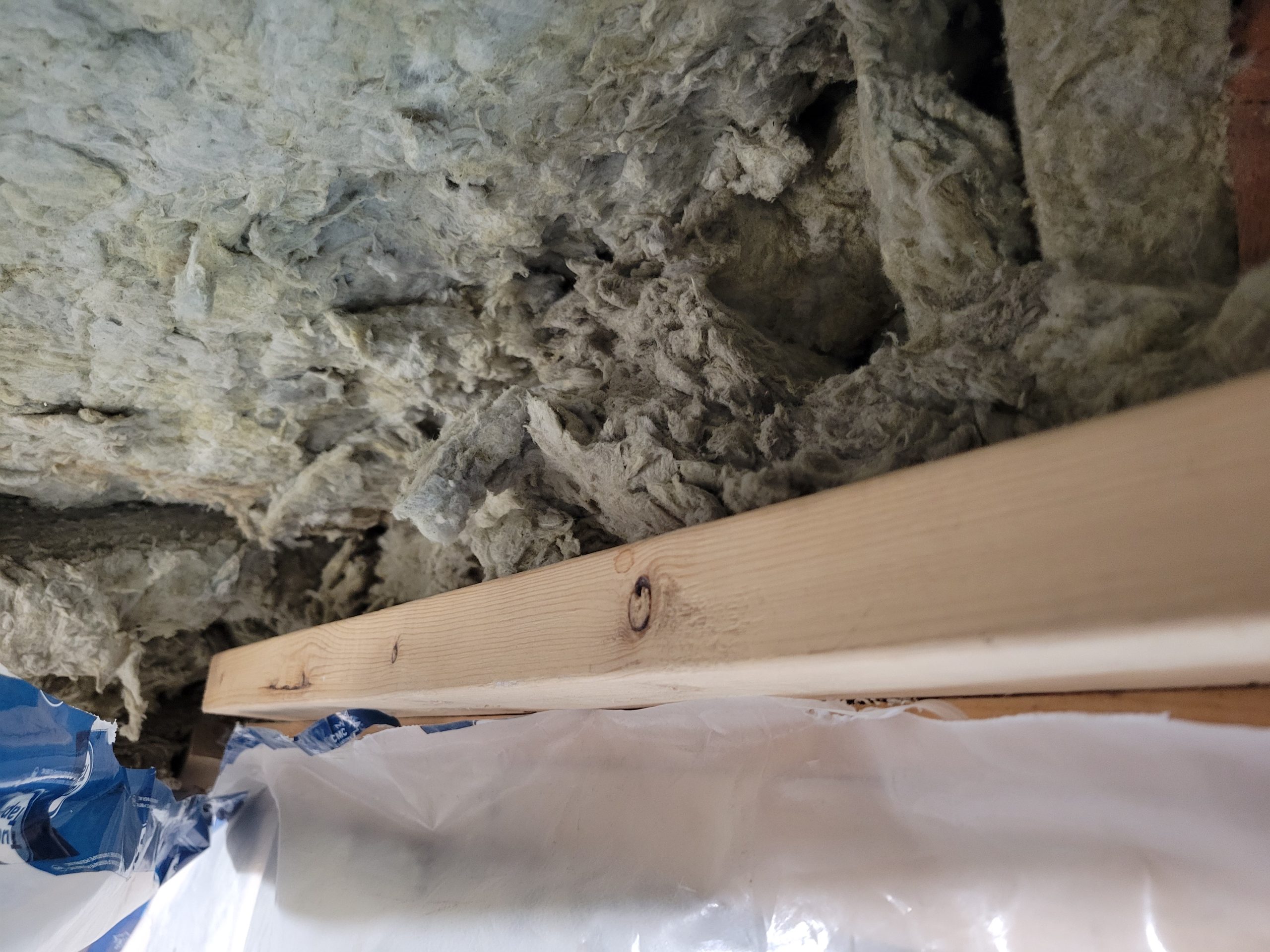

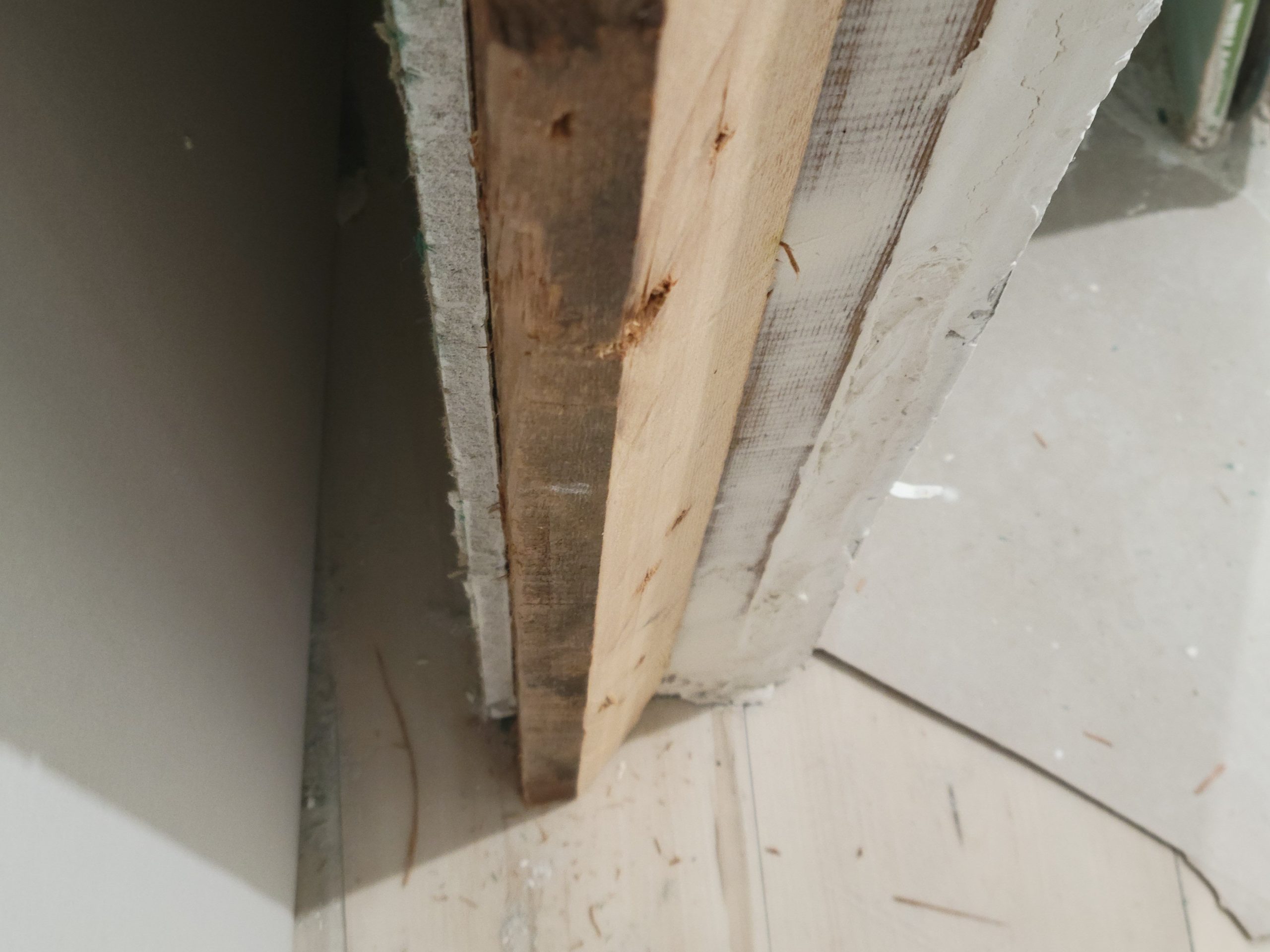

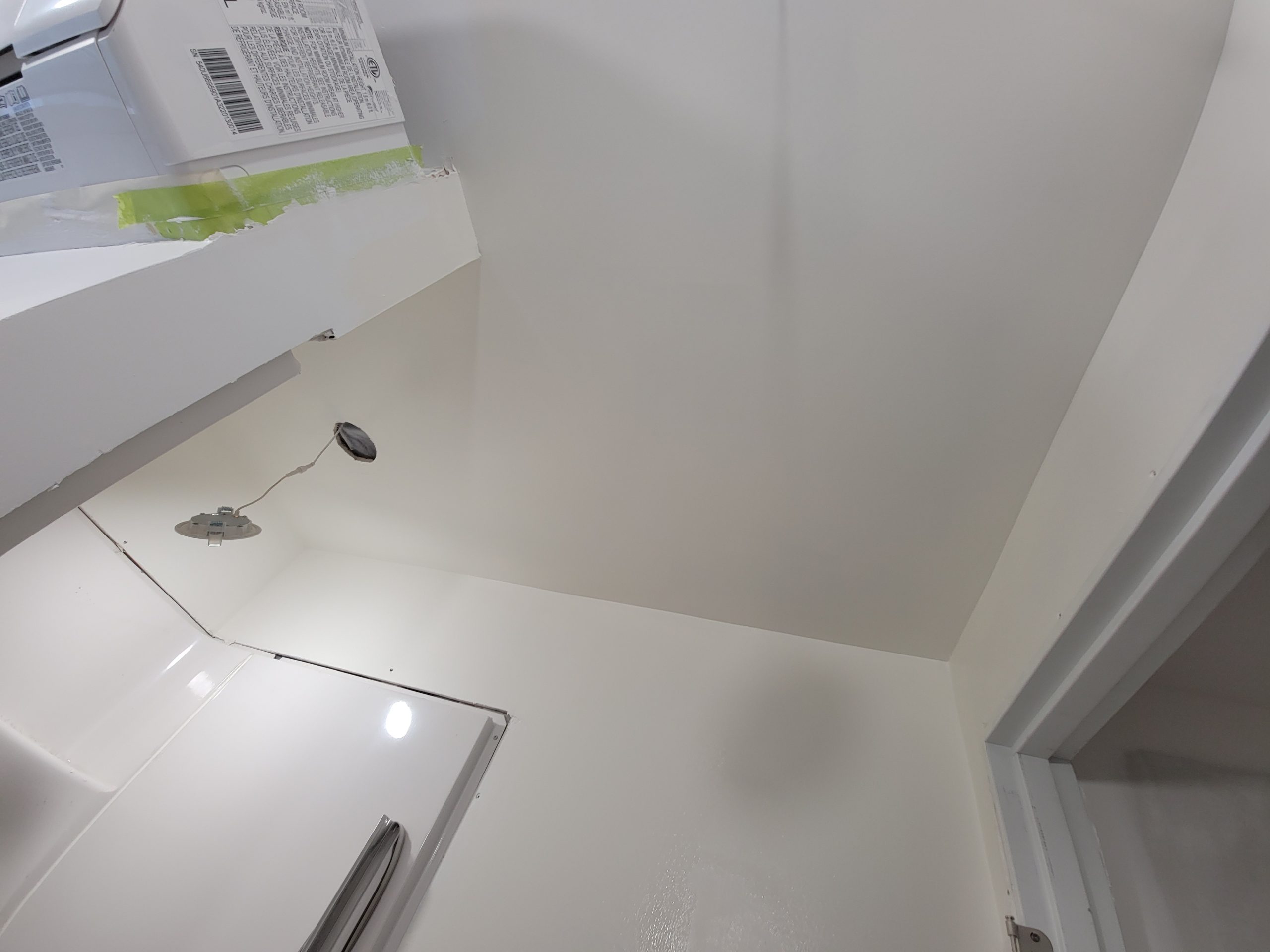

And now the ceiling in bedroom 1.  Some boards were added where they were missing from long ago when they paved over it (or, rather, under it) with ceiling panels.

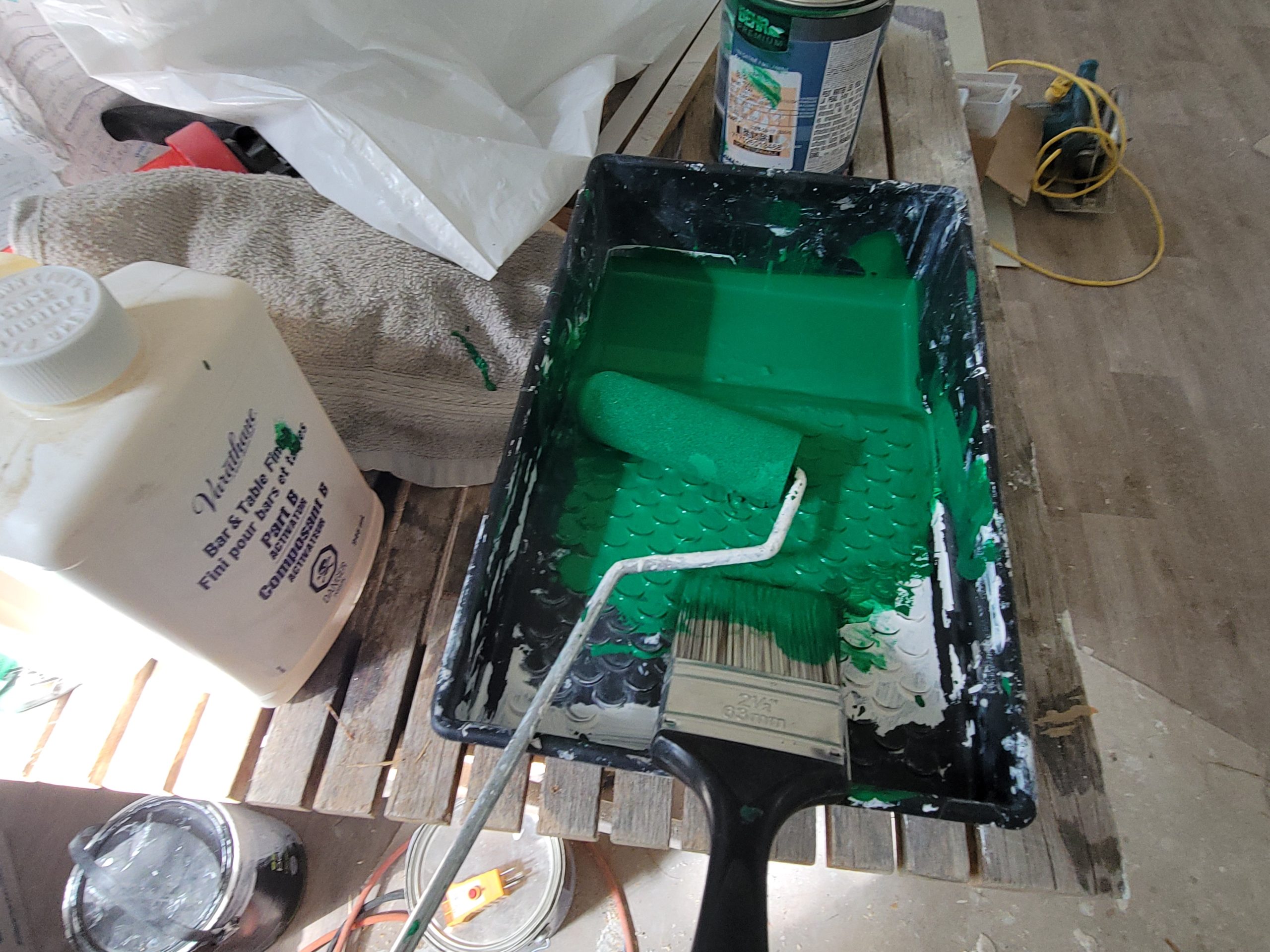

Primer first.

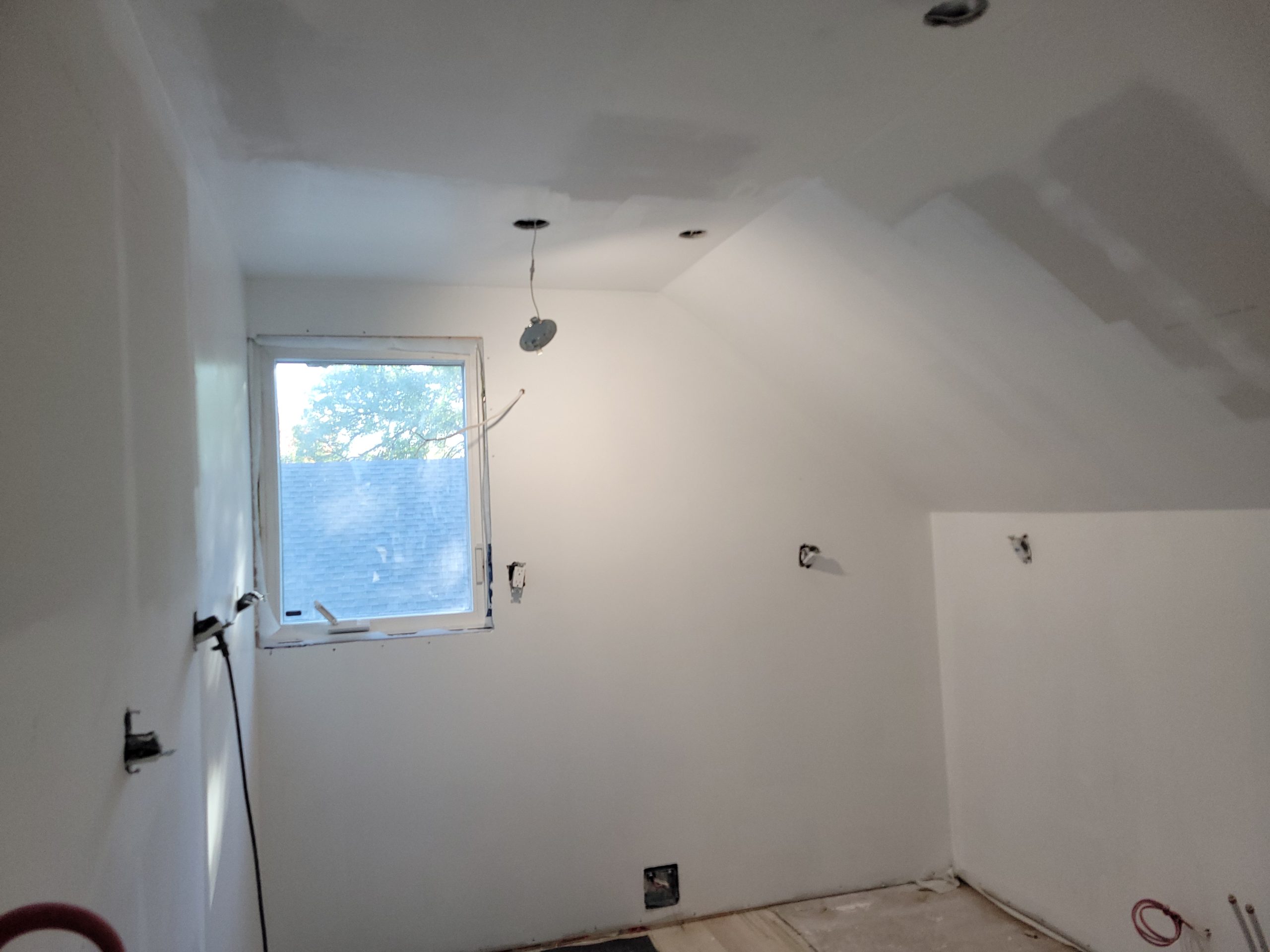

It is covering fairly well.  The roller is kind of useless as it doesn’t get into the grooves (tongue-and-groove boards).

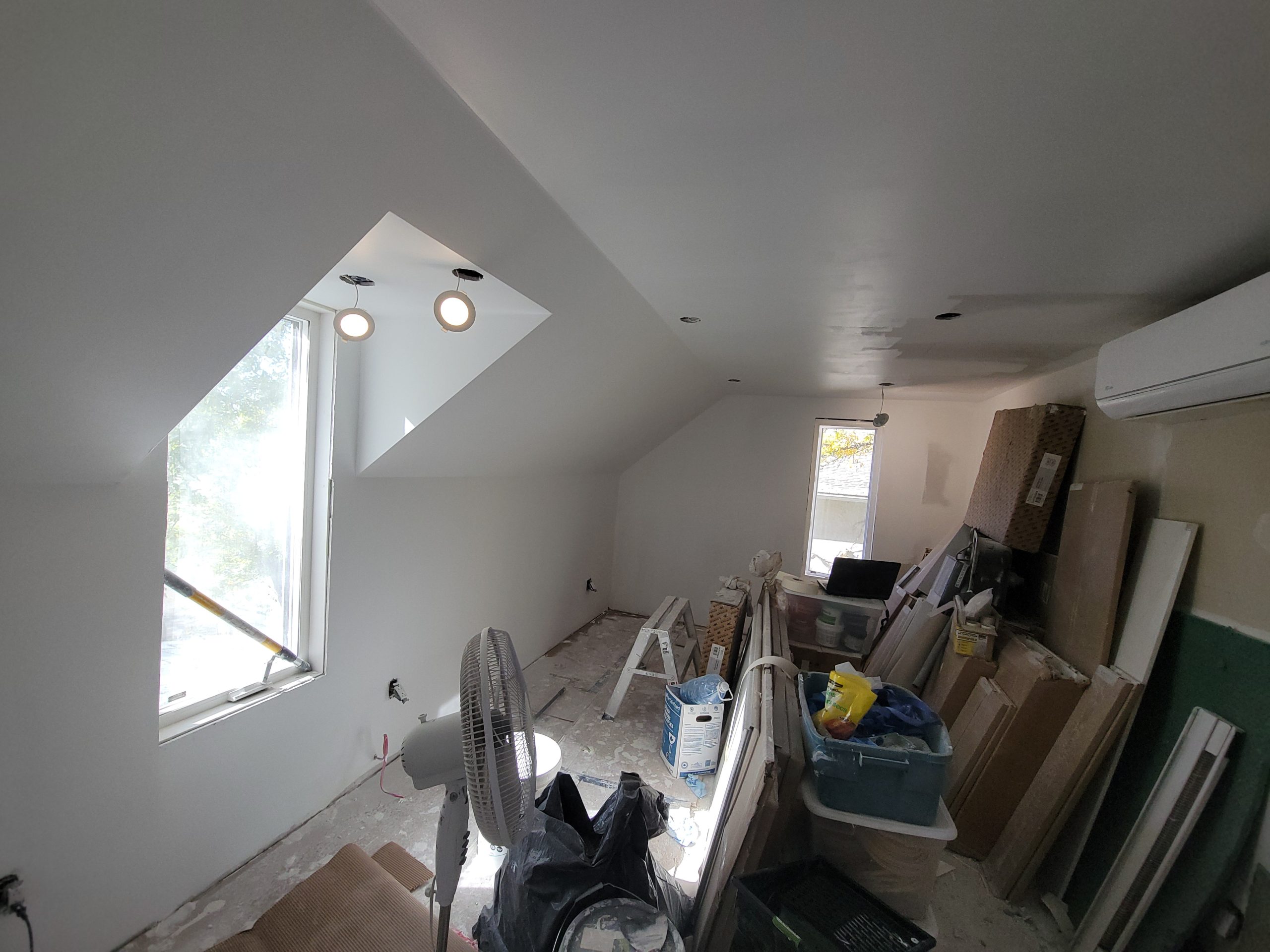

The priming is finished.  Next, paint.  I wonder how it will turn out.

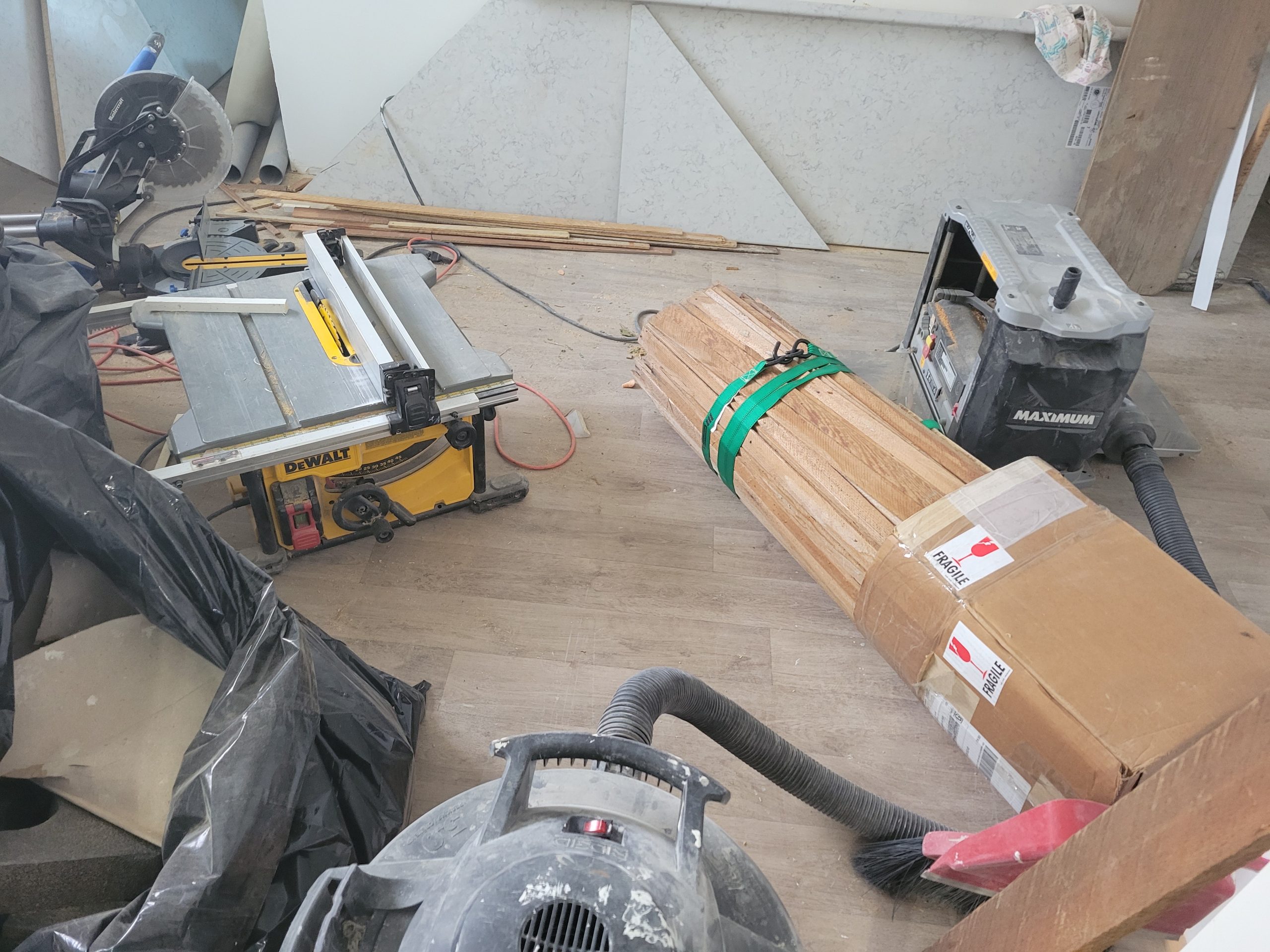

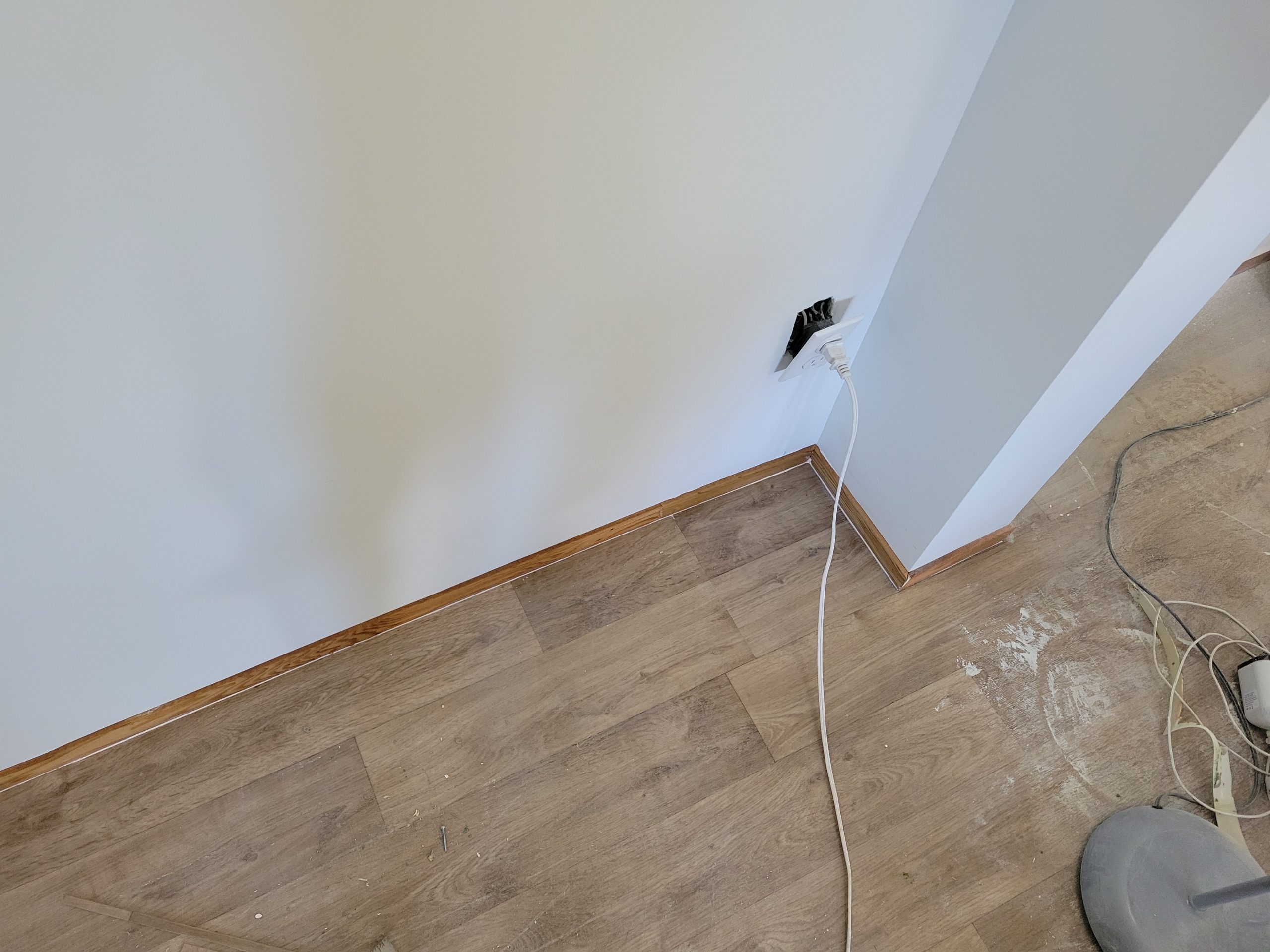

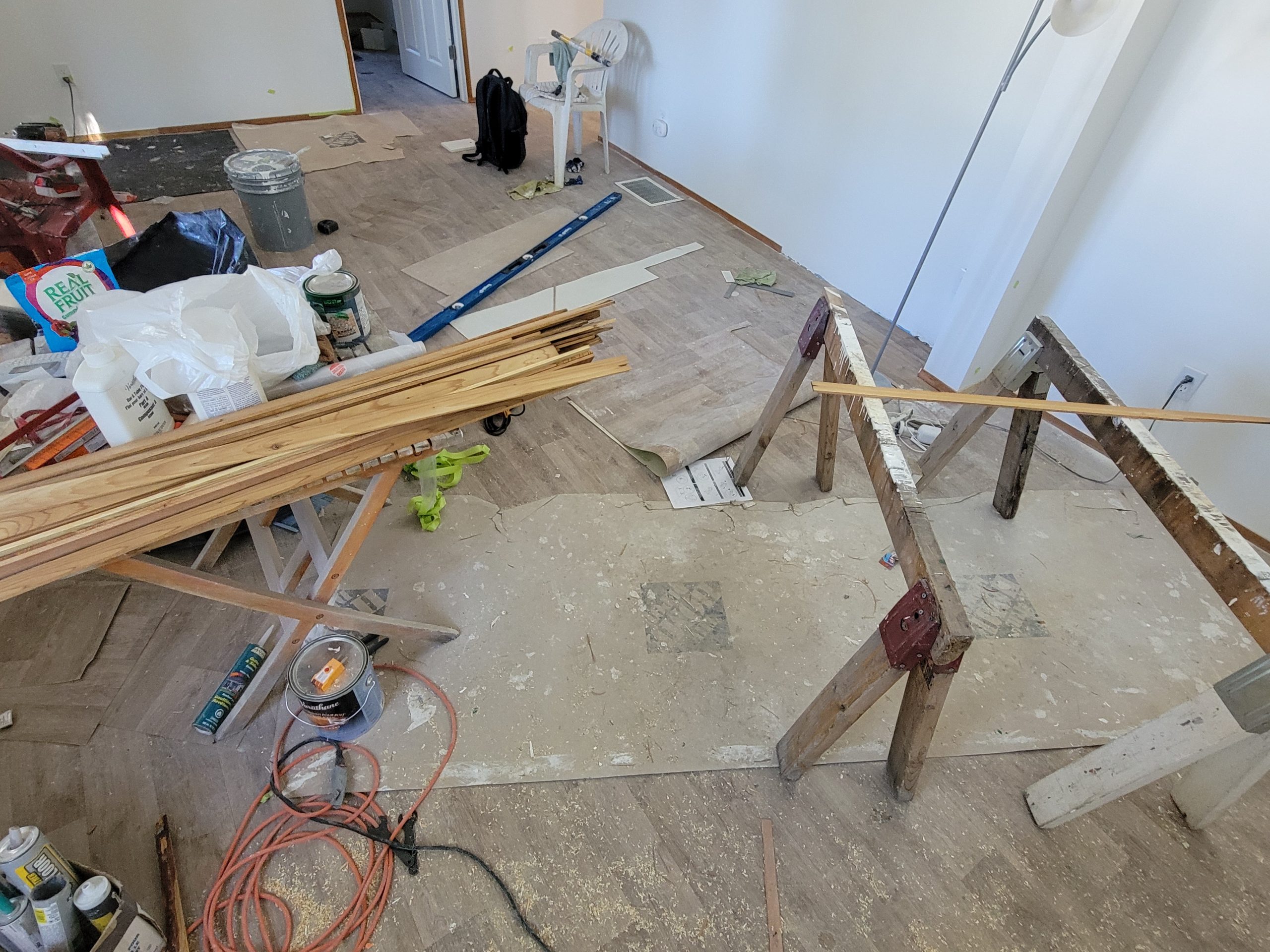

Next, the trim boards.  I hope it looks sharp.

And now it is complete.  I think it looks good.

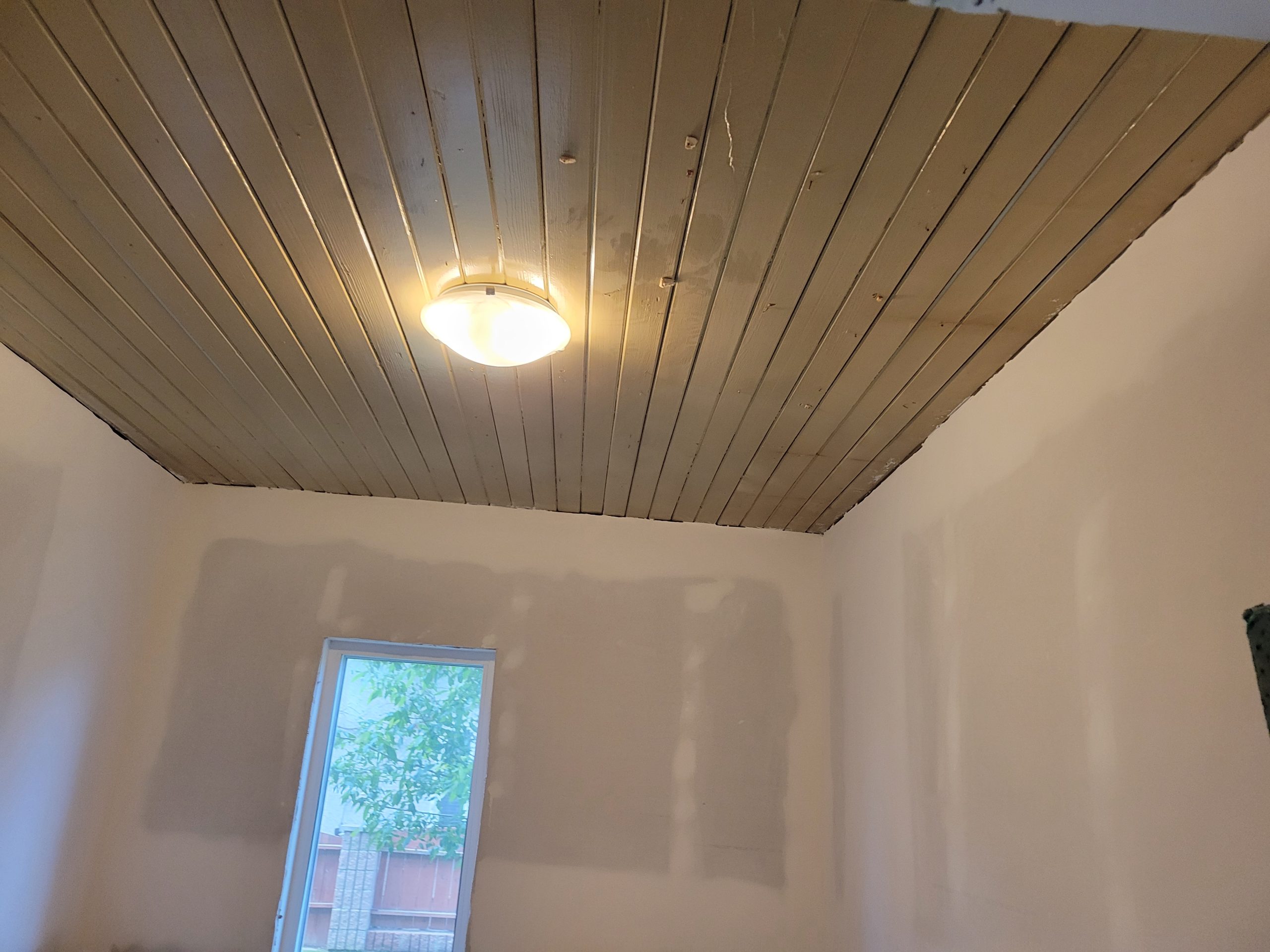

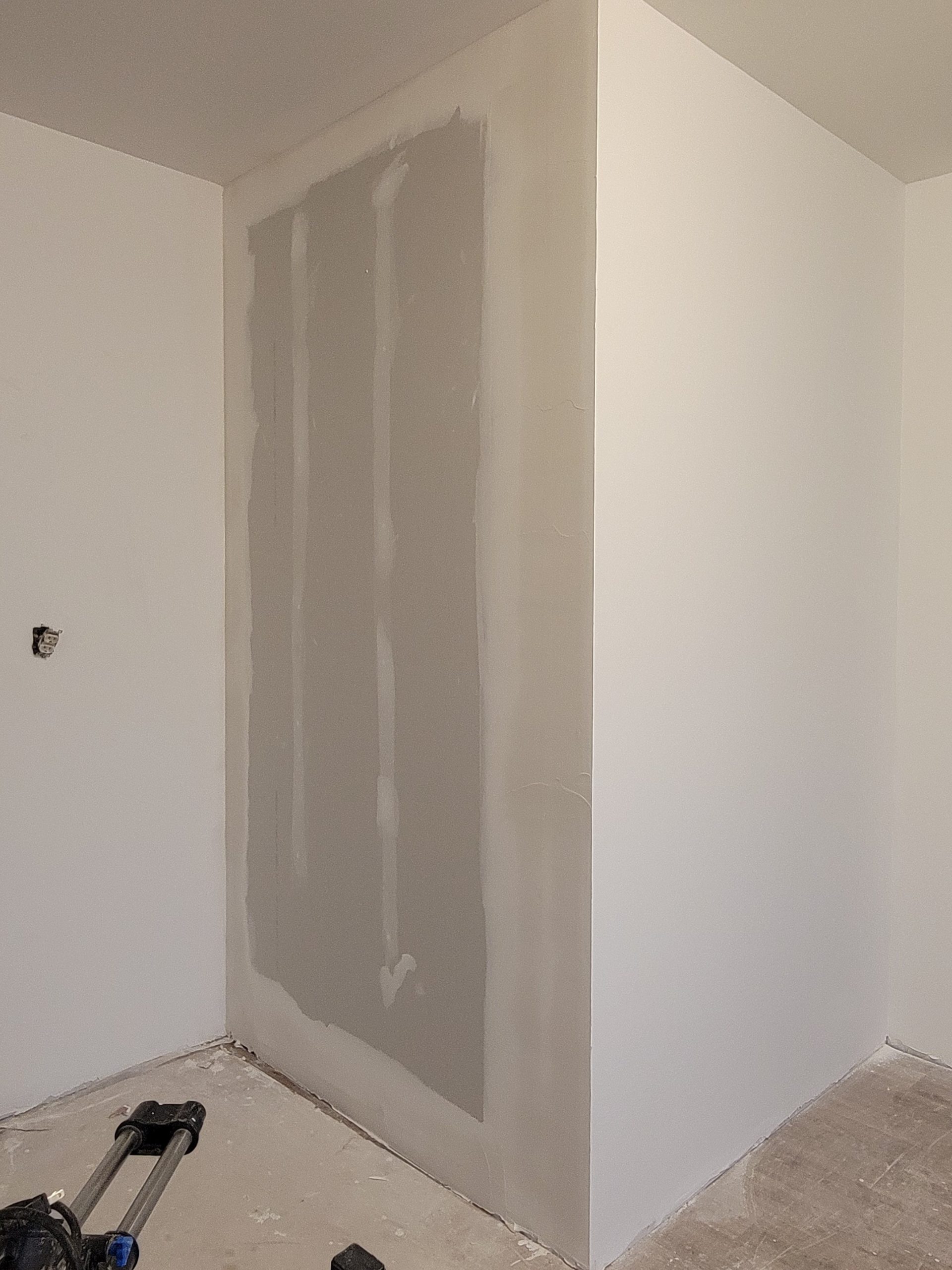

Now for bedroom 2.  I started out by cleaning the drywall mud off the ceiling boards but found that it can actually be washed.  Because there were no missing boards, and the paint wasn’t in such bad shape (only nail holes), I decided to leave it in its original 1940s paint scheme.

So I started washing it using antibacterial Windex, but this is hard work, and my tennis elbow finally had enough.

I’ll continue in the morning.

trim, med cab, etc

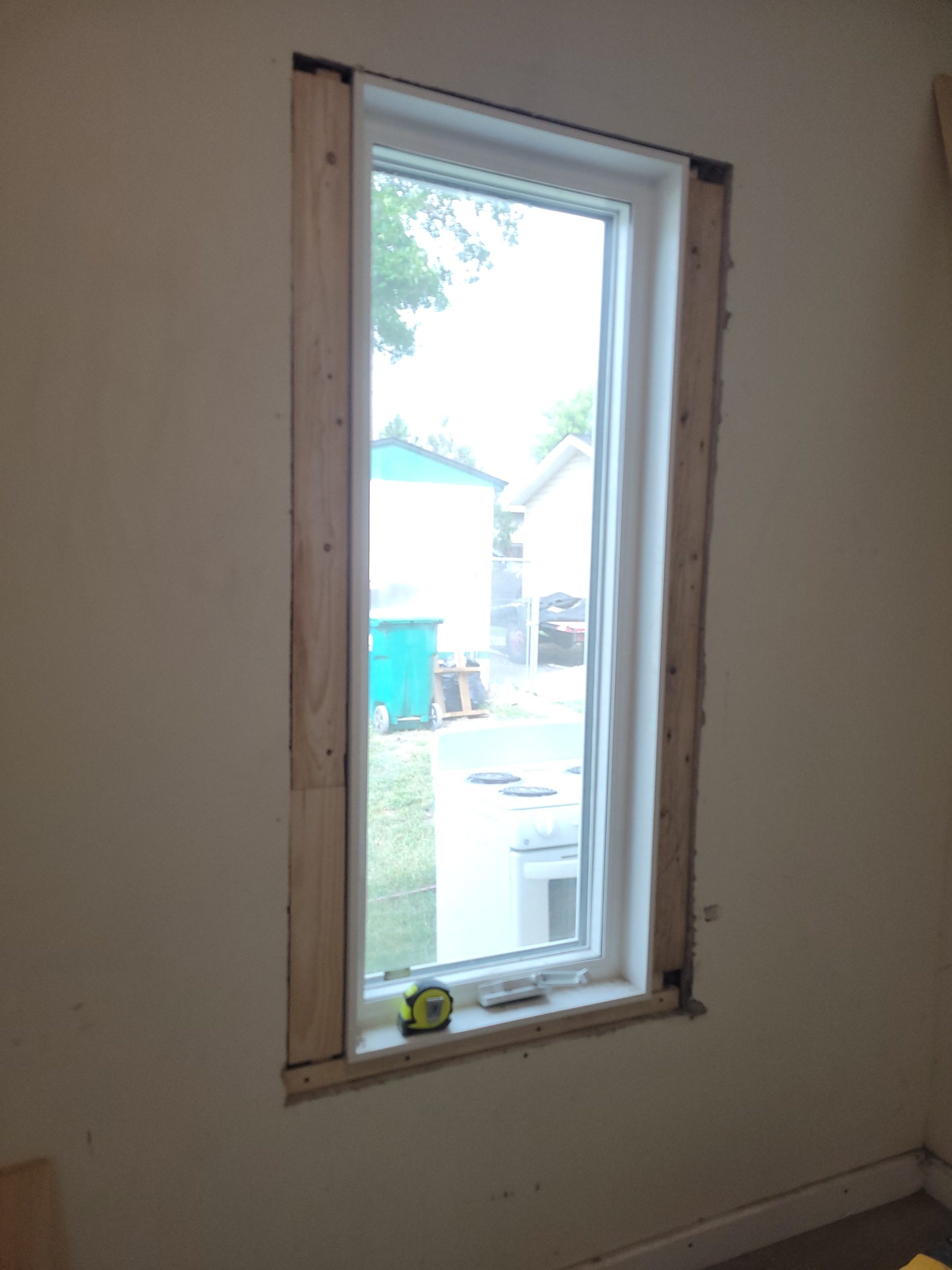

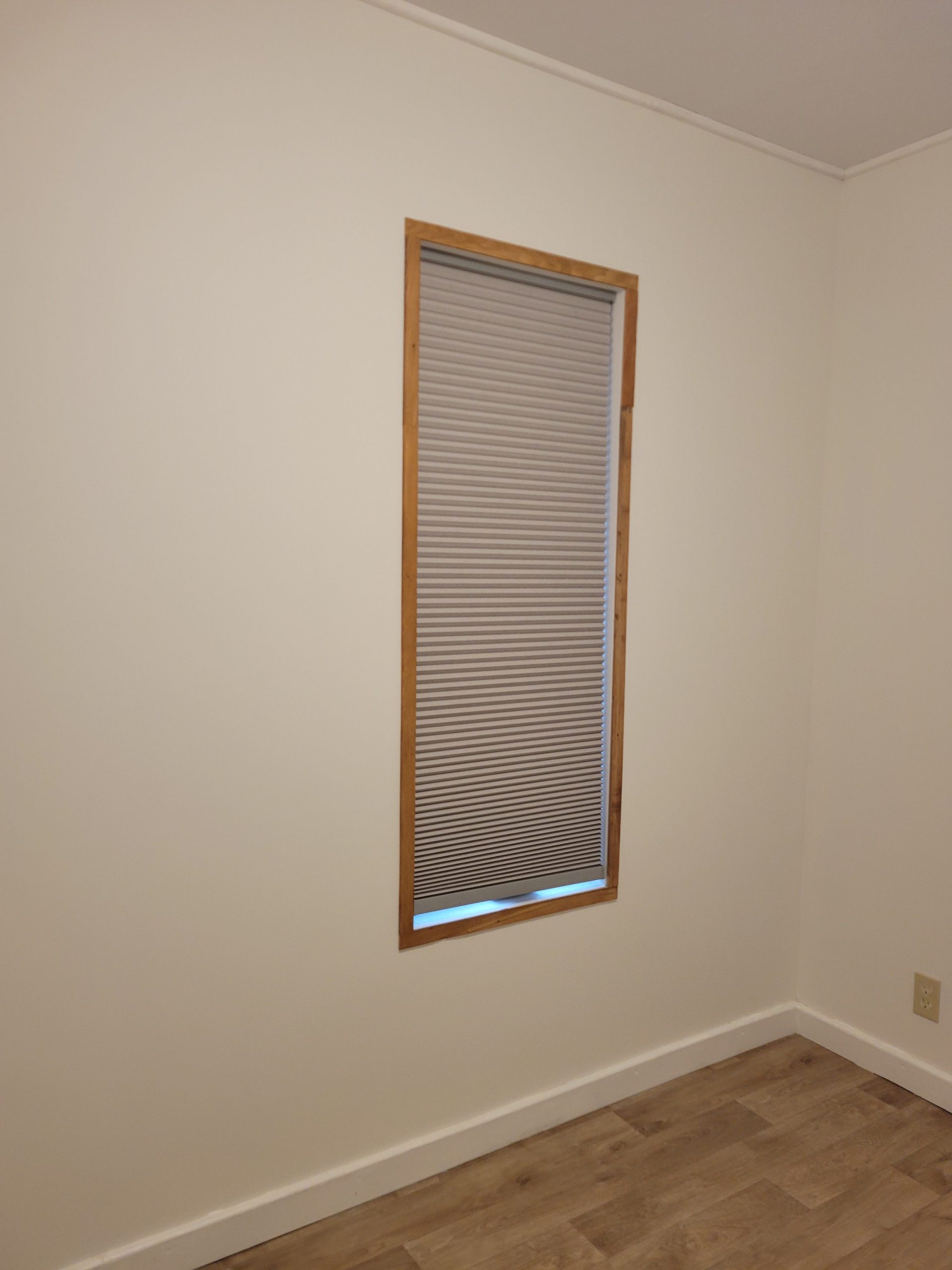

The blind for bedroom 3 finally fits.

A 2nd coat of white trim paint was added to the bathroom window.

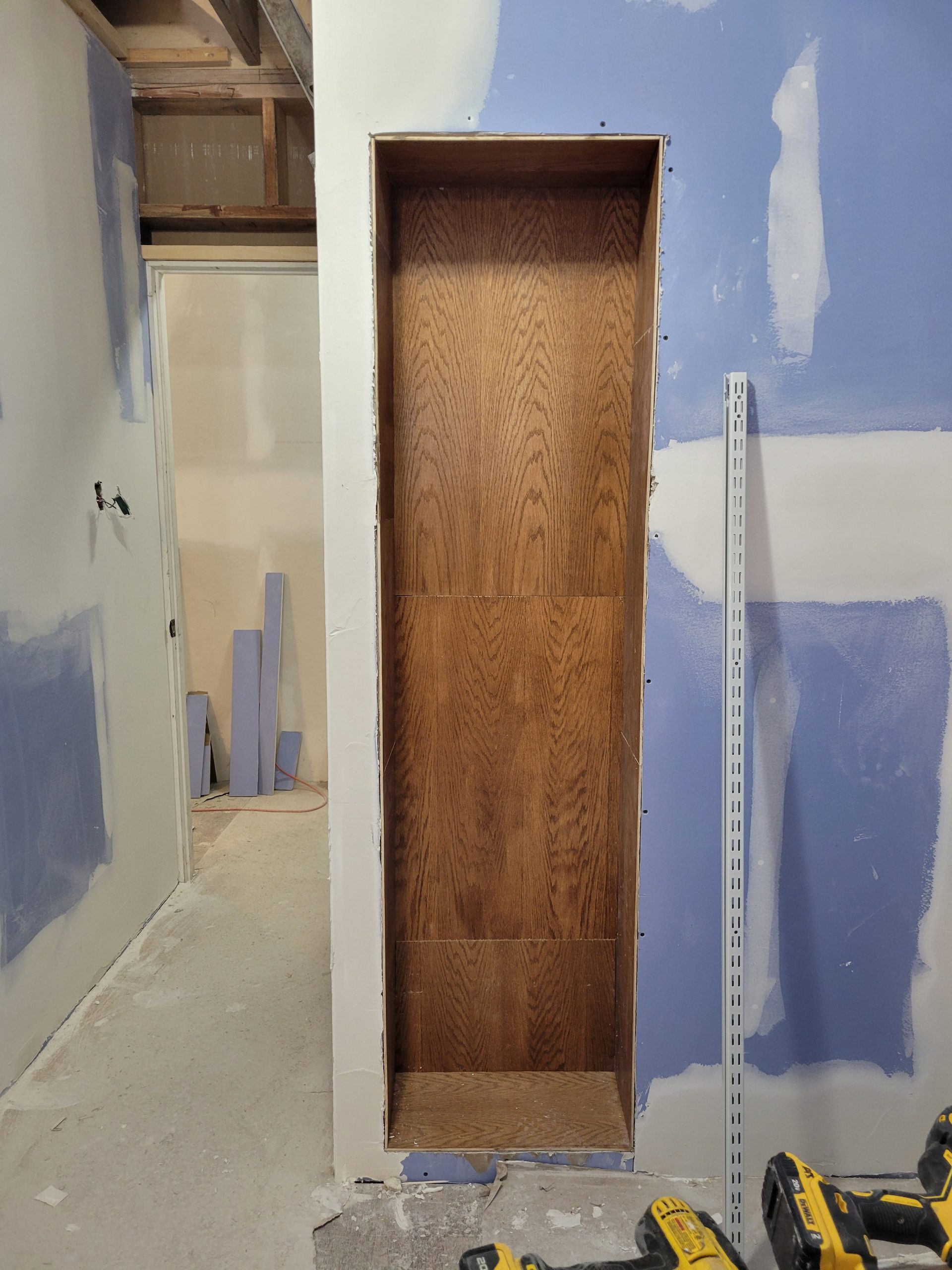

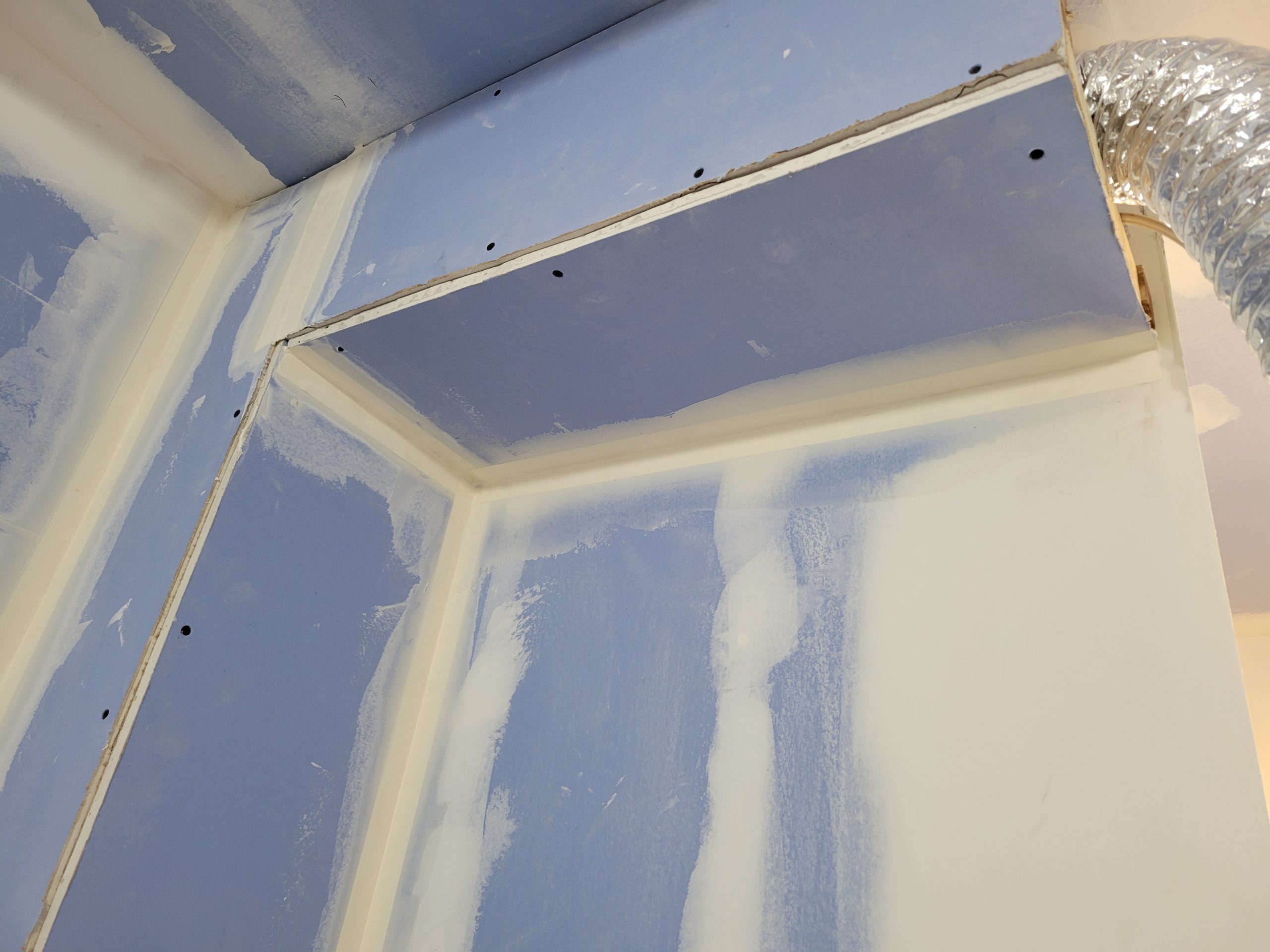

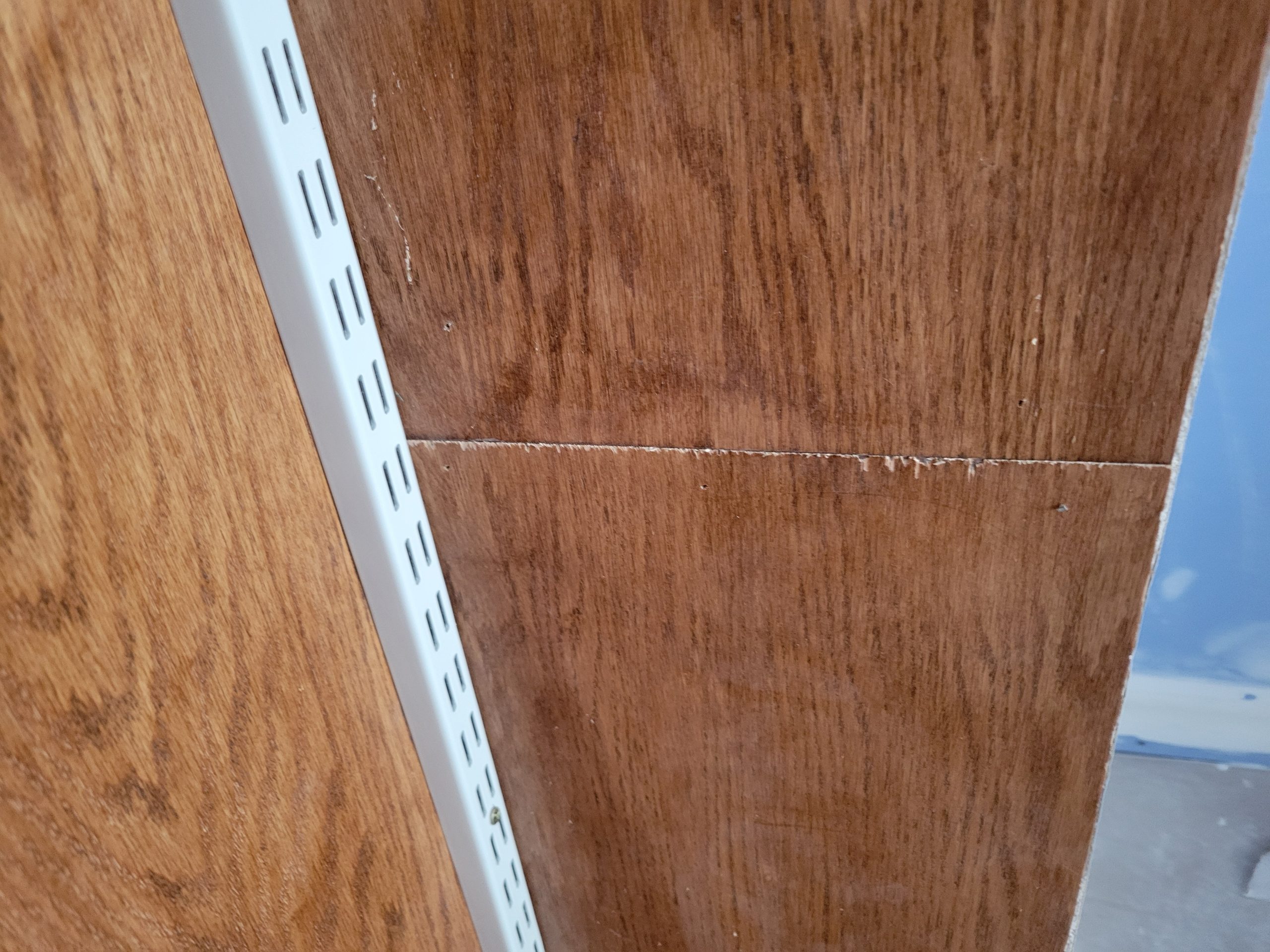

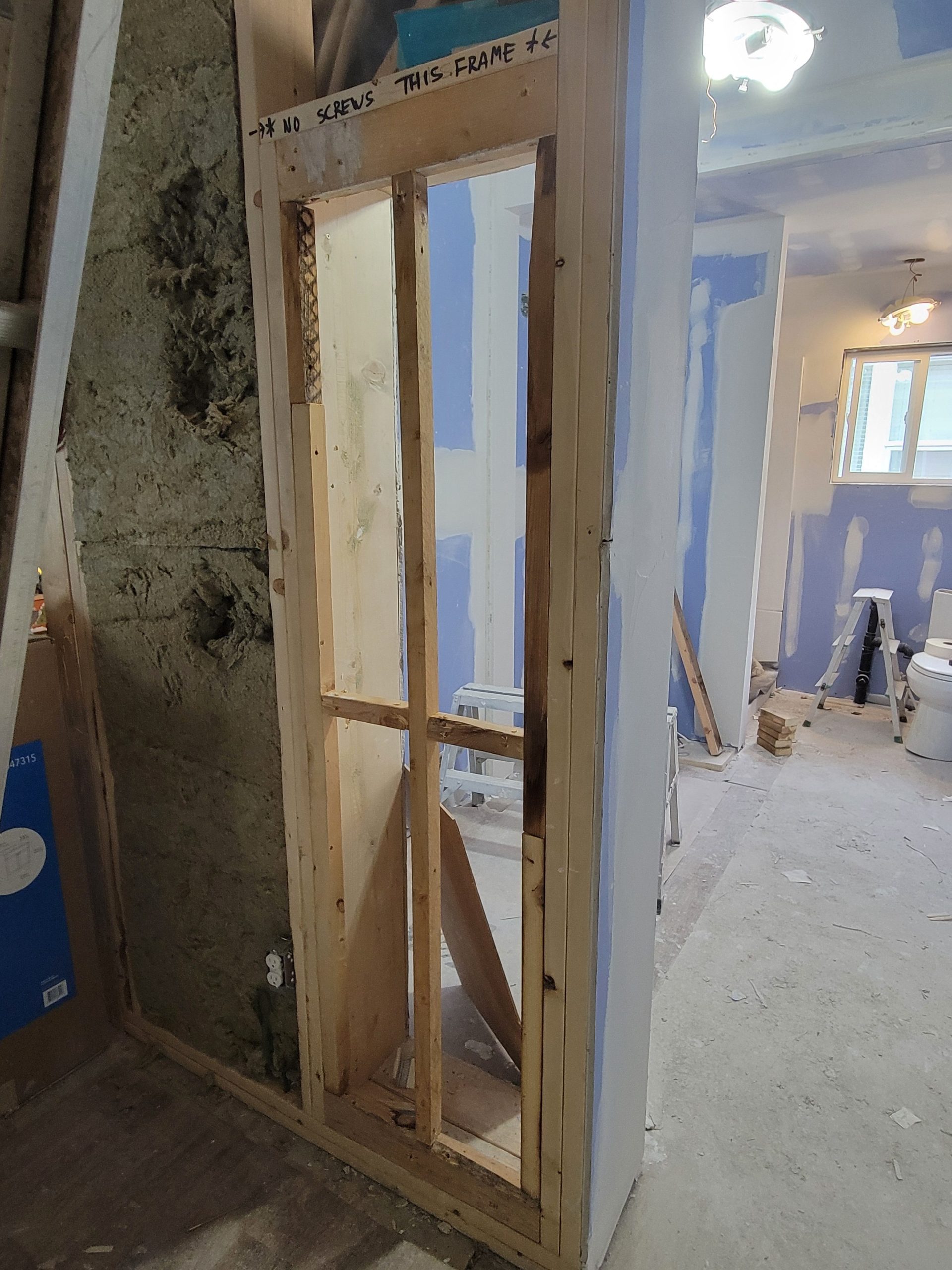

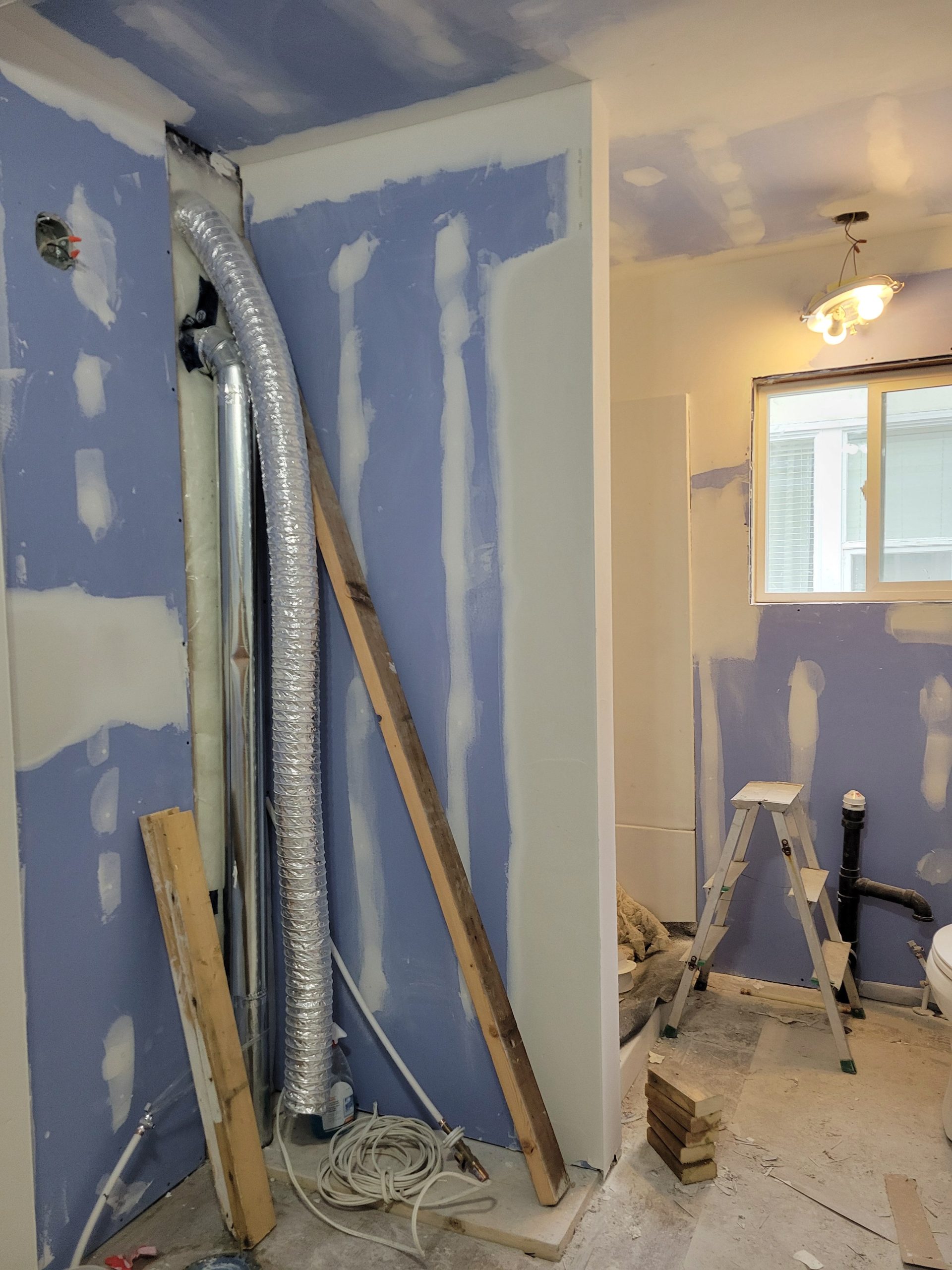

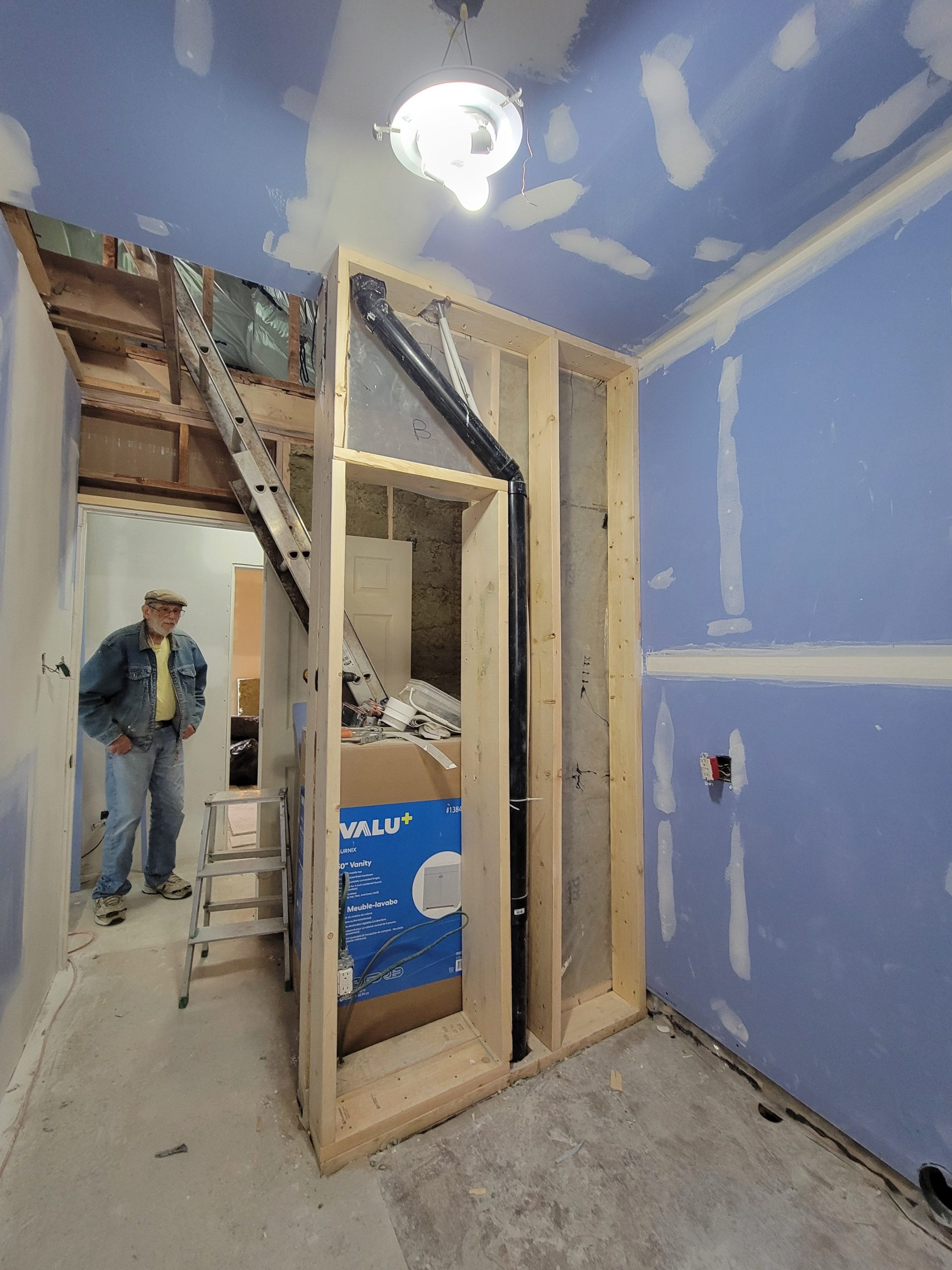

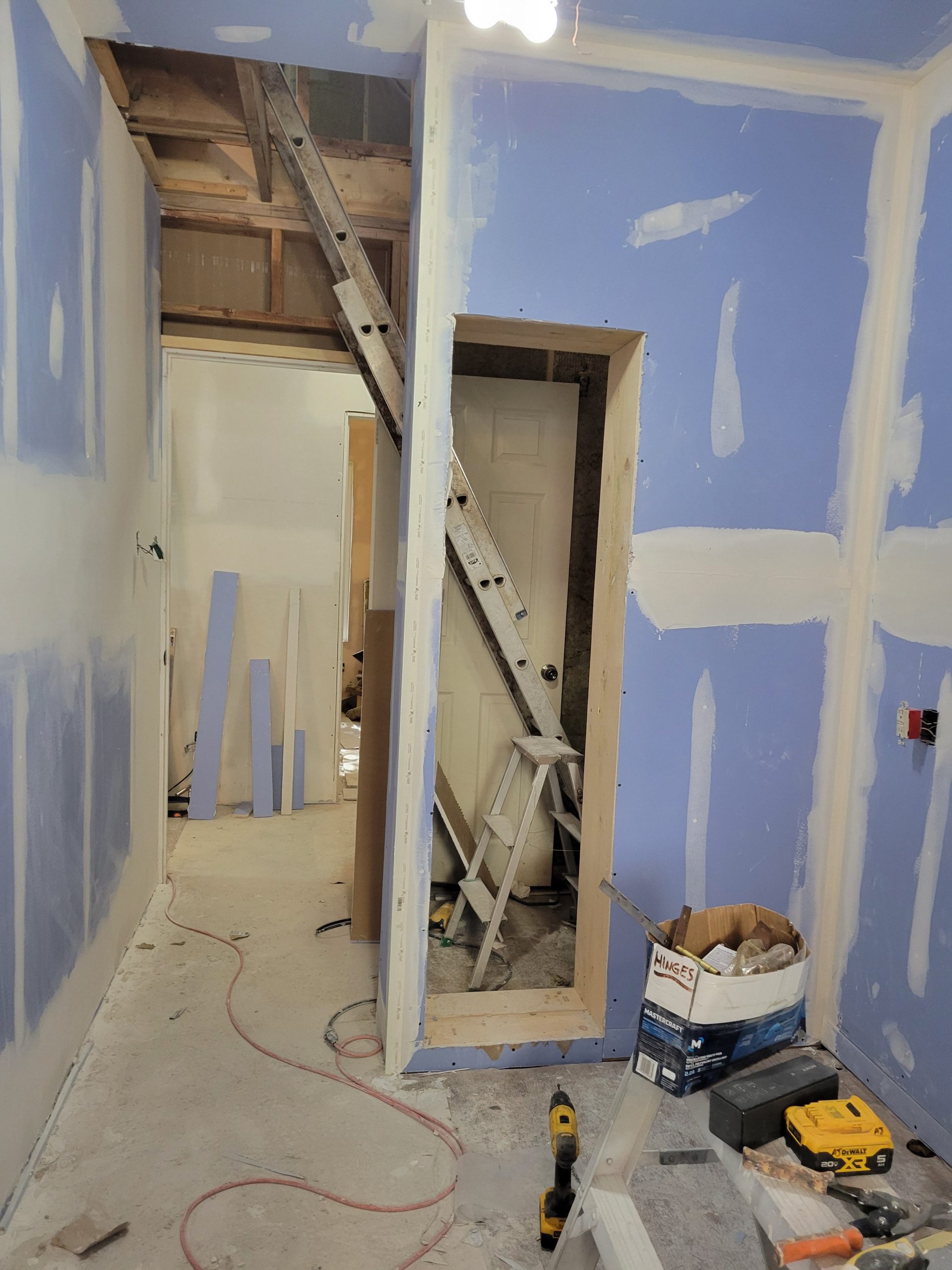

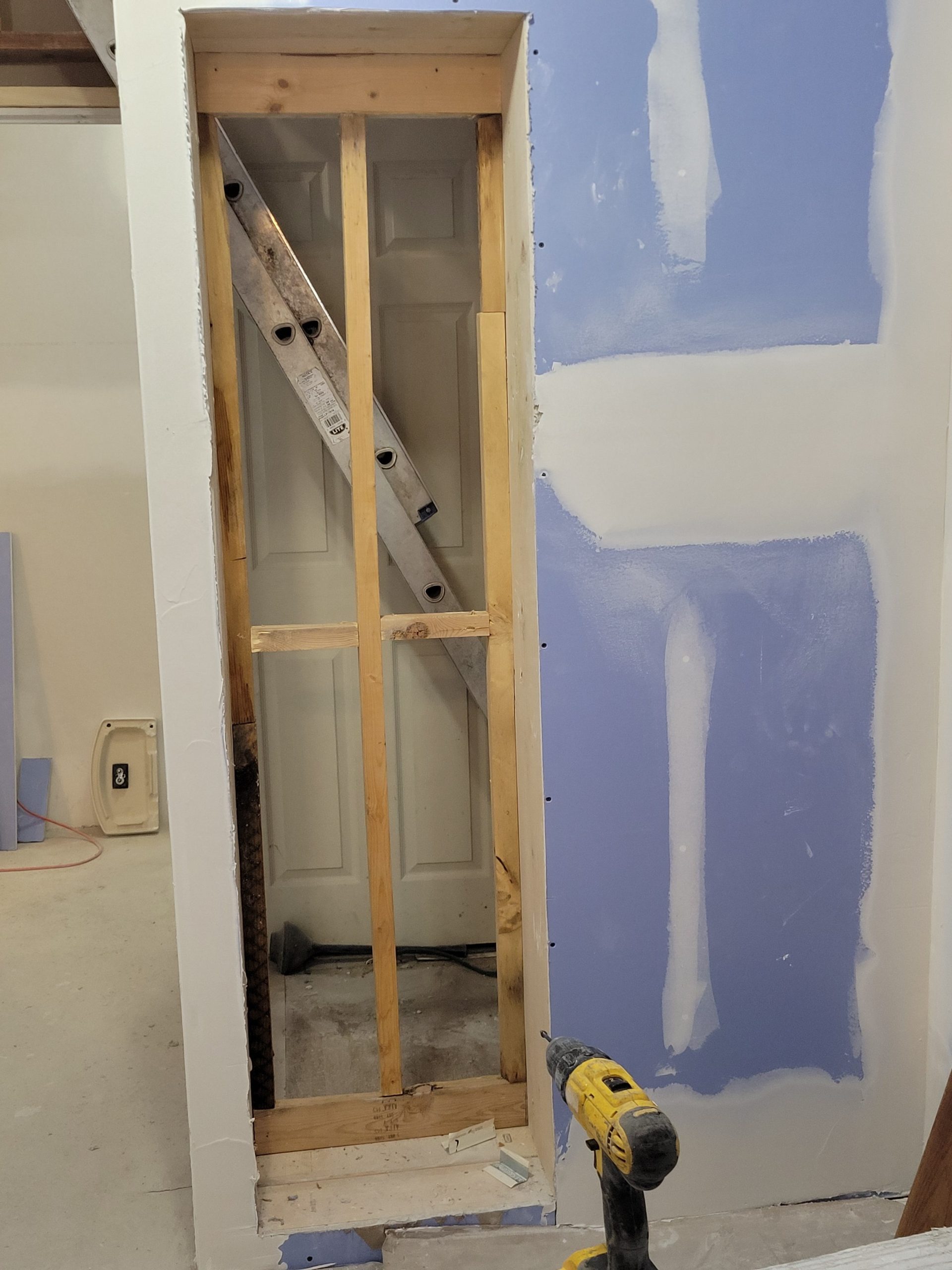

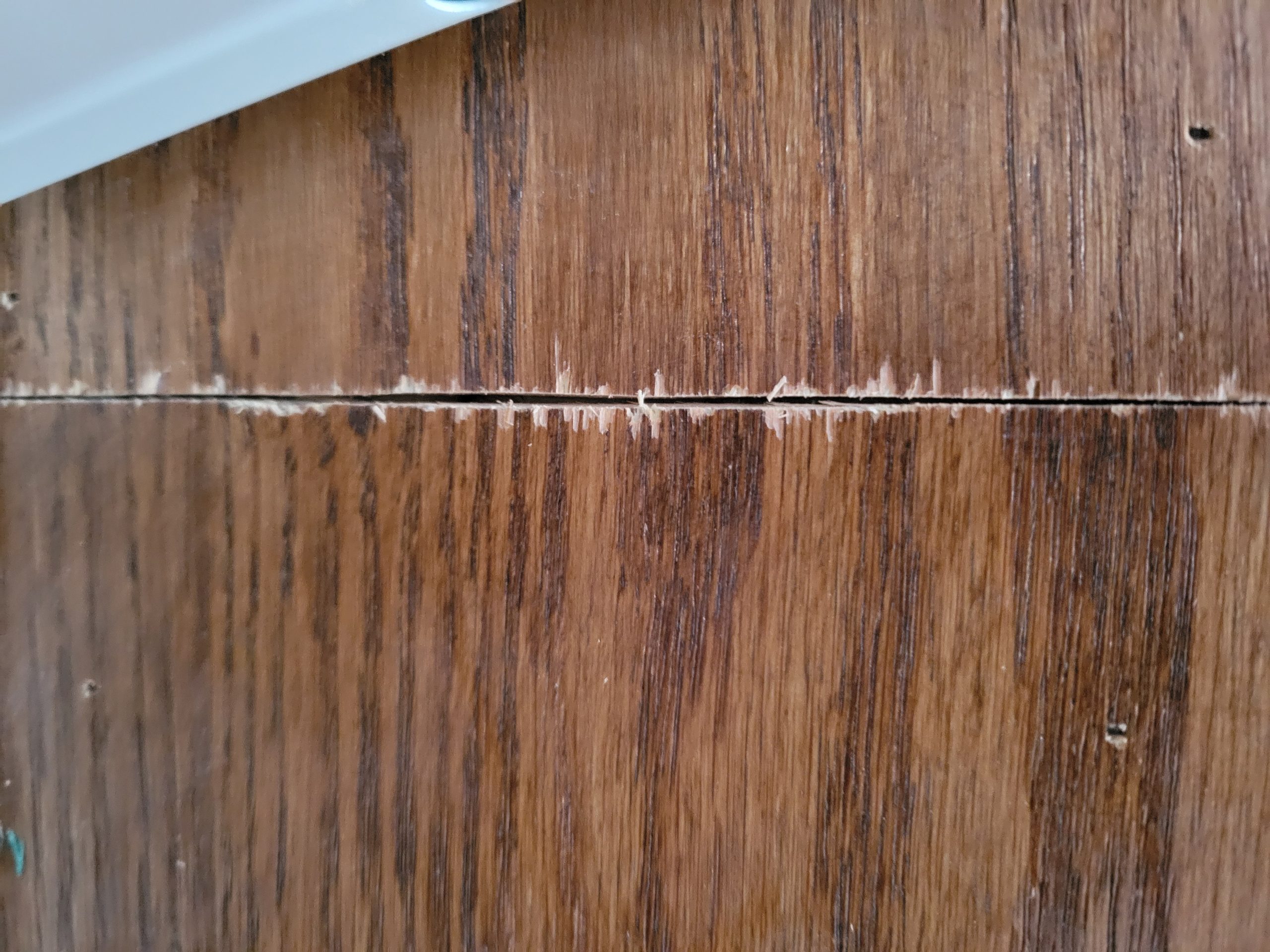

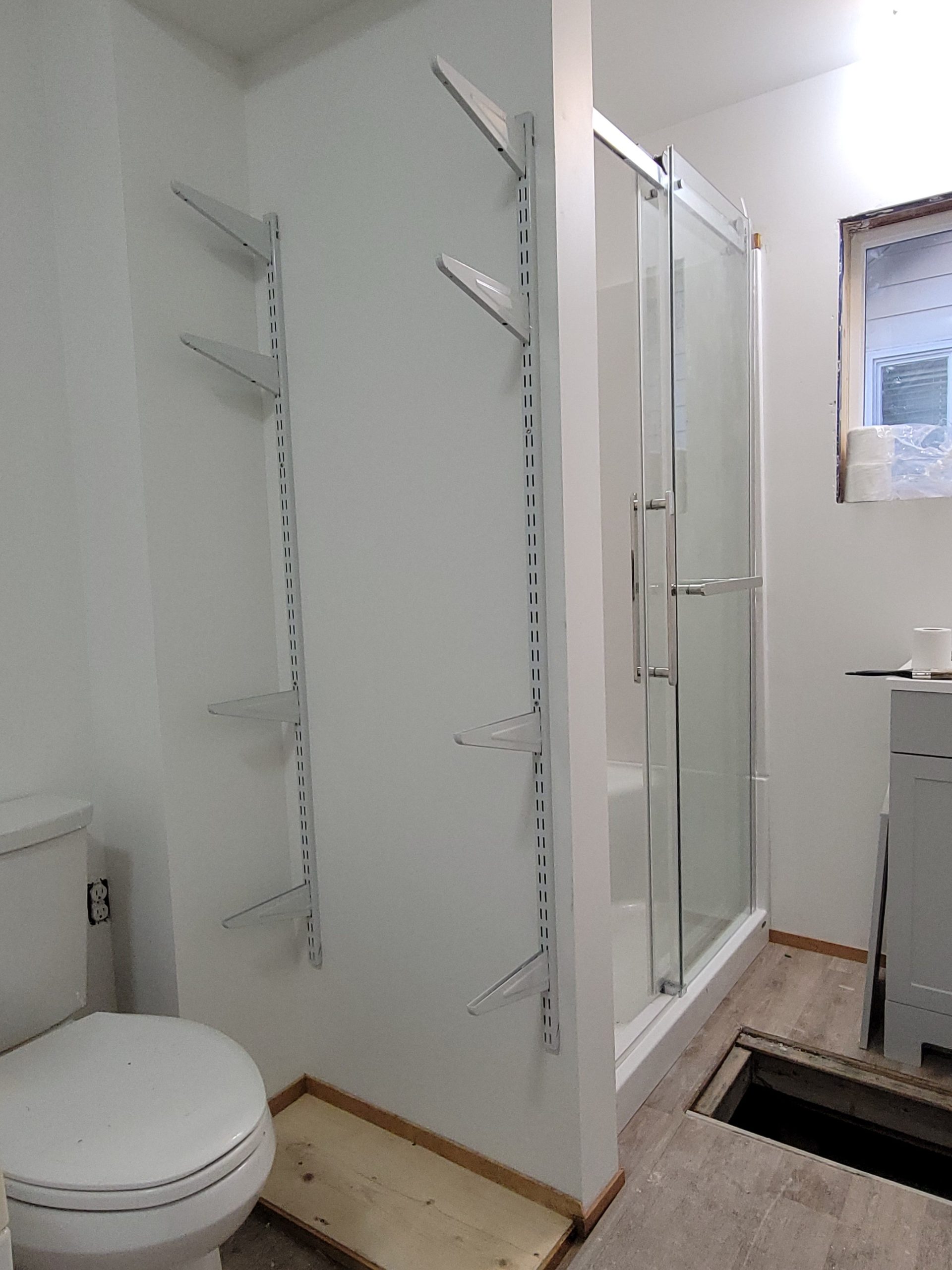

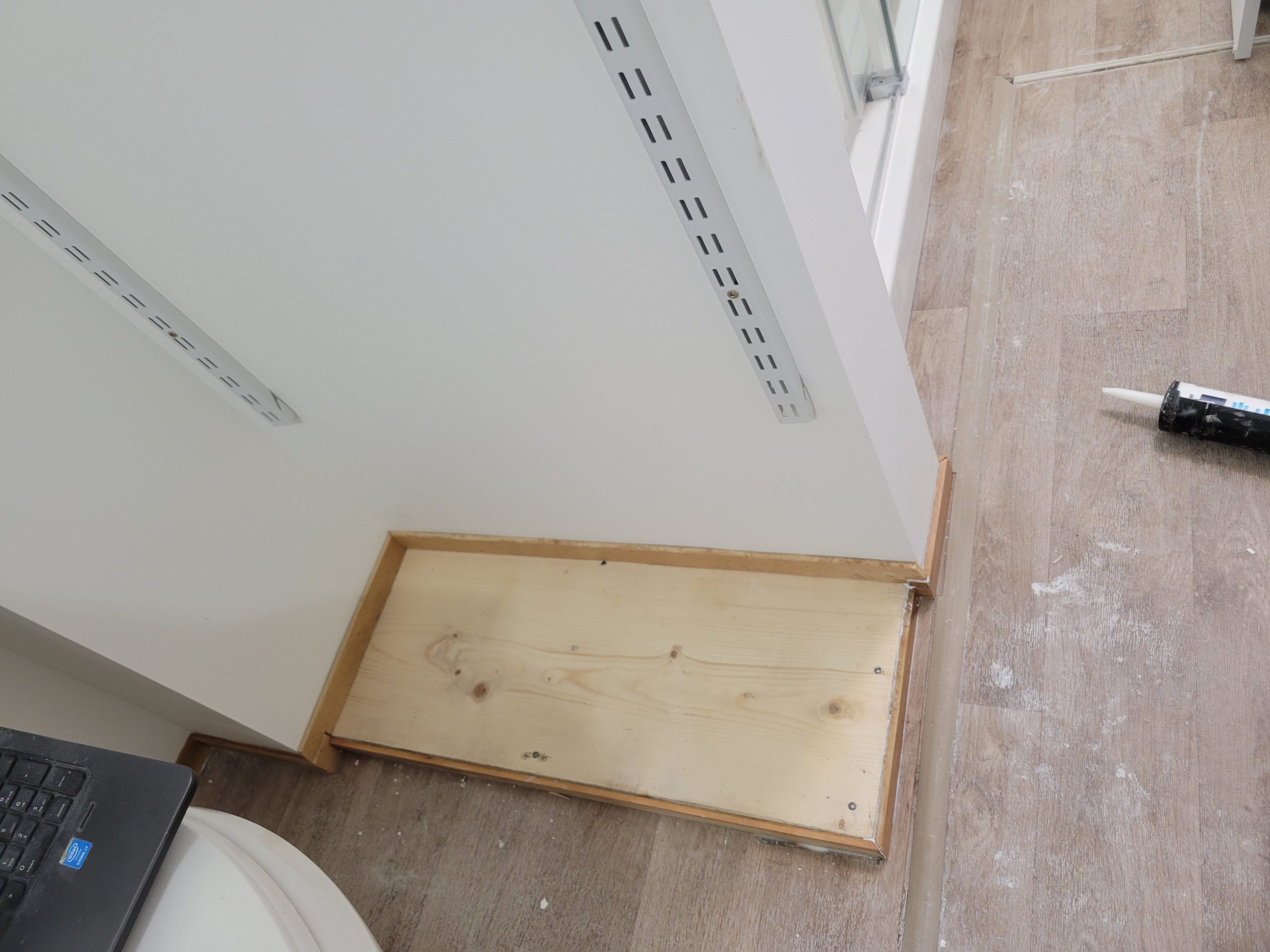

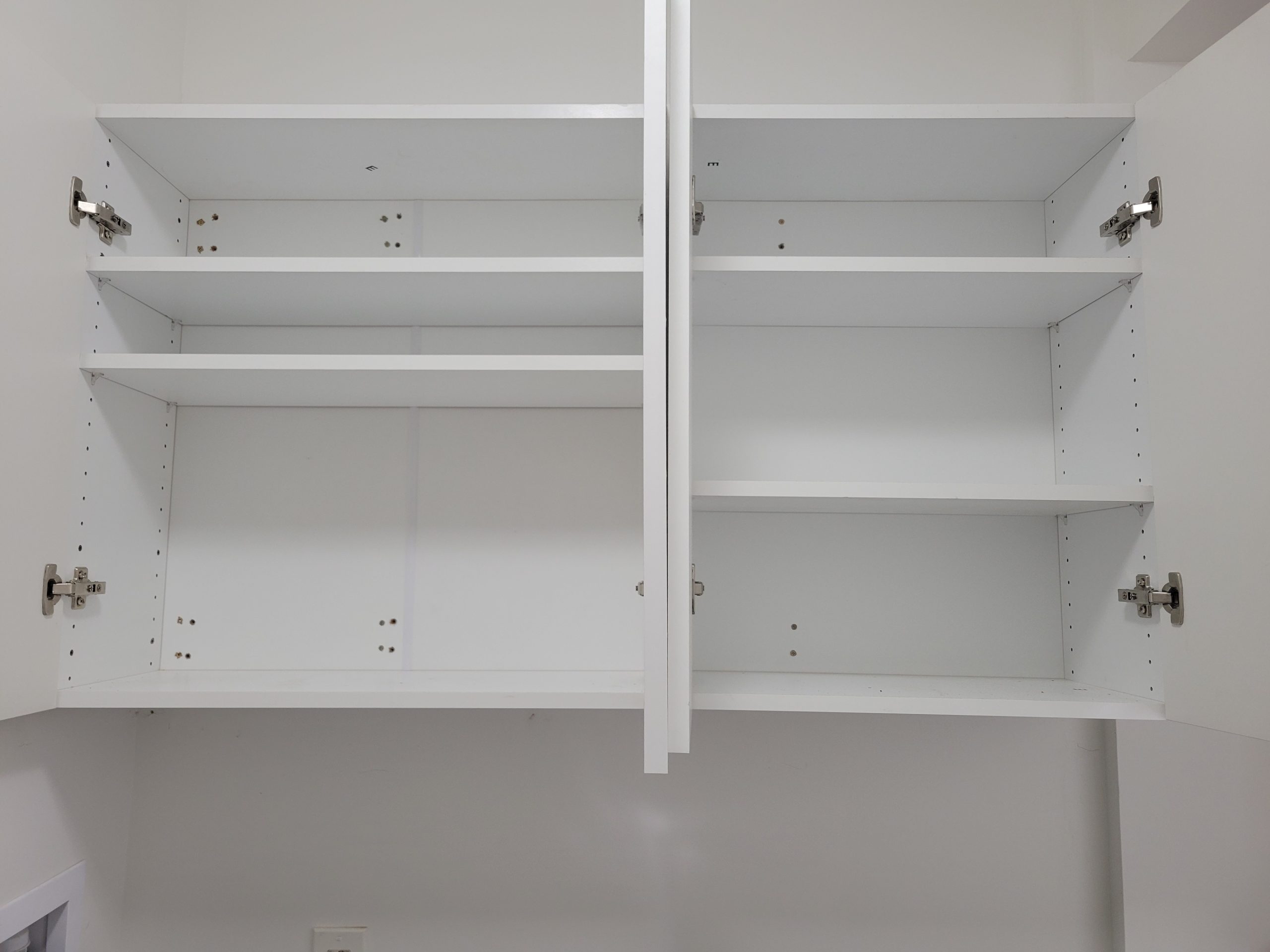

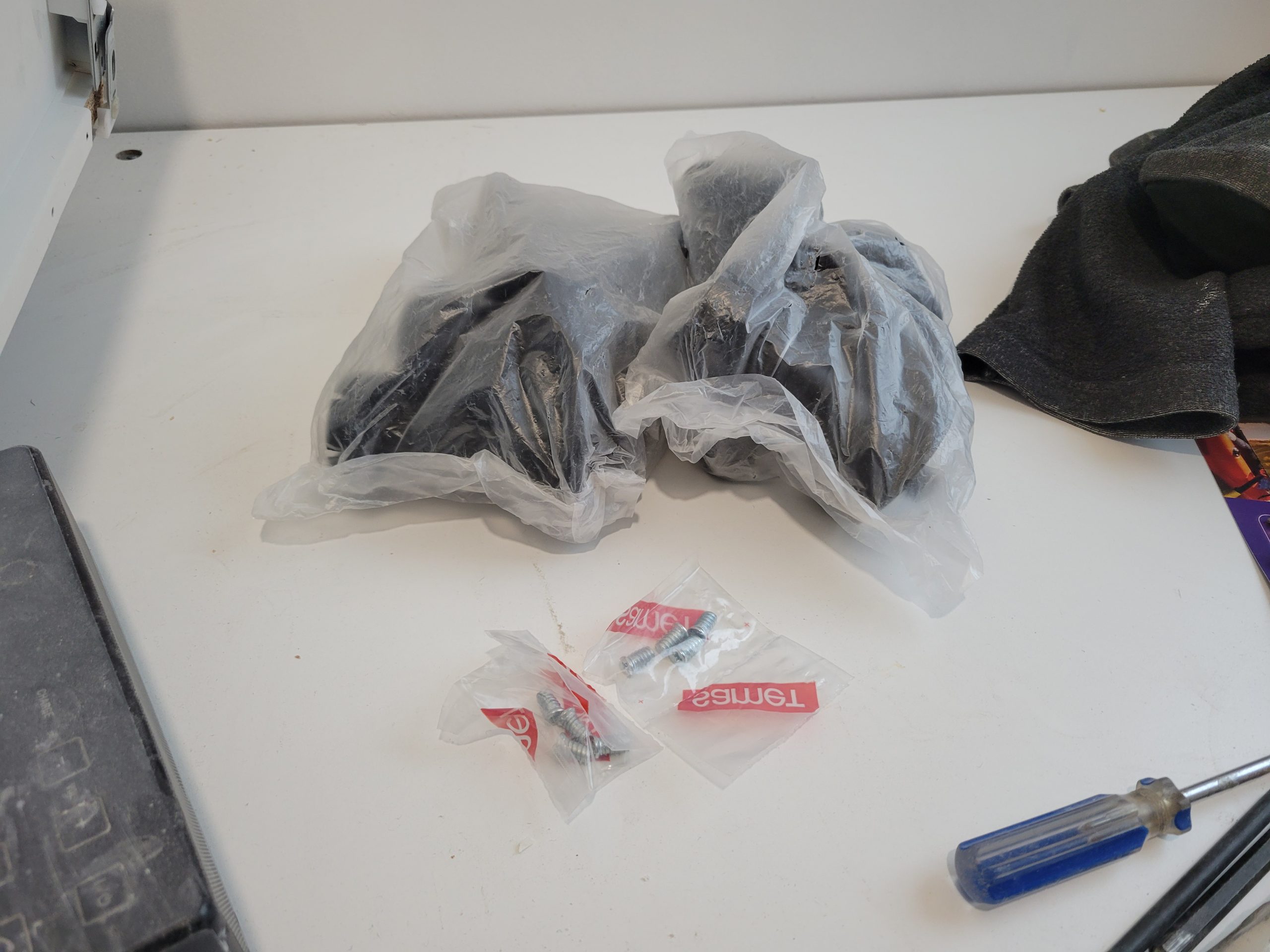

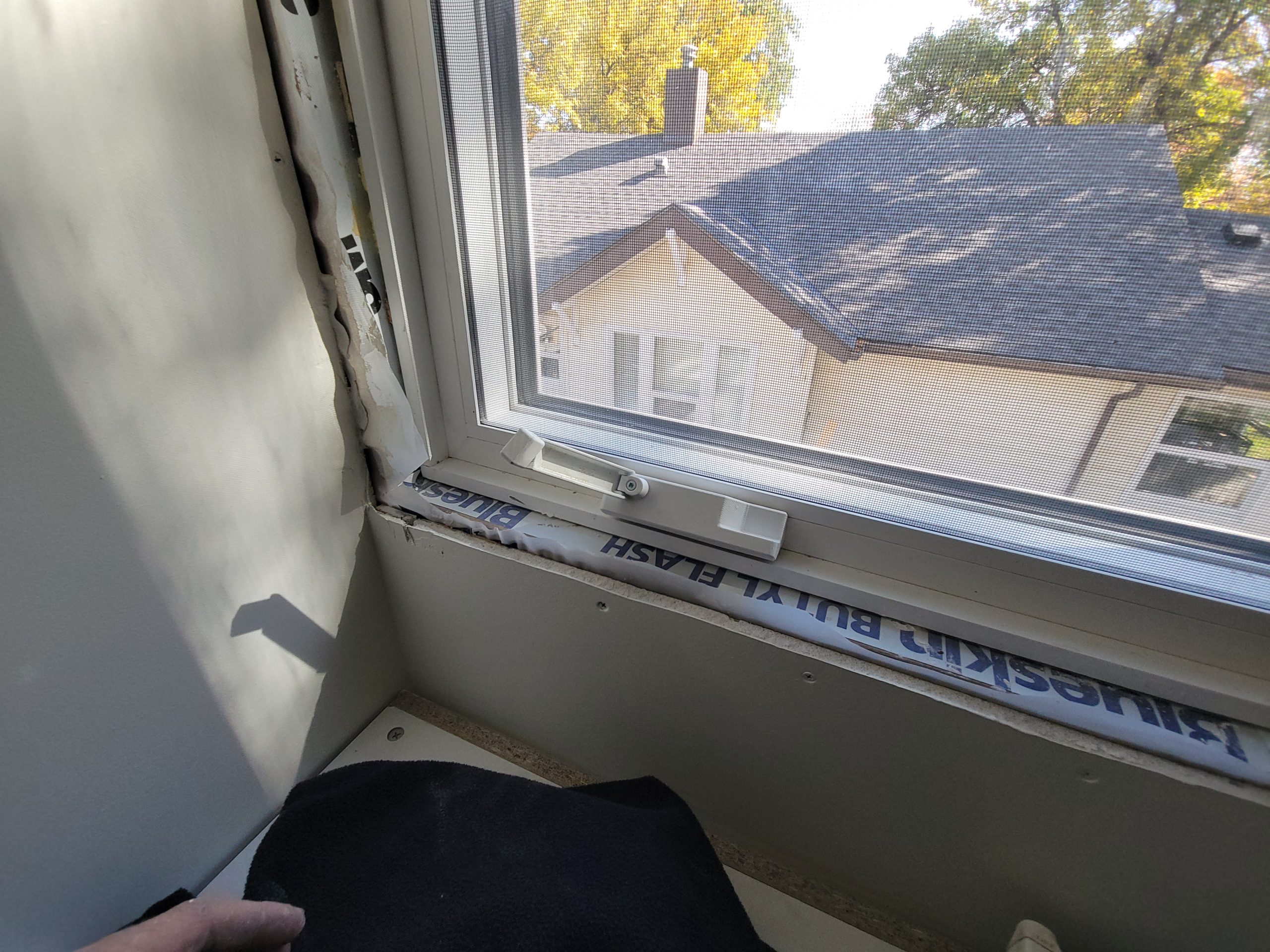

The laundry and toilet shelves were mounted with some more-correct screws.  The wide part of the brackets have a sleeve built into it, which guides the screw at the appropriate angle and allows for a screw shorter than the whole width of the bracket.  I didn’t know that until fiddling with it (or should I say screwing around with it).

Read more

rooms complete (except kitchen)

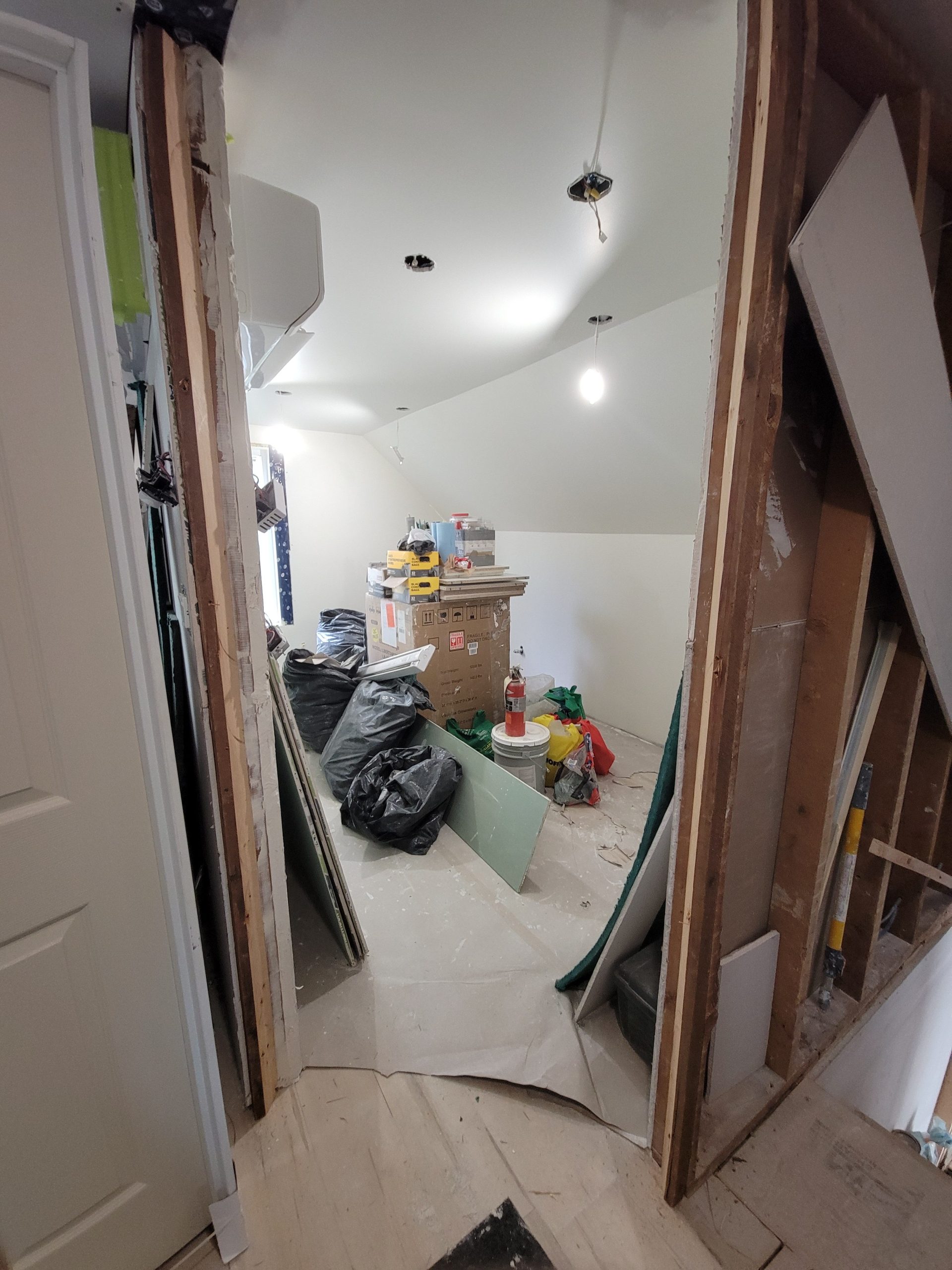

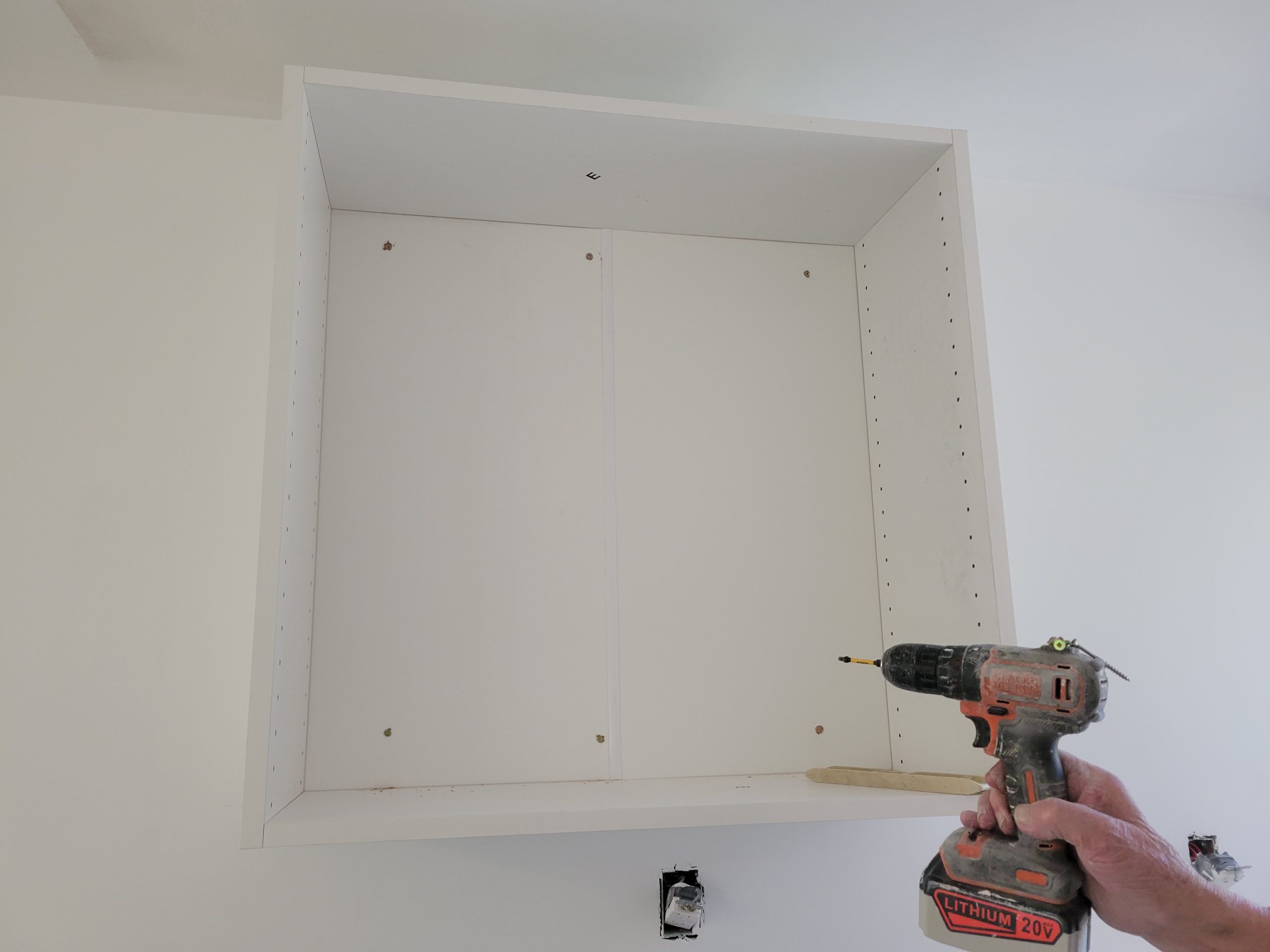

The main floor suite (P1a) is nearly complete.  All rooms have been (mostly) done except the kitchen.  It is still a disaster.  Here is what must be done today:

  • put up BR1 ceiling boards
  • remove nails from BR2 ceiling

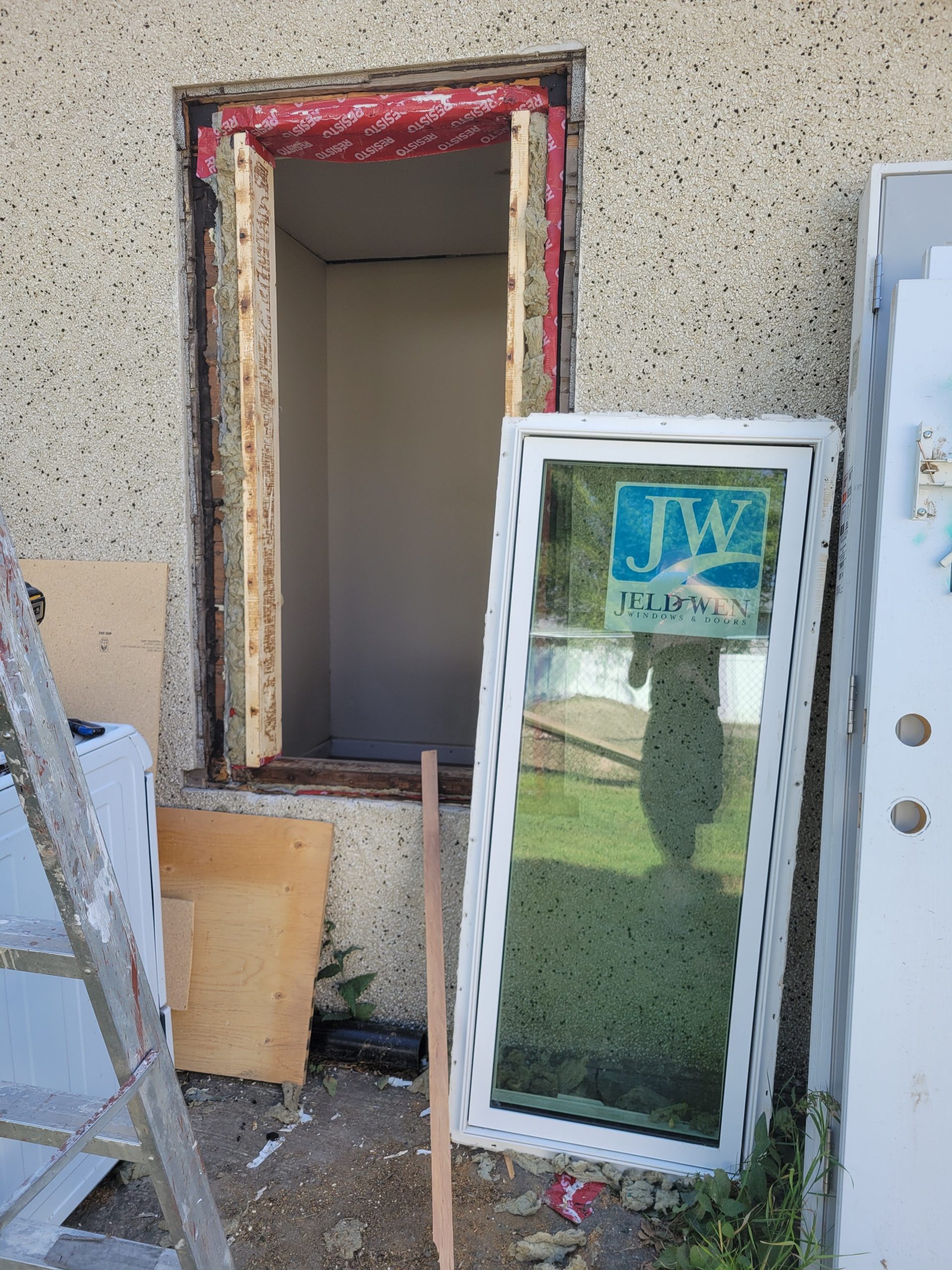

  • cut blind, hang in BR3
  • spot clean bathroom floor
  • buy laundry shelf hangers, add remaining shelves

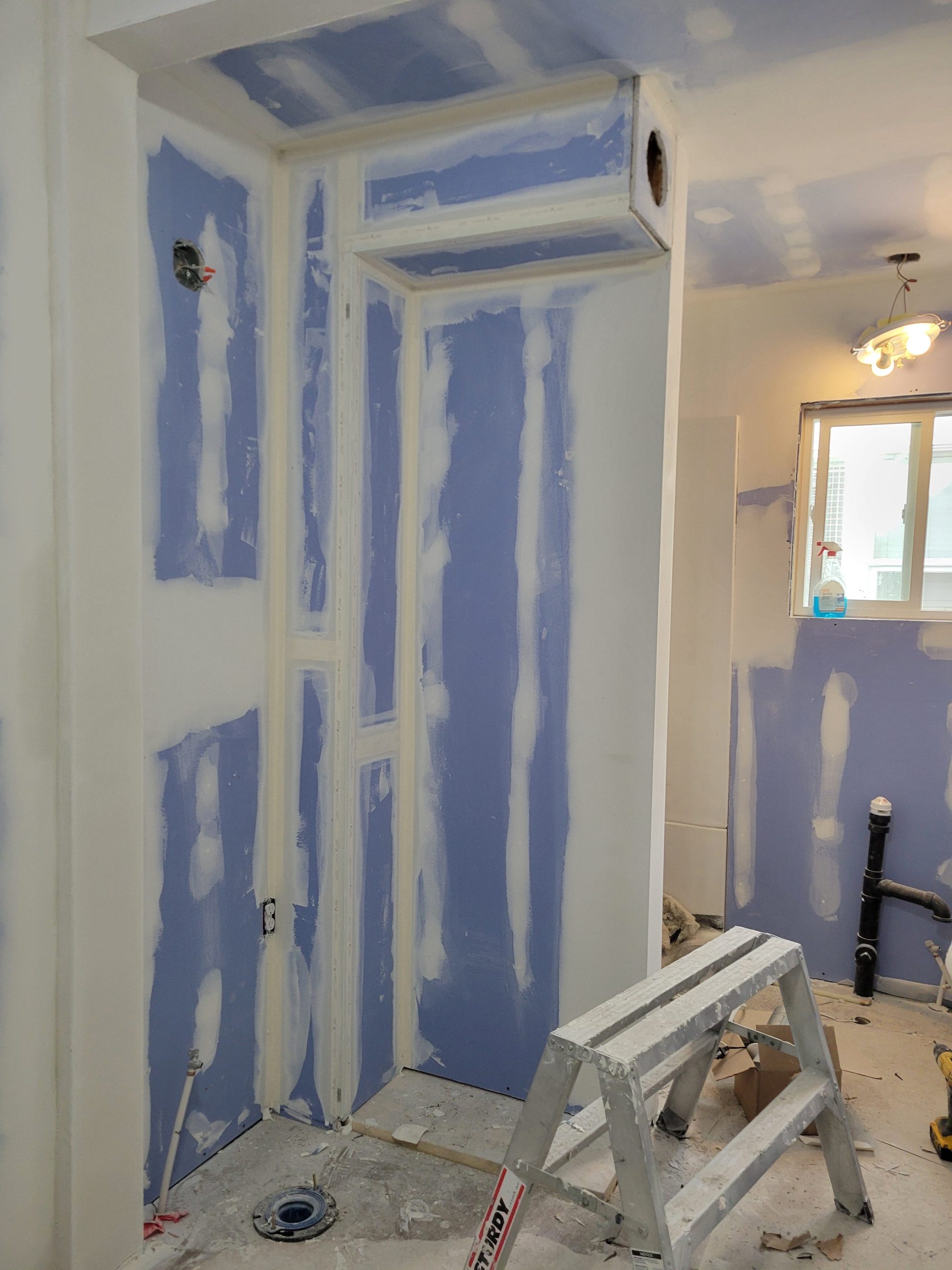

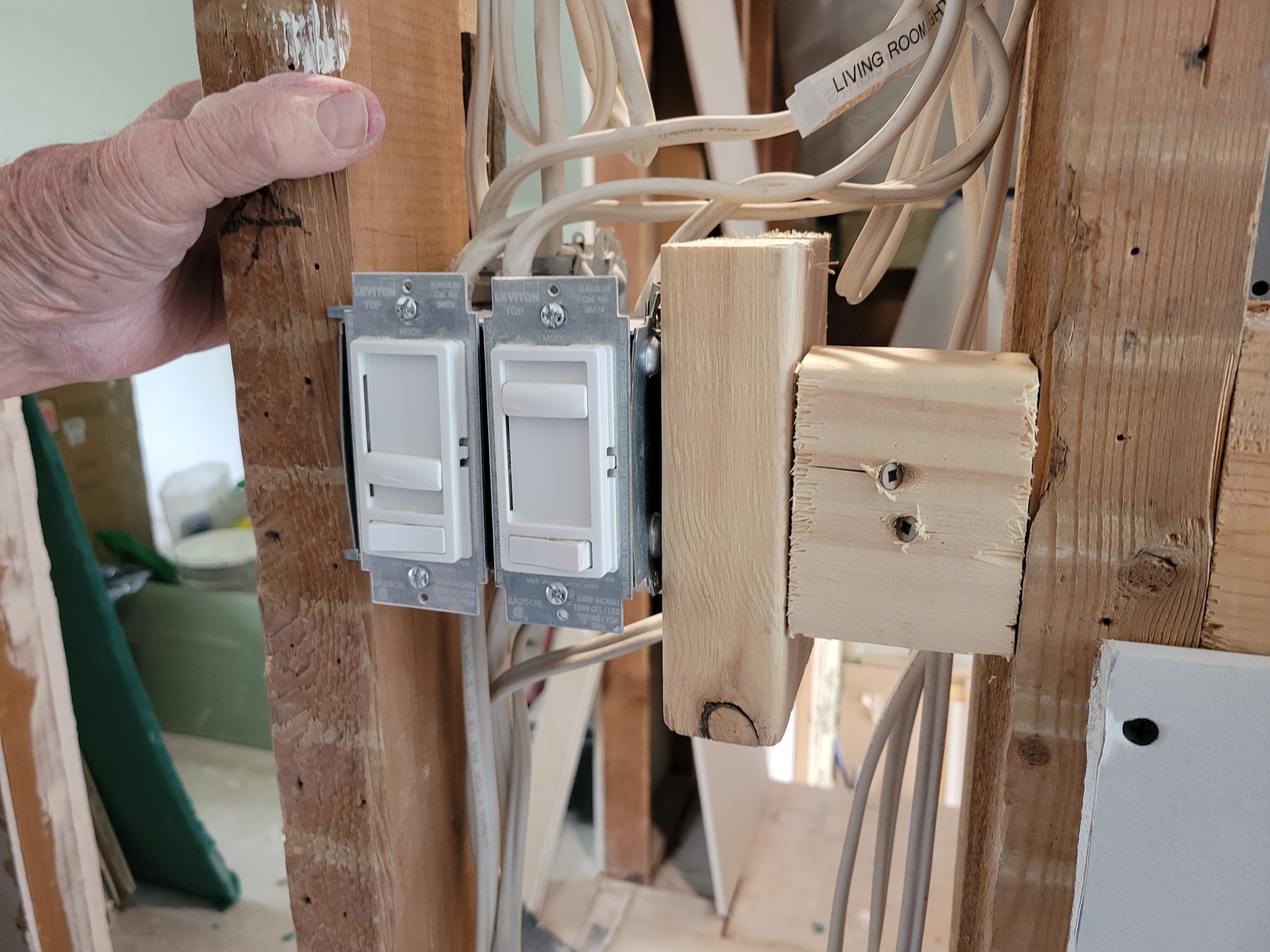

  • install electrical panel covers

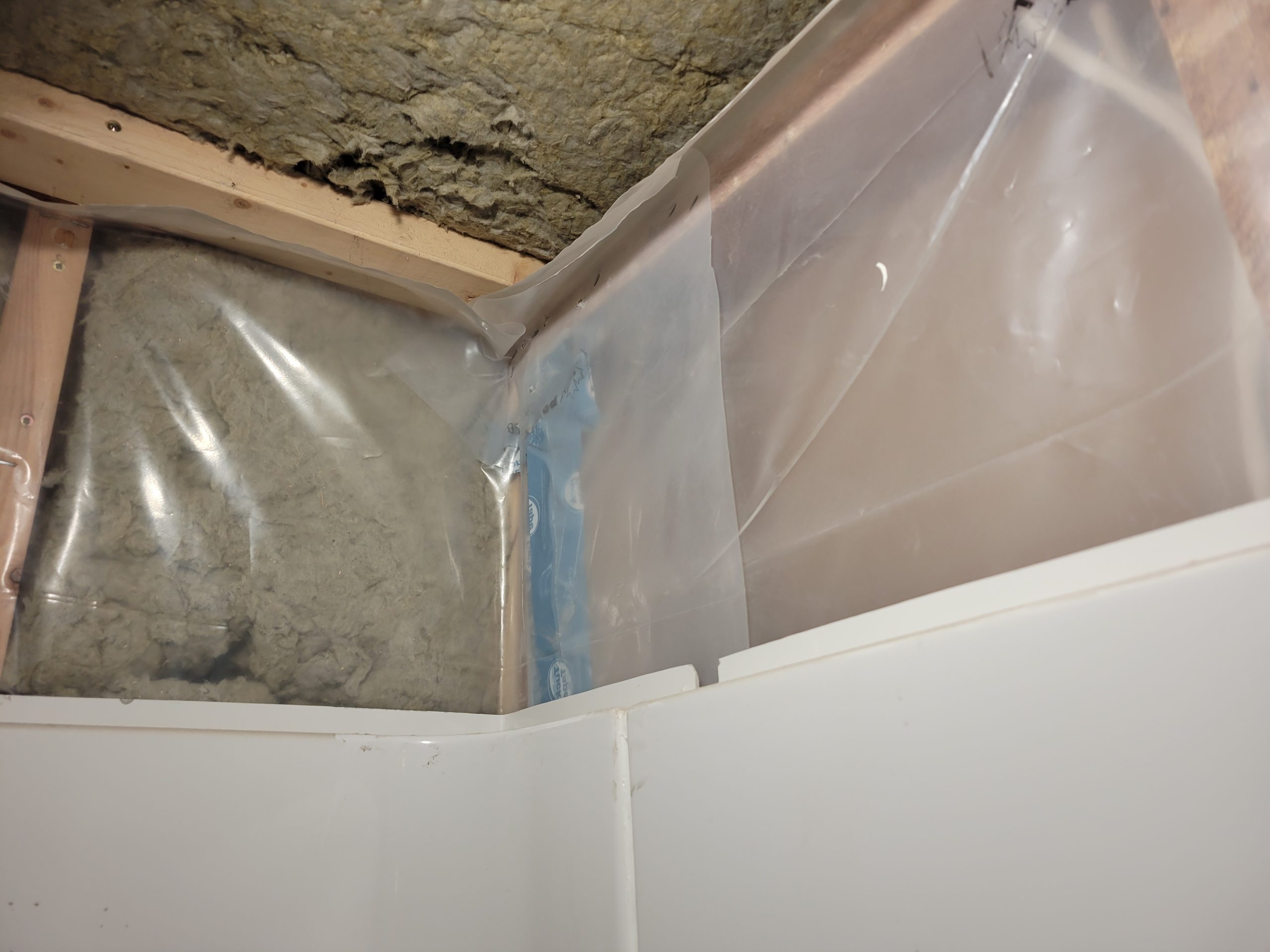

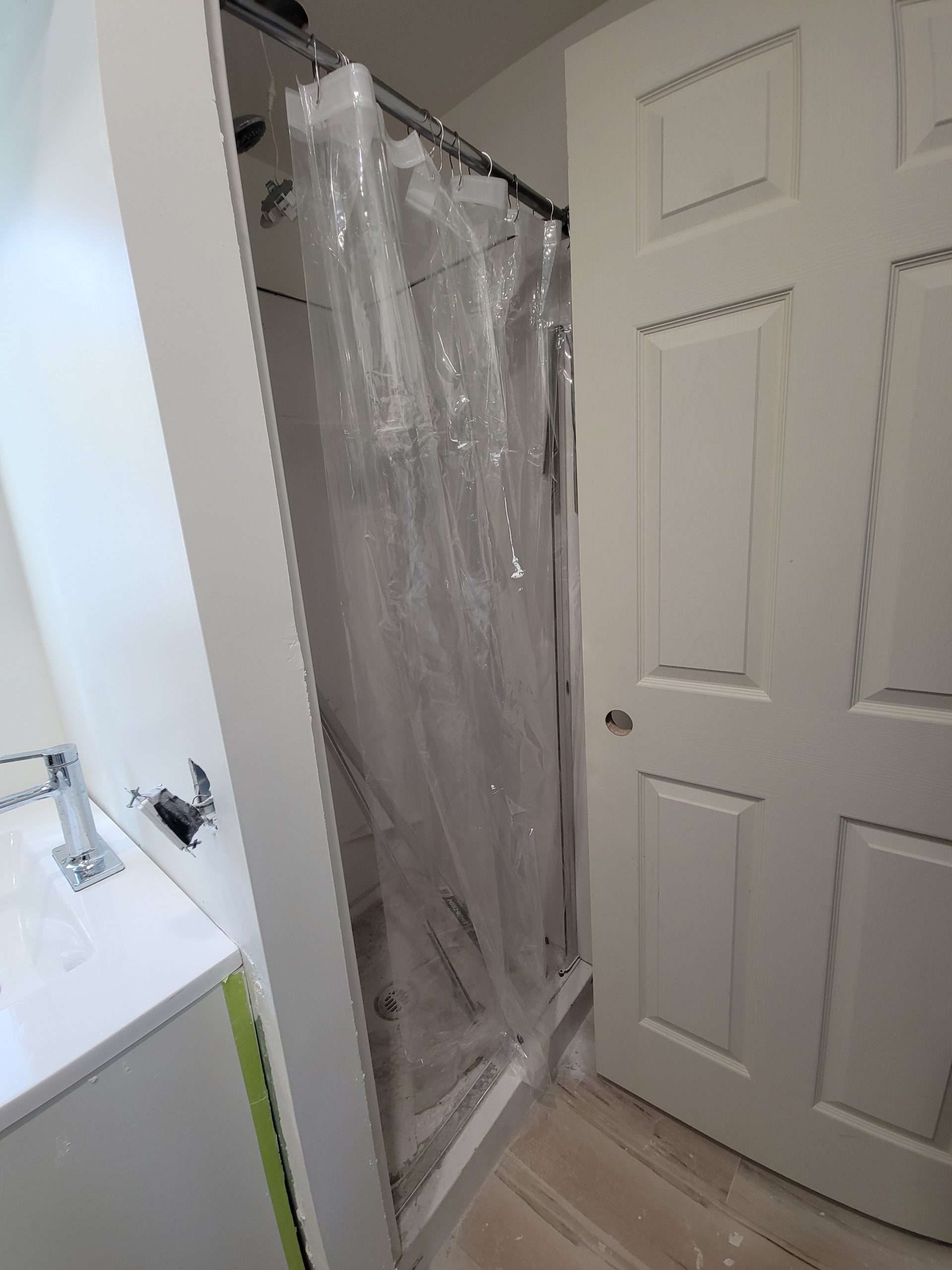

  • clean shower
  • add stick to bathroom window

The tenant asked about curtains.  I told them there are blackout blinds in the bedrooms and daylight blinds in the rest.  The bathroom window has privacy film.

Read more

mostly cleaning

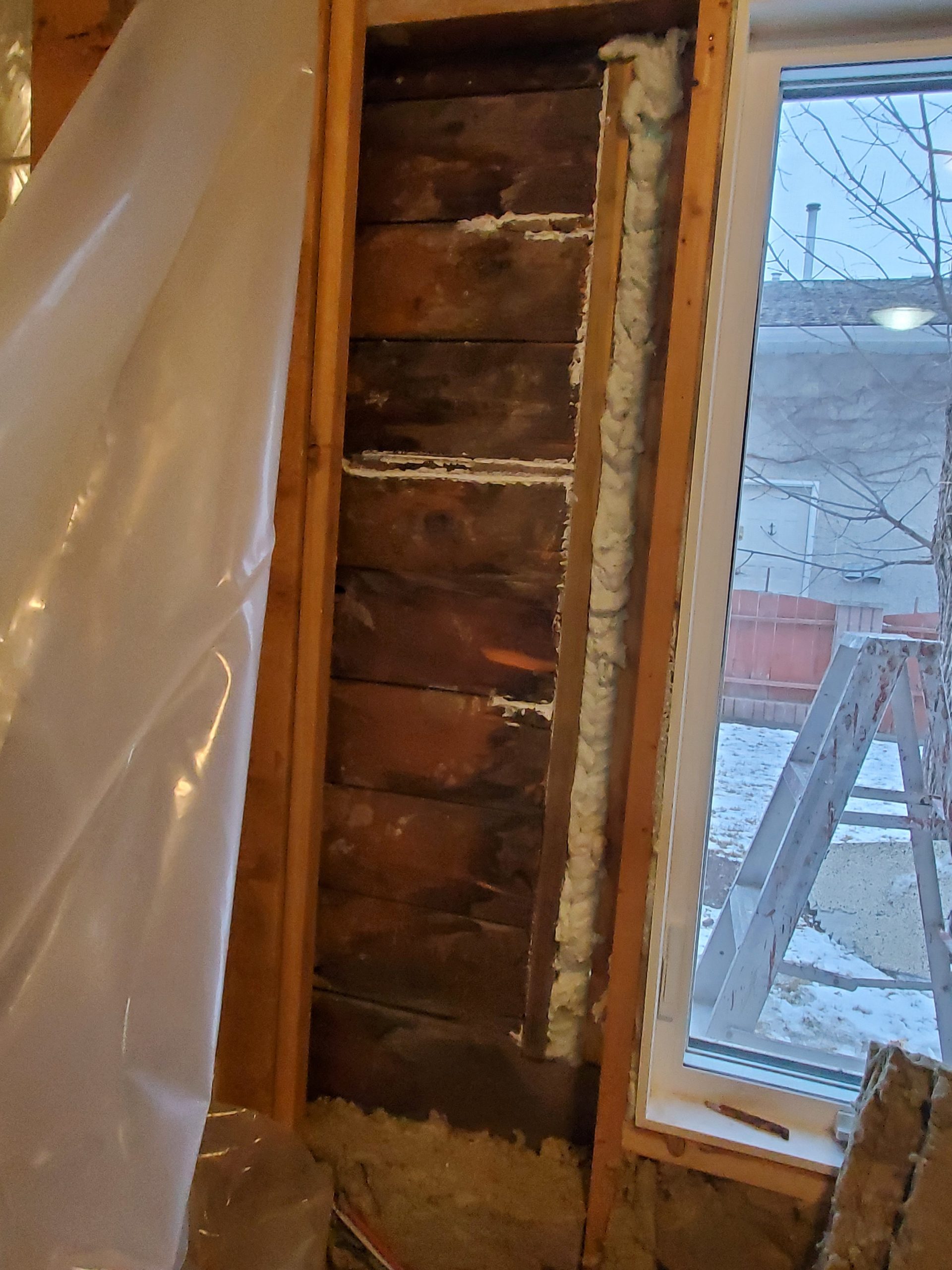

Mostly cleaning today – scrubbing the floor of paint, drywall, glues, spray foam insulation, epoxy, etc.

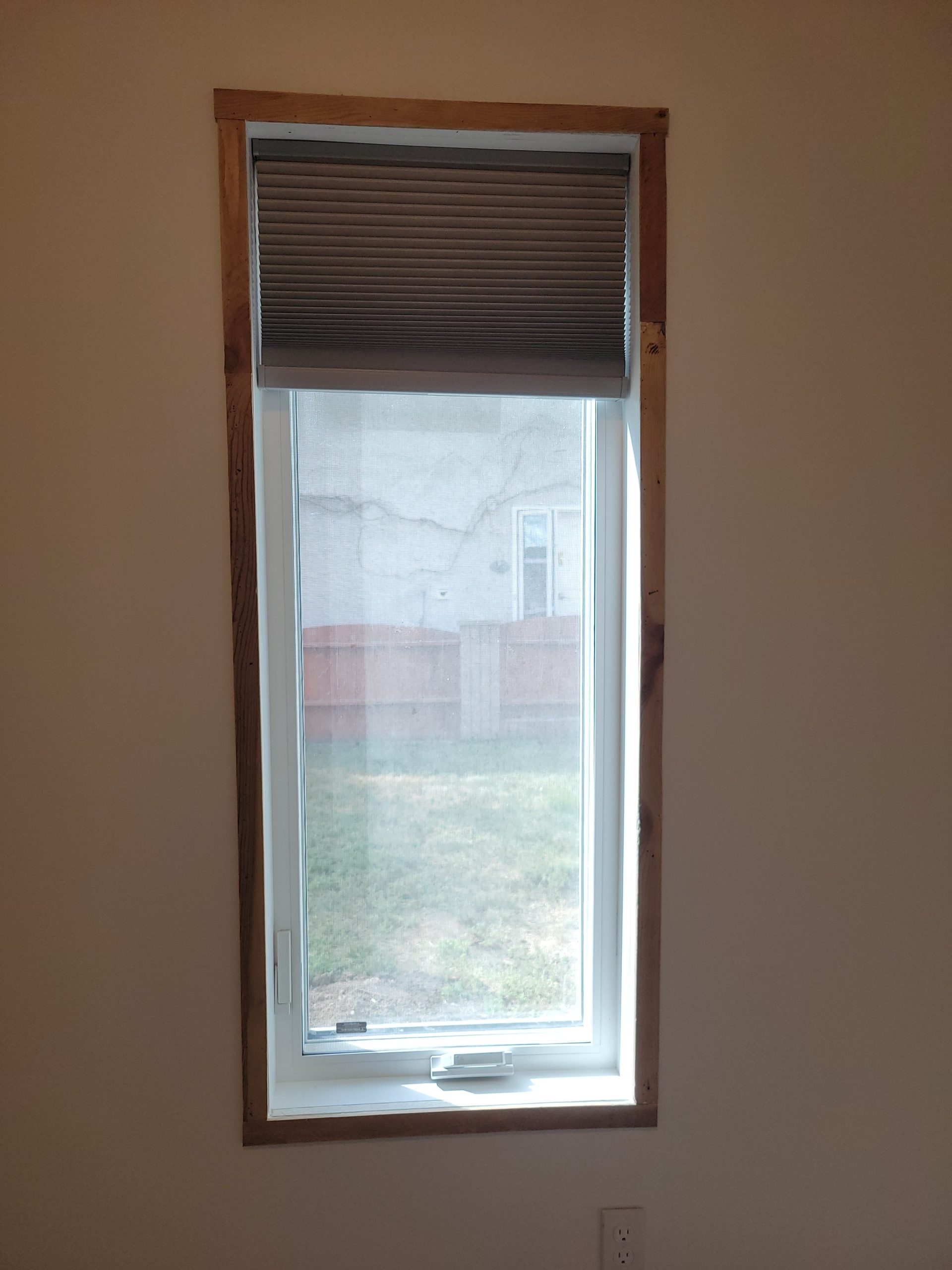

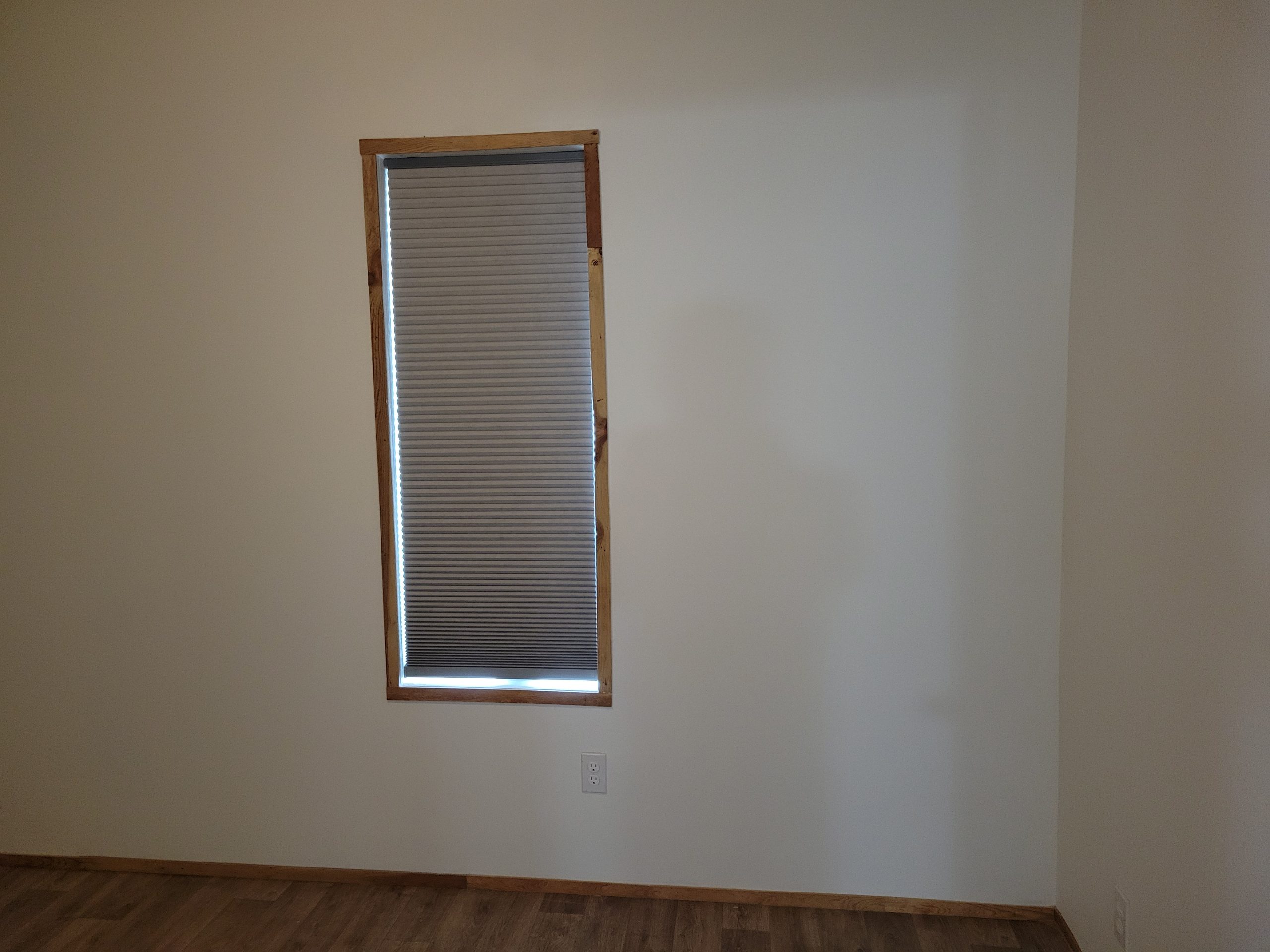

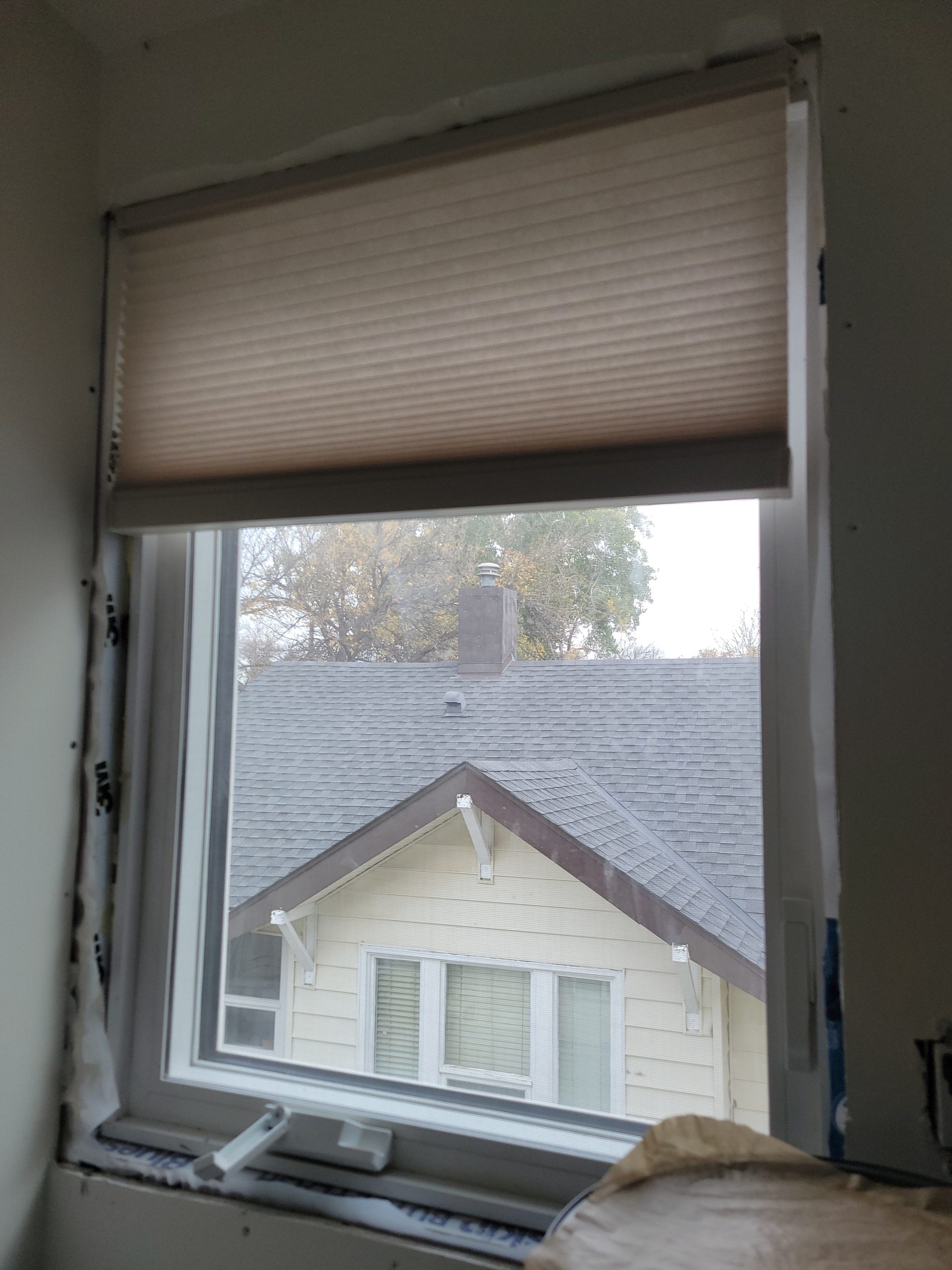

I put up the first blind, in bedroom 1…

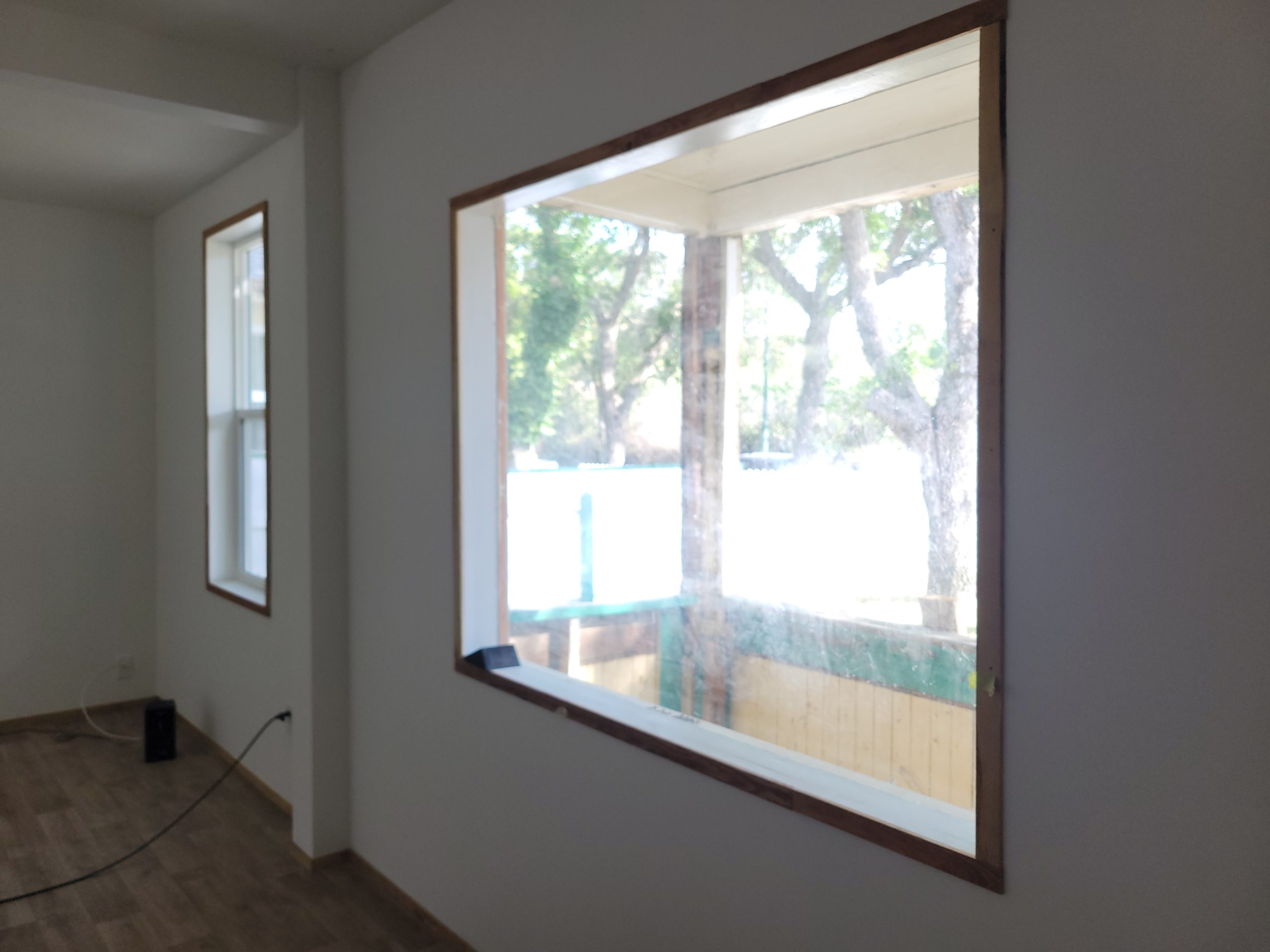

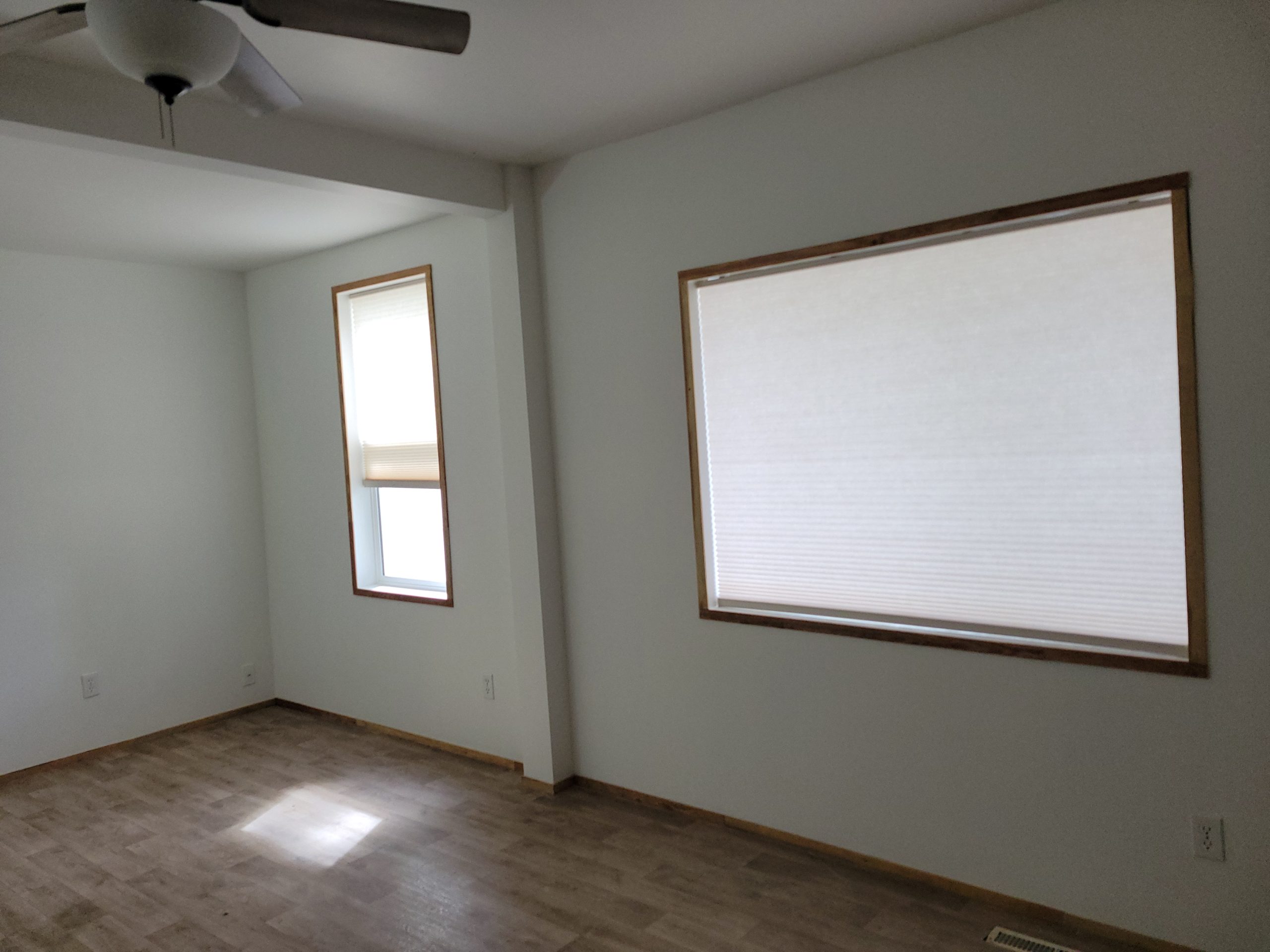

…and cleaned the paint off the large living room window.

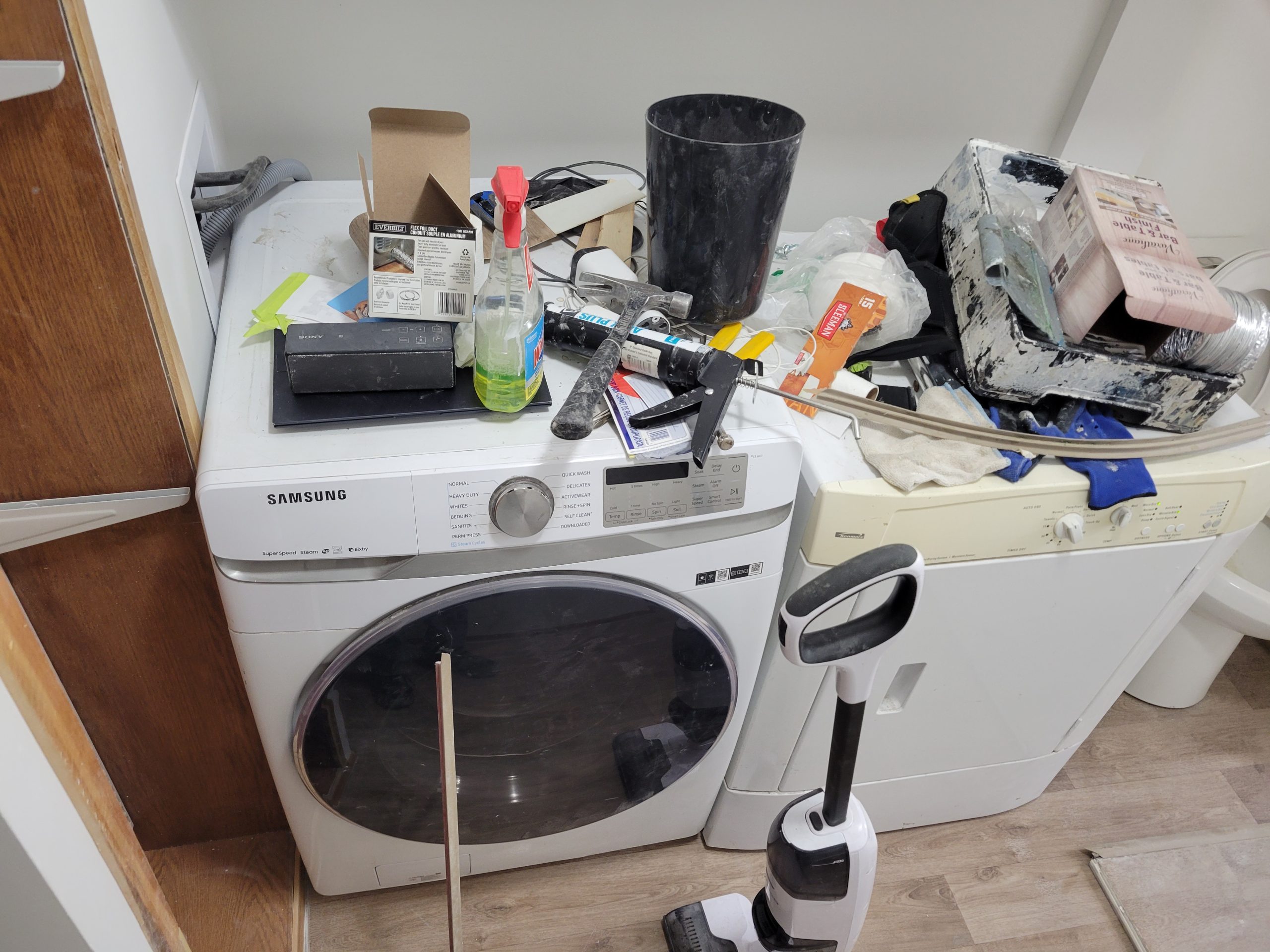

I’m still using flat surfaces as storage facilities.

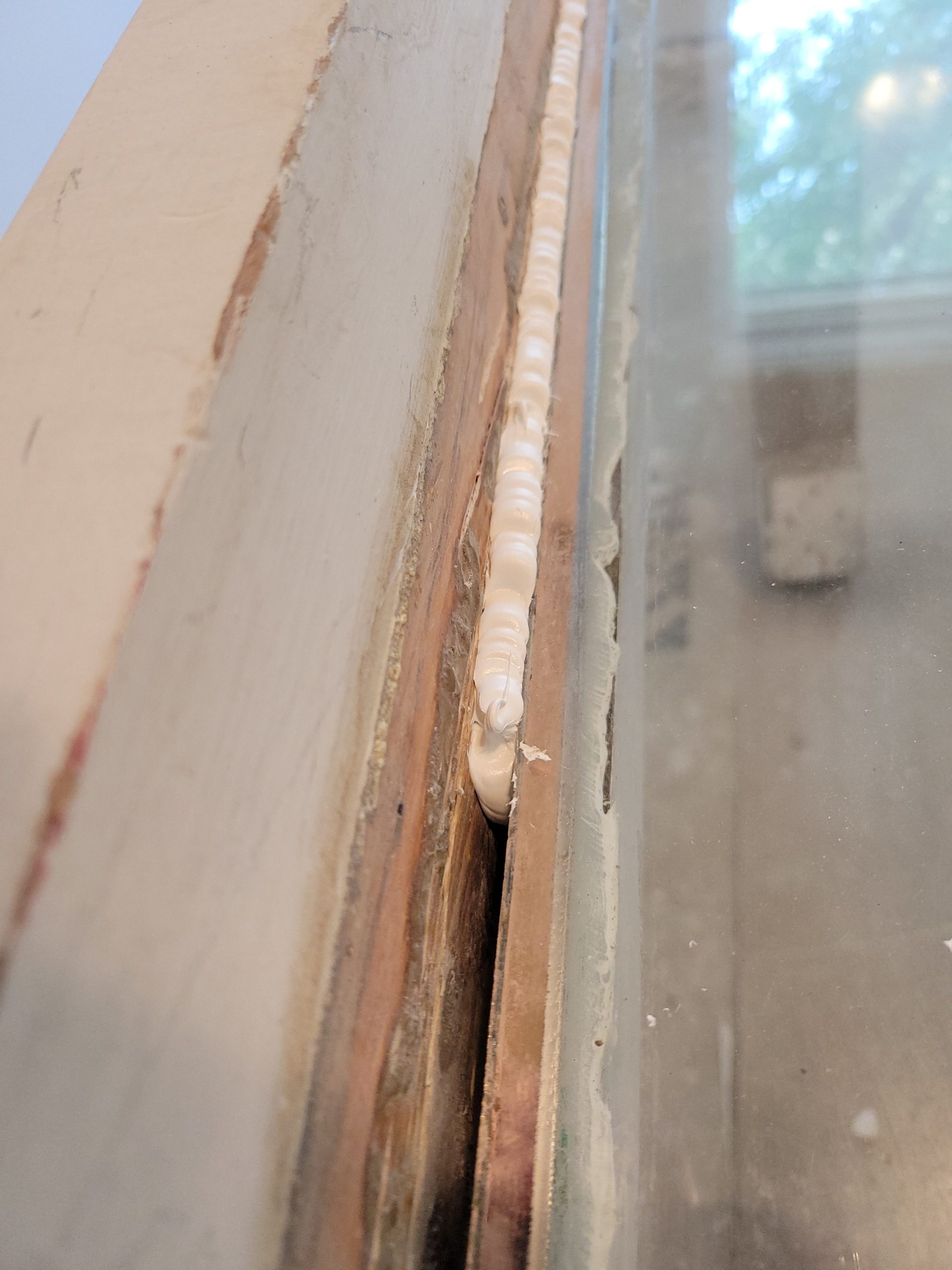

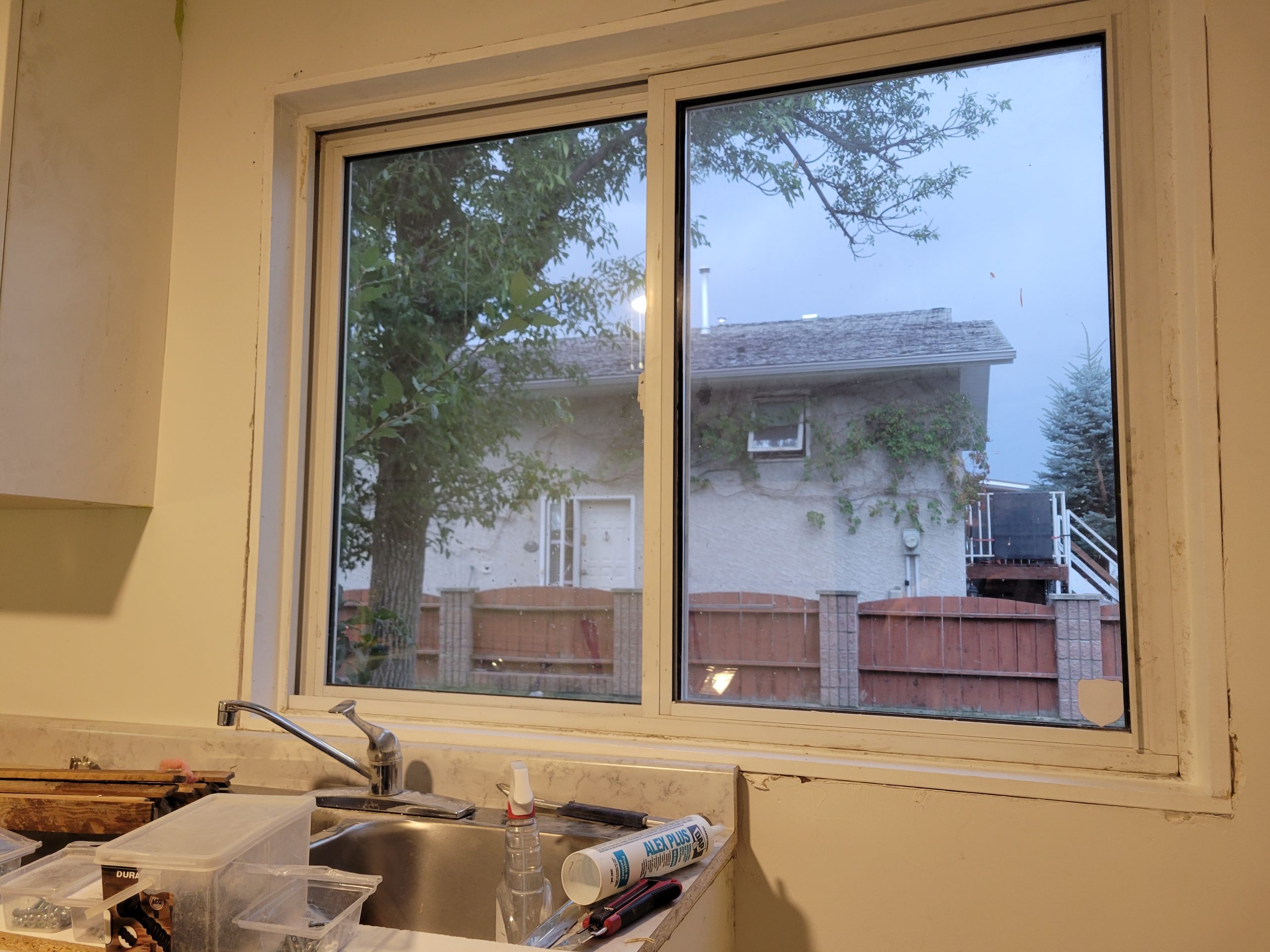

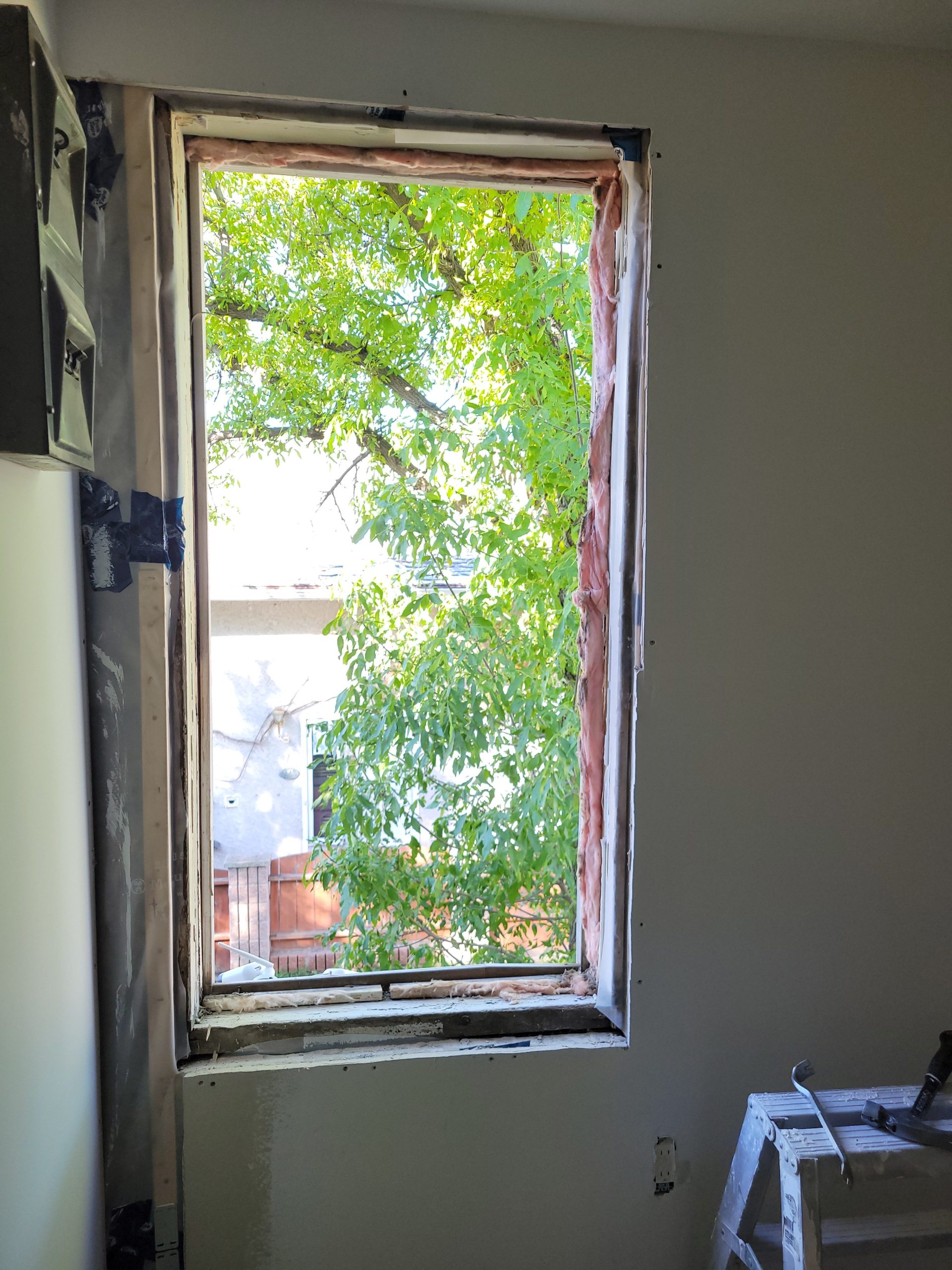

The kitchen window was framed in with painted 1x4s.

Lots to do.  More later.
