electrical upgrades to code

The inspector was by today, looking at the work previously done and, thankfully, on the same permit, did a rough-in inspection.  He was quite an agreeable fellow, addressing all my questions.  So was Ryley, the electrician from Passey Electric.  He found some deficiencies.

  • Sep 11/2026 10:10AM (KEN) ROUGH IN: Range box and dryer box needs to have a second support. KF
  • Sep 11/2026 10:11AM (KEN) ROUGH IN: Plug in kitchen area should be taken out on opposite side of panel. KF
  • Sep 11/2026 10:13AM (KEN) ROUGH IN: Rough in of the upper unit was inspected with noted deficiencies. KF
  • Sep 11/2026 10:15AM (KEN) ROUGH IN: 3 heat pumps and 2 baseboard heaters are being installed. KF
  • Sep 11/2026 10:16AM (KEN) ROUGH IN: Fire alarm cable going downstairs to be completed. KF
  • Sep 11/2026 10:05AM (KEN) ROUGH IN: DEFICIENCY: Rule 12-3010 (2) – Gangable boxes require a second support between studs ( could be factory boxes2 gang)
  • Sep 11/2026 9:58AM (KEN) ROUGH IN: DEFICIENCY: Rule 12-516 – Protection plates required where wire is run less than 32 mm from edge of stud (throughout)

Along with that…

  • The 15-15A space-saver breaker I put in for the split simplex outlet was wrong.  Each circuit must be on a different phase.  The reason being that the neutral wire would handle 15 amps for each circuit, amounting in 30 amps.  I thought about this a few days ago and wondered how that worked.  It never occurred to me that I need a 2-pole breaker with each circuit on a different phase.  Again, Ryley is a helpful fellow.

Some of the work was done yesterday and some today.

So, here goes!

Read more

lumber in the wind

The lumber we stacked at the rear of the property did not blow down.  It was really windy last night.  I was expecting to see them stacked randomly like a bunch of t’an in a game of Kal’toh gone wrong.

rooms complete (except kitchen)

The main floor suite (P1a) is nearly complete.  All rooms have been (mostly) done except the kitchen.  It is still a disaster.  Here is what must be done today:

  • put up BR1 ceiling boards
  • remove nails from BR2 ceiling
  • cut blind, hang in BR3
  • spot clean bathroom floor
  • buy laundry shelf hangers, add remaining shelves
  • install electrical panel covers
  • clean shower
  • add stick to bathroom window

The tenant asked about curtains.  I told them there are blackout blinds in the bedrooms and daylight blinds in the rest.  The bathroom window has privacy film.

Read more

mostly cleaning

Mostly cleaning today – scrubbing the floor of paint, drywall, glues, spray foam insulation, epoxy, etc.

I put up the first blind, in bedroom 1…

…and cleaned the paint off the large living room window.

I’m still using flat surfaces as storage facilities.

The kitchen window was framed in with painted 1x4s.

Lots to do.  More later.

last day of work, cleanup

Being the last day of work before the tenant shows up, it was the final push.  Not everything was done.

I knew that there wouldn’t be enough trim boards, so I urethaned a bunch more.  The work area:

Floyd came by as I was urethaning.  (Is that a word?)

The living room trim was complete.  The patch piece still needs seam seal.

Read more

2nd last day of work

Various things were done today.  It is my 2nd last day before the tenant moves in.

I rehung the laundry cabinets as they were a little lopsided and put in the shelving.

Dave was by early, and we discussed how to paint the door.  I began outside, but the wind carried some dust, so inside it went.

Read more

flooring, door trim, laundry cabs

Outside work had to be done before anything inside, but we did get started.

When we got back, we began work on the list.  I think there are now 40 or so items on the list to complete.

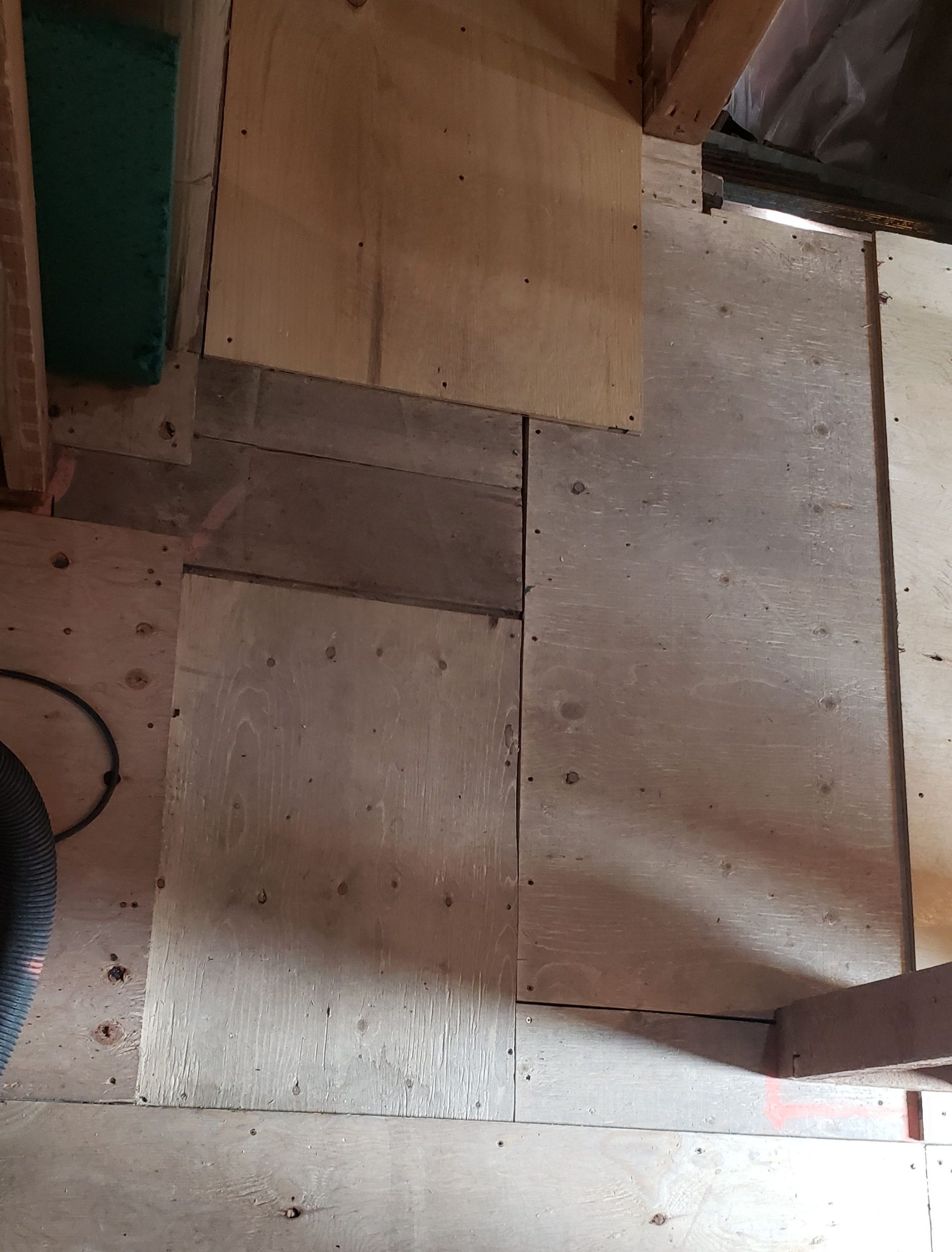

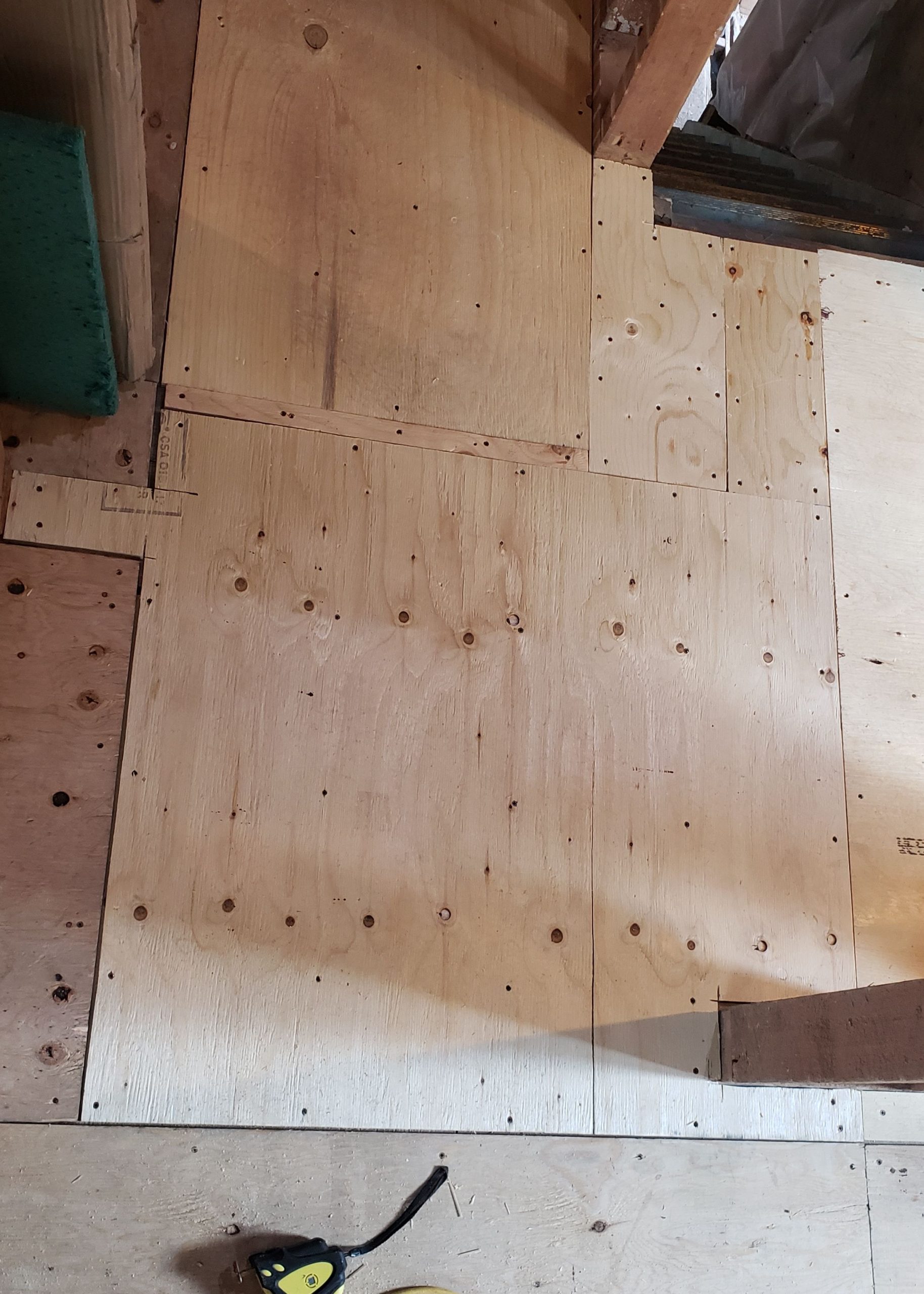

The floor levelling compound was dry, so I cut a piece of proboard to fit, mixed another batch, and filled the gaps and cracks.  I’ll glue the flooring down tomorrow.

Read more

road crush, gravel in walkway

The walkway for the main suite has finally gotten its load of gravel brought in.

It took about 45 minutes to unload.

More gravel is needed at the east end of the walkway, but at least the tenants don’t have to walk in the mud while work at 1403 is being done.
